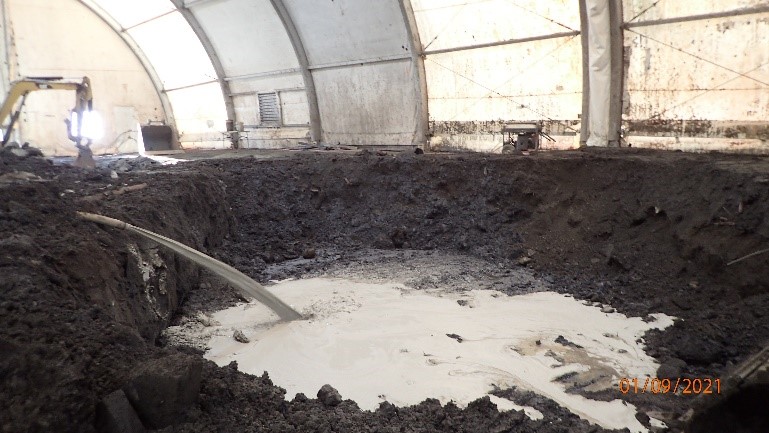

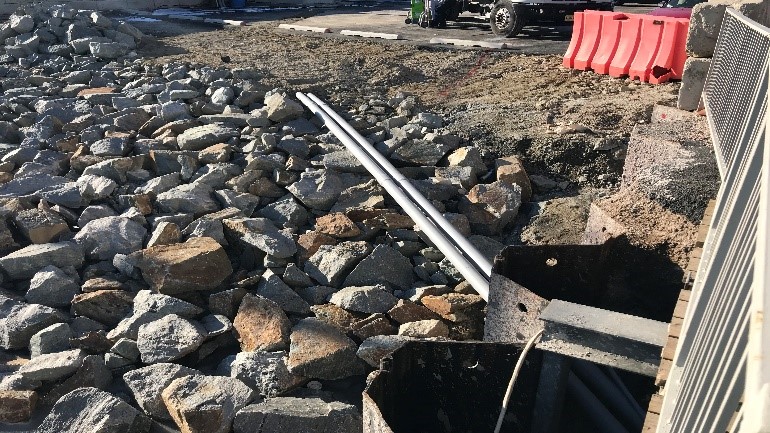

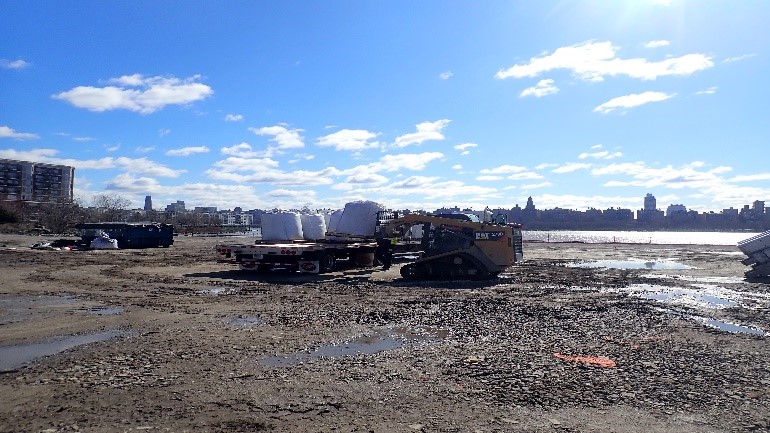

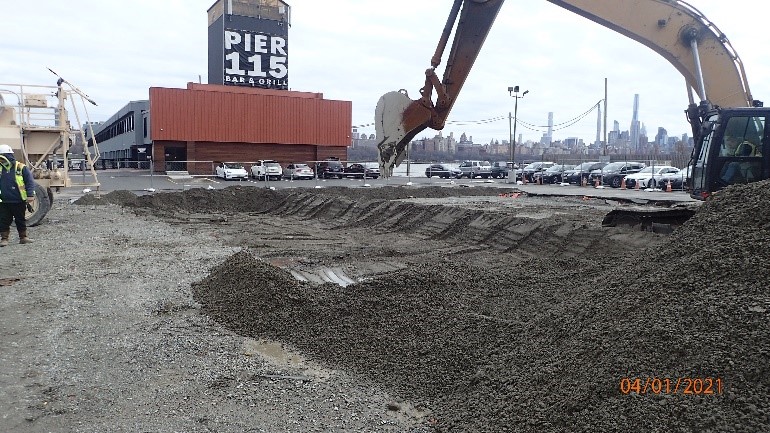

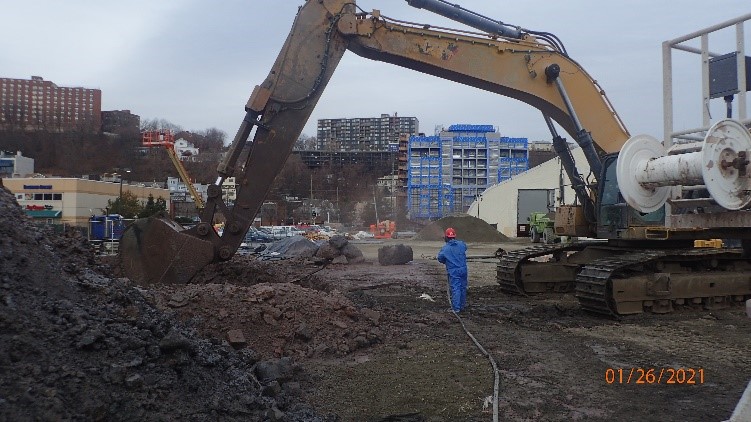

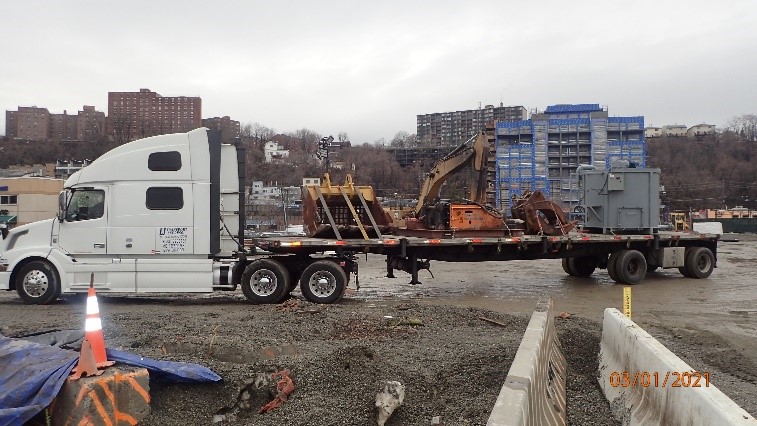

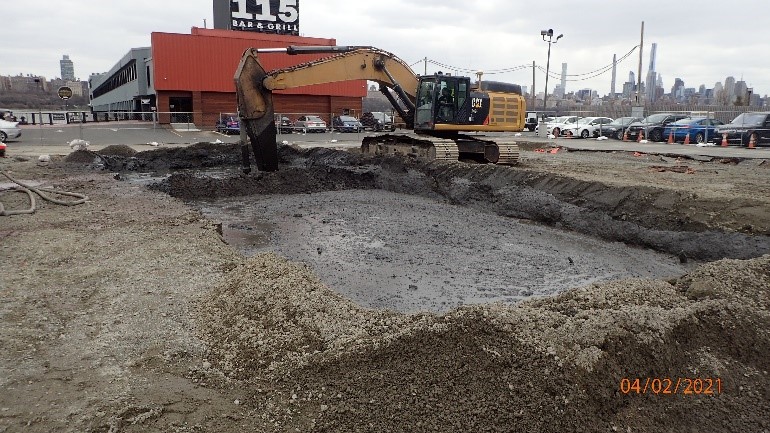

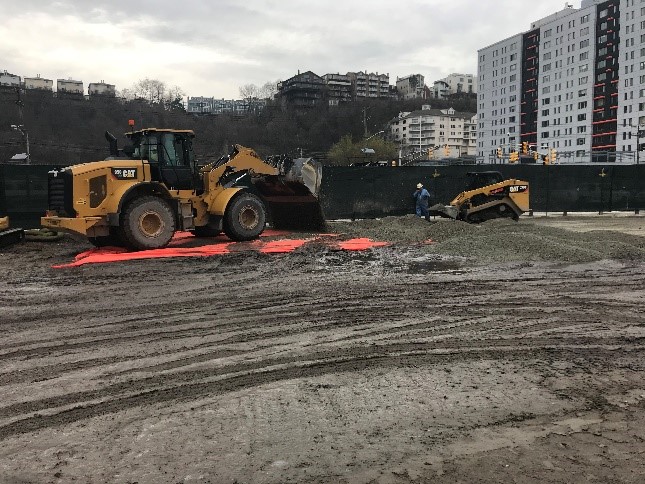

April 2021 - Remixing in Central Area

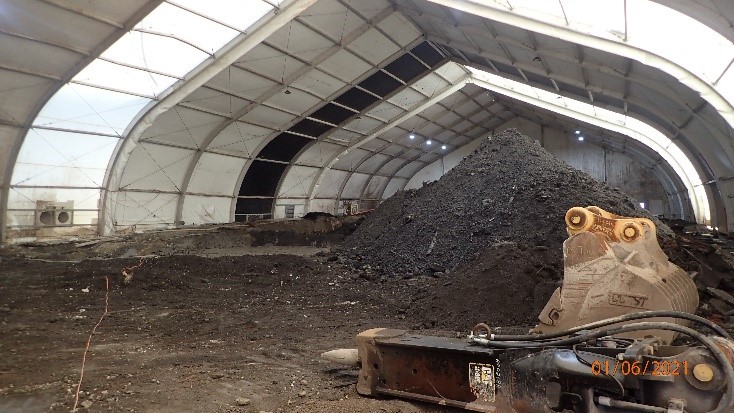

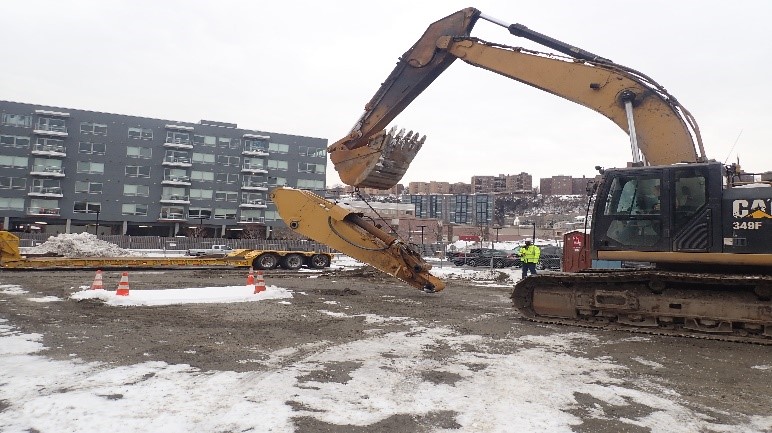

April 2021 - Temporary Gravel Cap Removal in Central Area

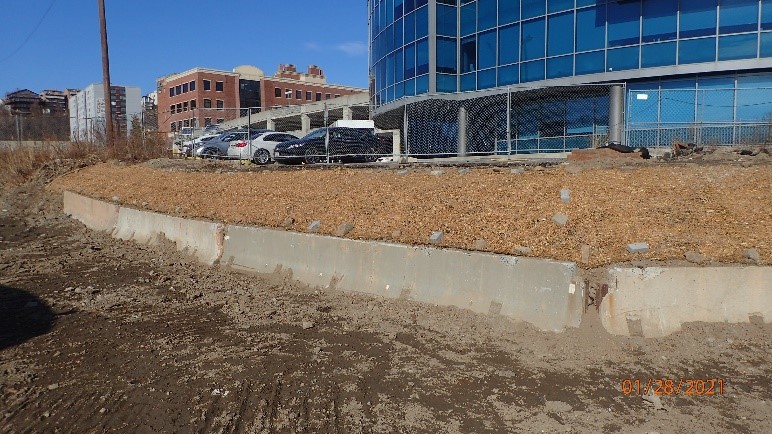

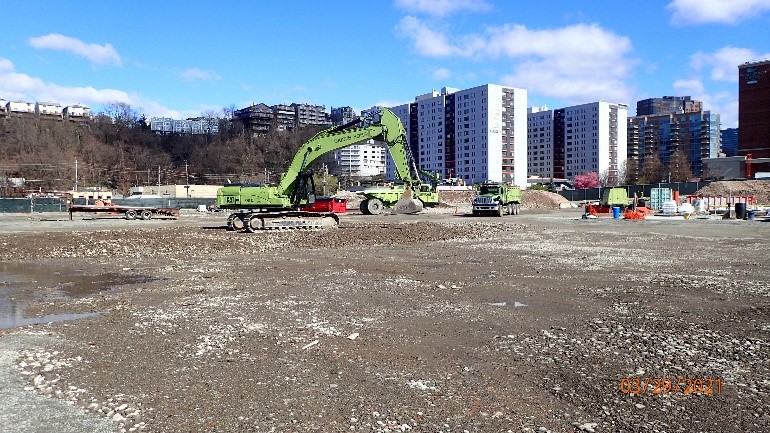

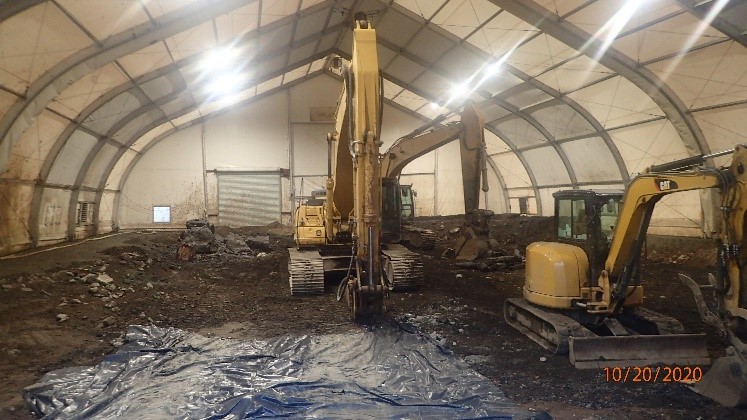

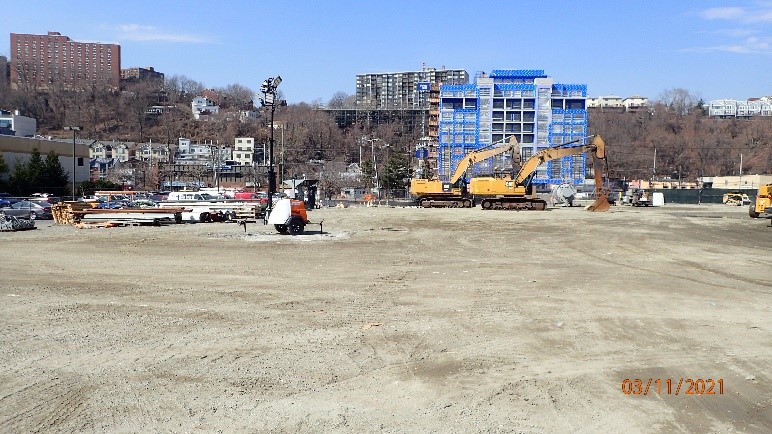

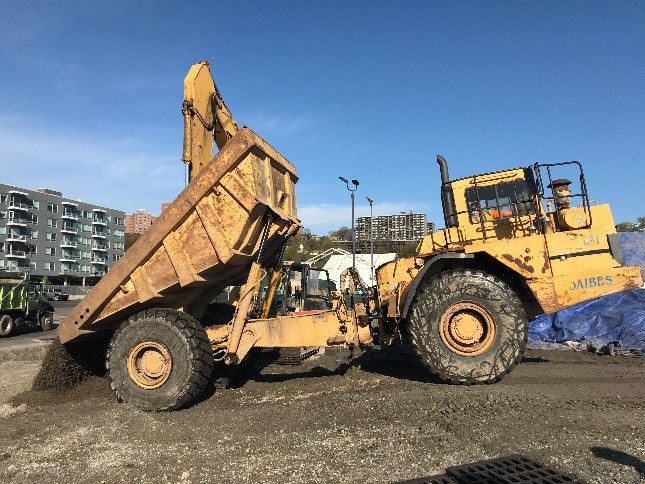

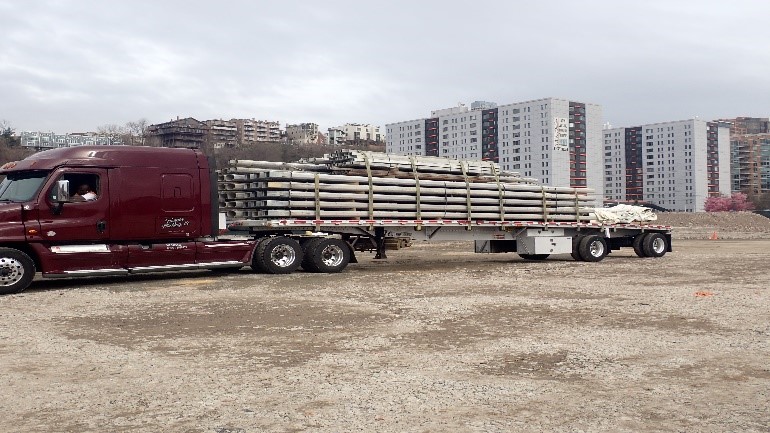

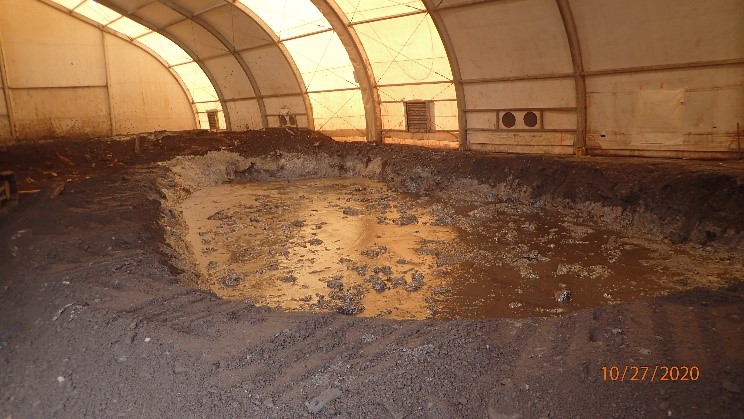

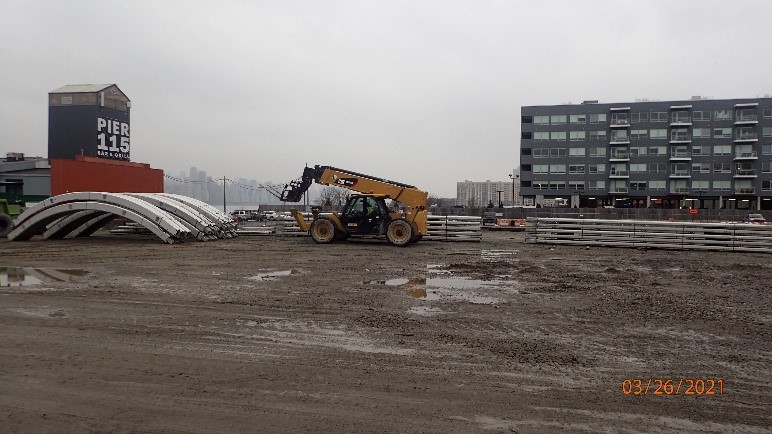

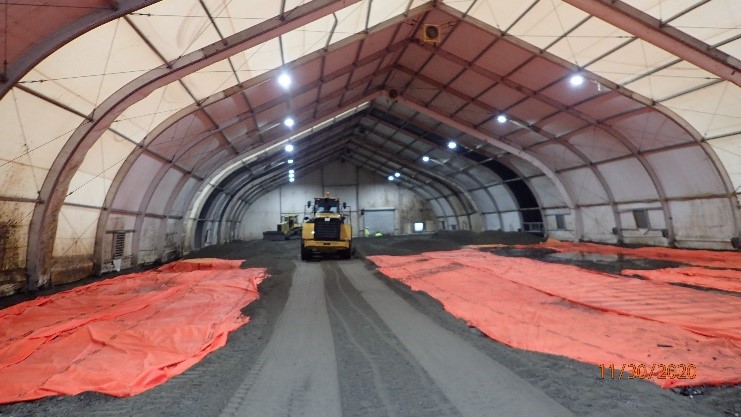

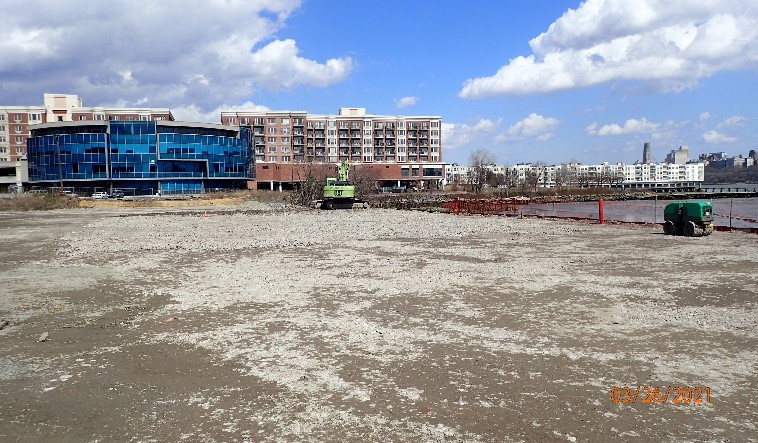

April 2021 - Final Site Grading

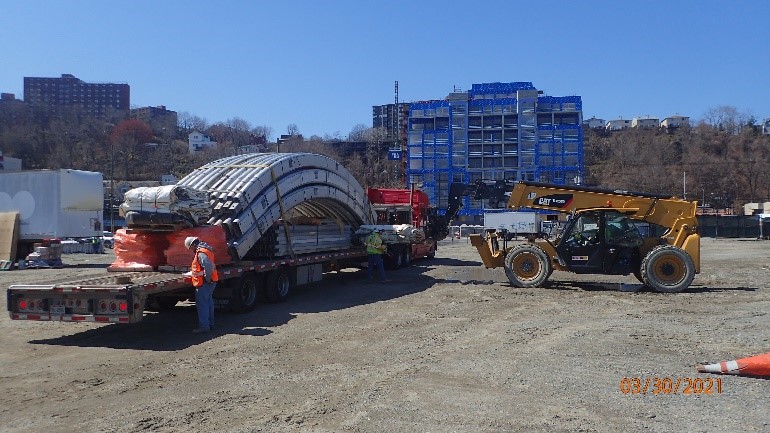

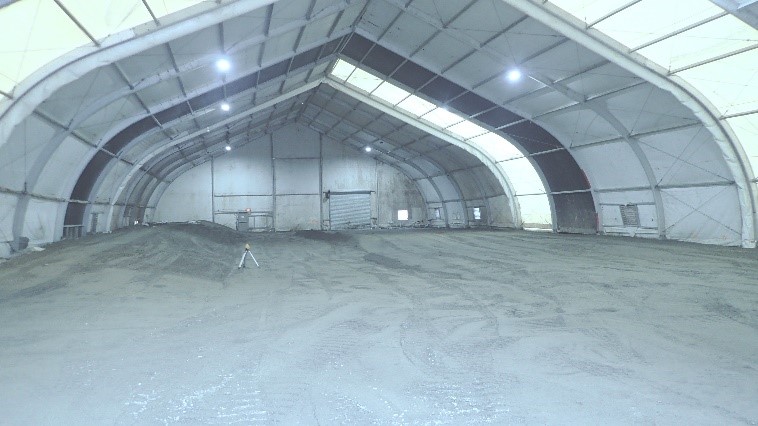

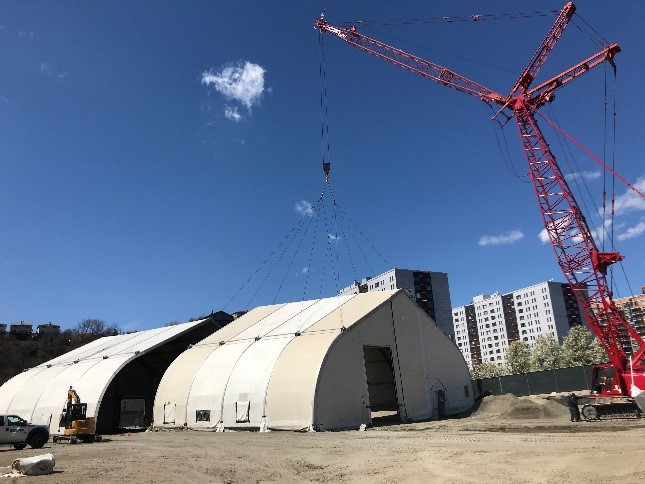

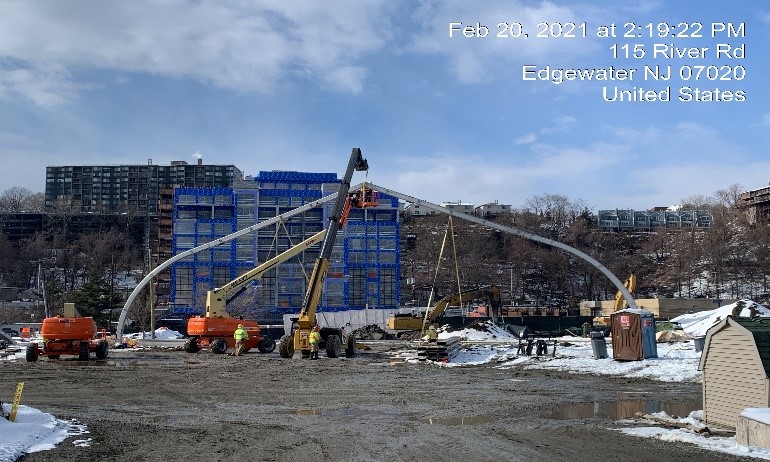

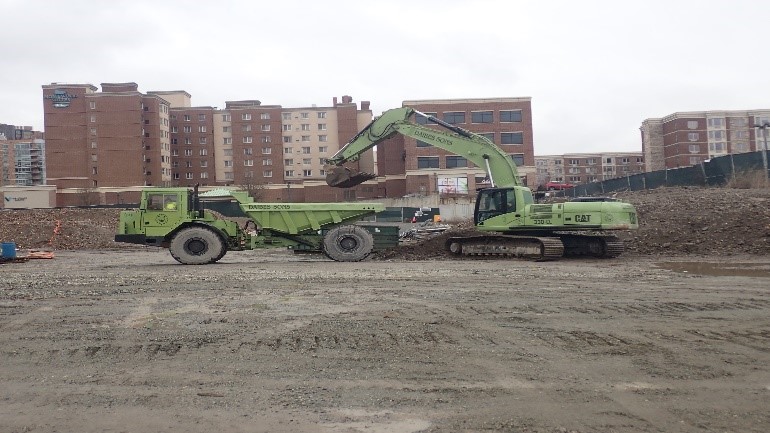

April 2021 - Removing Tent Parts

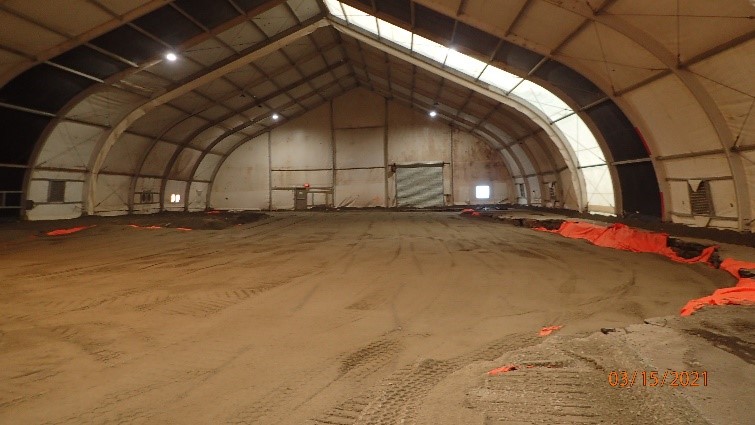

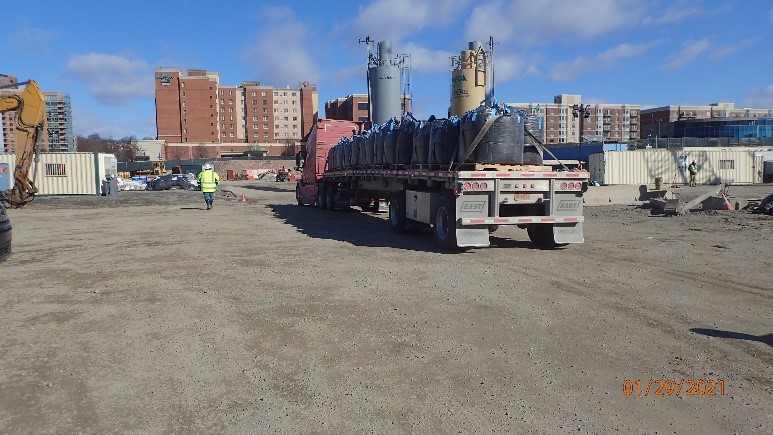

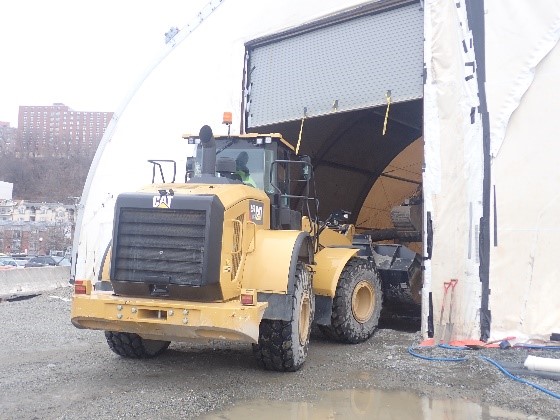

April 2021 - Load-Out of Central Tent Activated Carbon

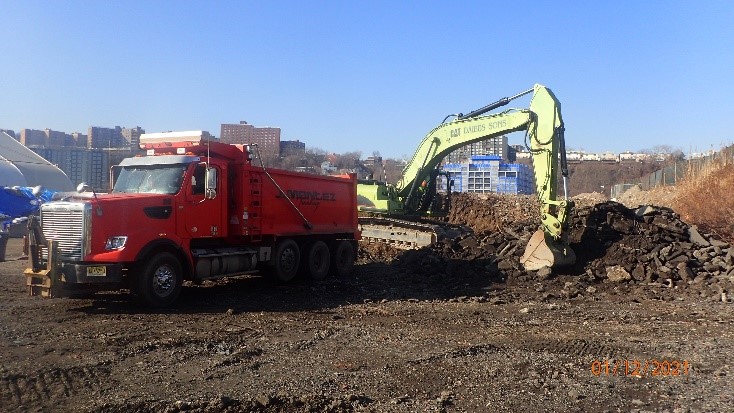

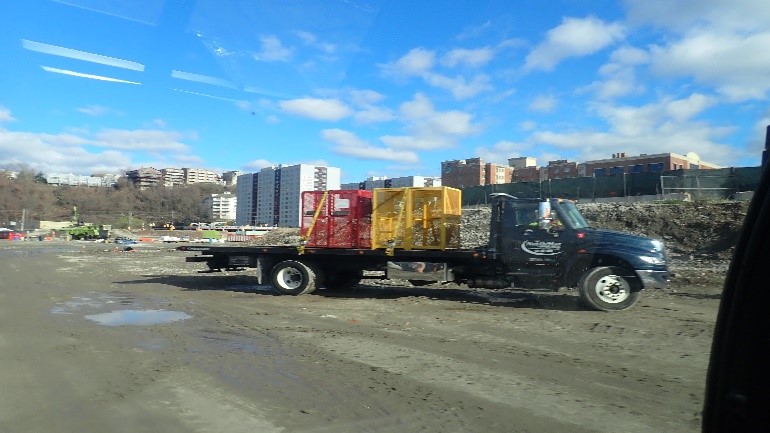

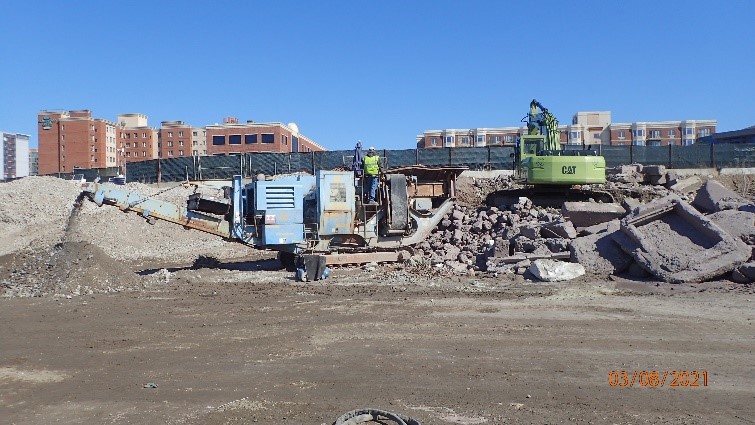

April 2021 - Removing Compressed Gas Cages

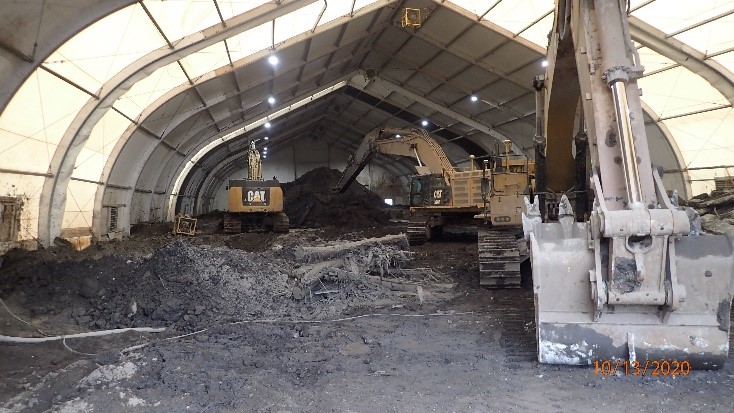

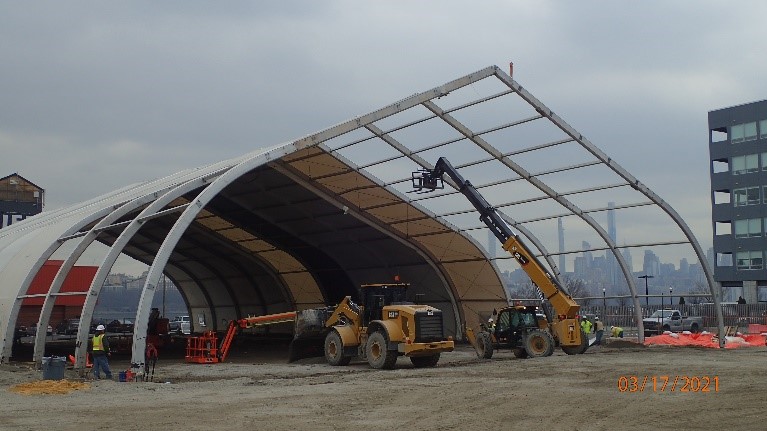

March 2021 - Final Grading Activities

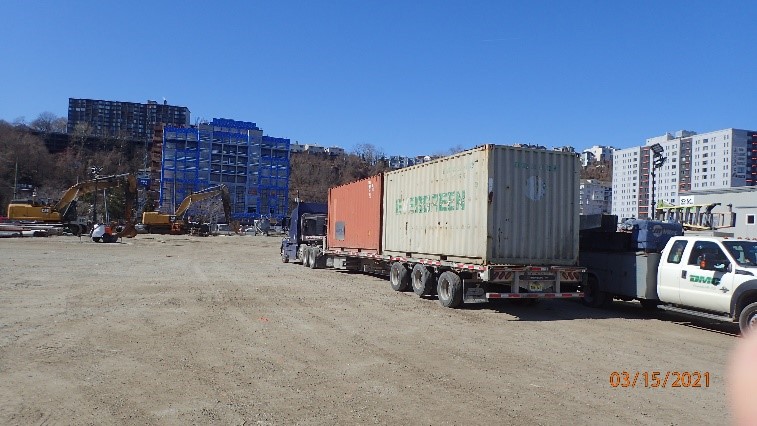

March 2021 - Equipment Demobilization

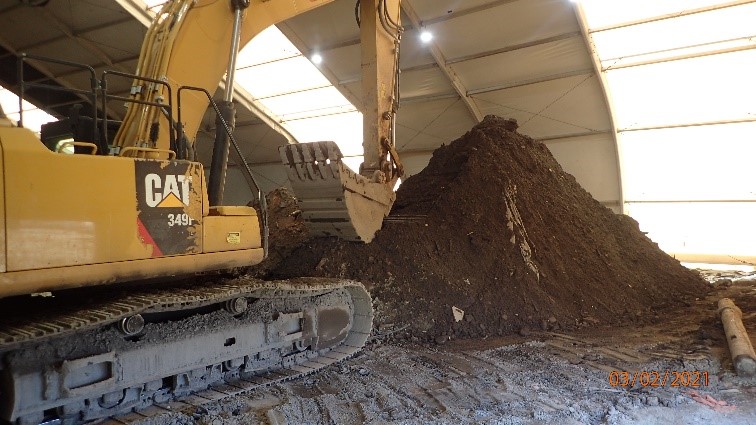

March 2021 - CAT 349 Demobilization
March 2021 - Preparing Tent Components for Demobilization

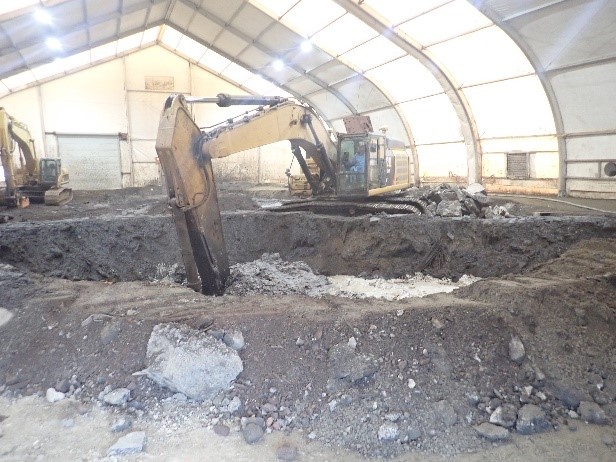

March 2021 - Central Pier Tent Disassembly
March 2021 - Central Pier Tent Capping
March 2021 - Equipment Staging

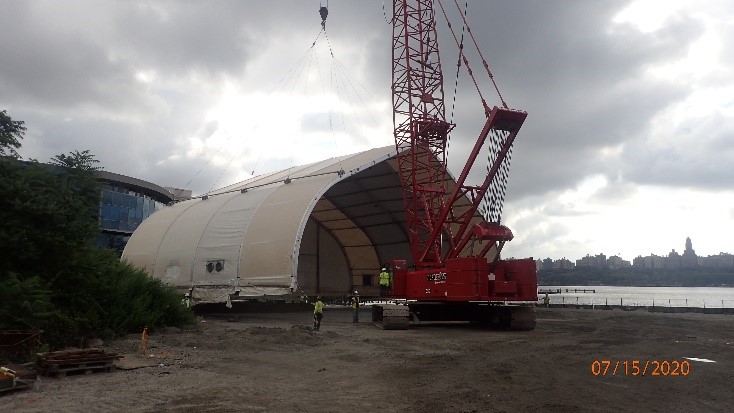

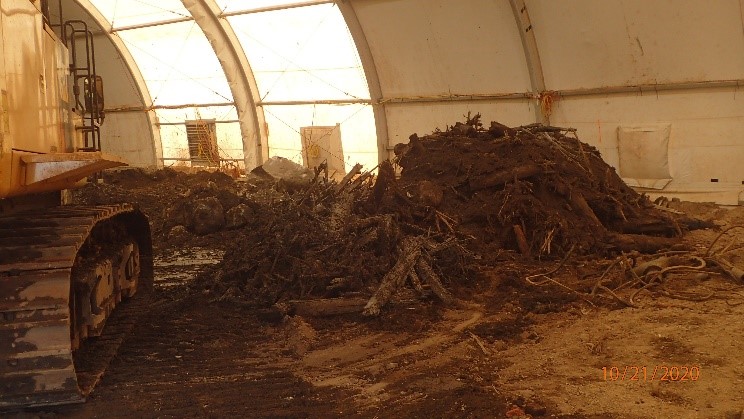

March 2021 - Disassembling the Batch Plant

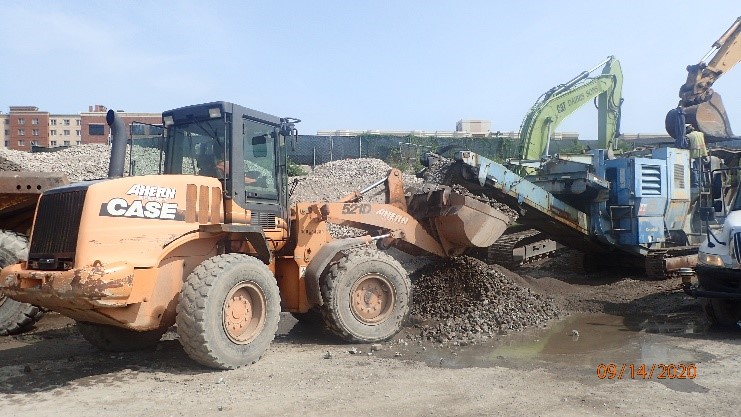

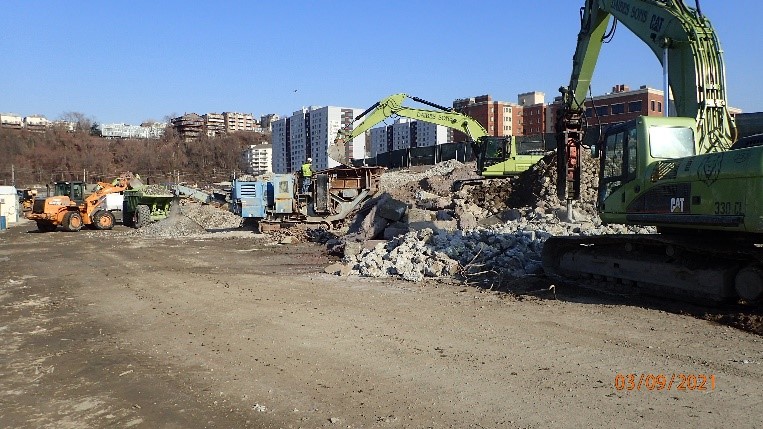

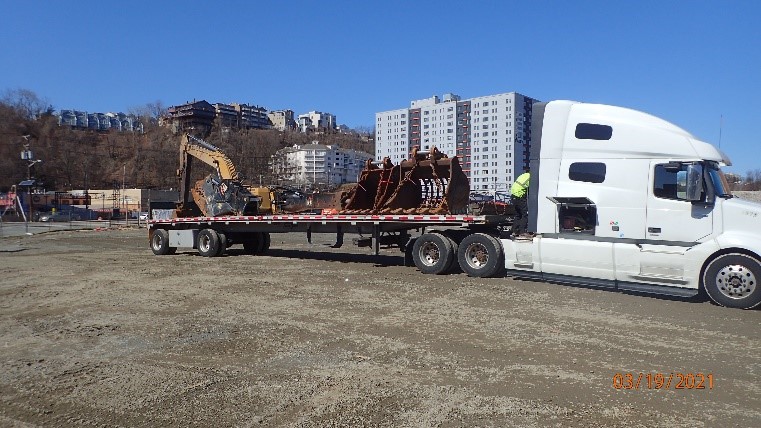

March 2021 - Category 1 Concrete Crushing
March 2021 - Category 1 Concrete Sizing and Crushing
March 2021 - Stockpile Soil Loadout with Posi-Shell Spraying

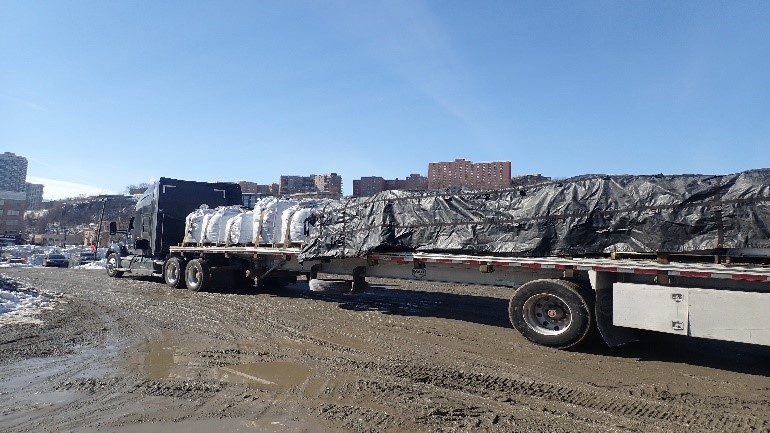

March 2021 - Central Tent Soil Stockpile
March 2021 - Stockpile Soil Loadout
February 2021 - Soil Stabilization Outside Tents in Southwest Area
February 2021 - Southwest Tent Loaded for Removal

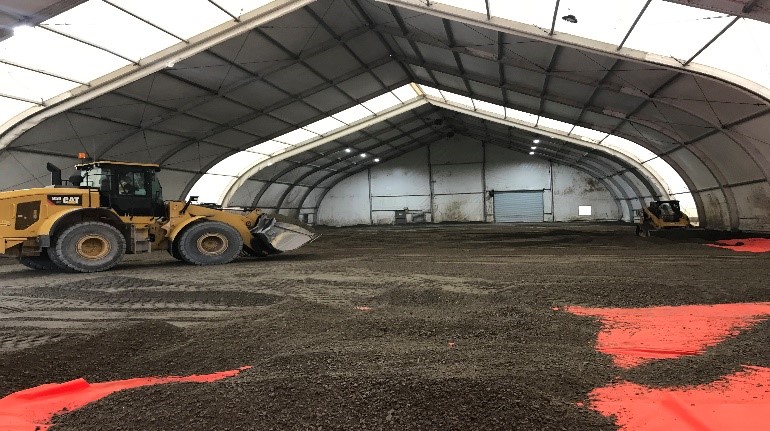

February 2021 - Disassembly of the Southwest Tent
February 2021 - Clearing inside the Pier Tent
February 2021 - Completed Construction of the Pier Tent (final tent)
February 2021 - Assembly of the Pier Tent (final tent)

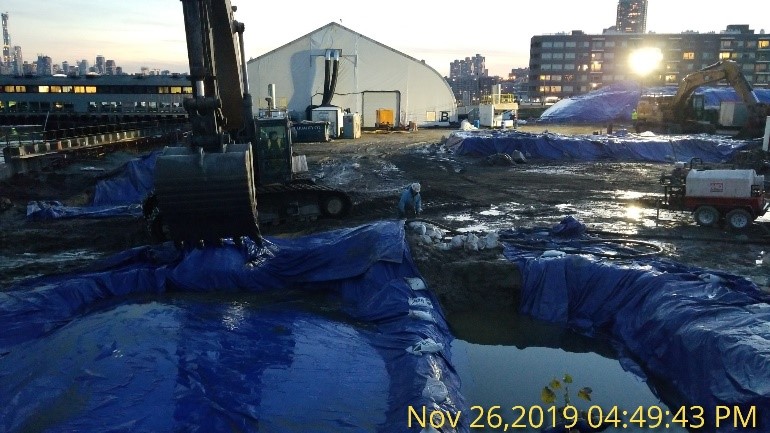

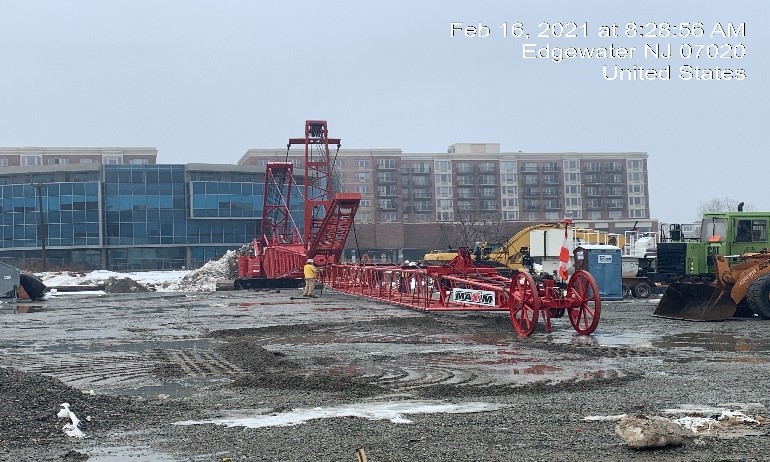

February 2021 - Demobilization of the Maxim Crane

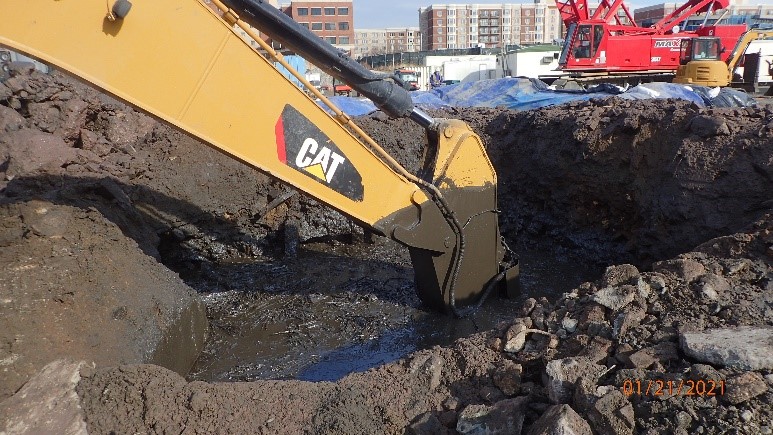

February 2021 - Vapor Phase Carbon Unit Placement for Pier Tent

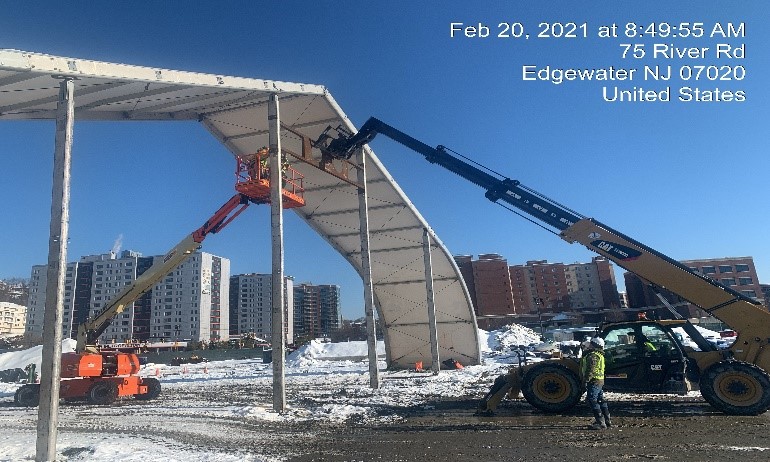

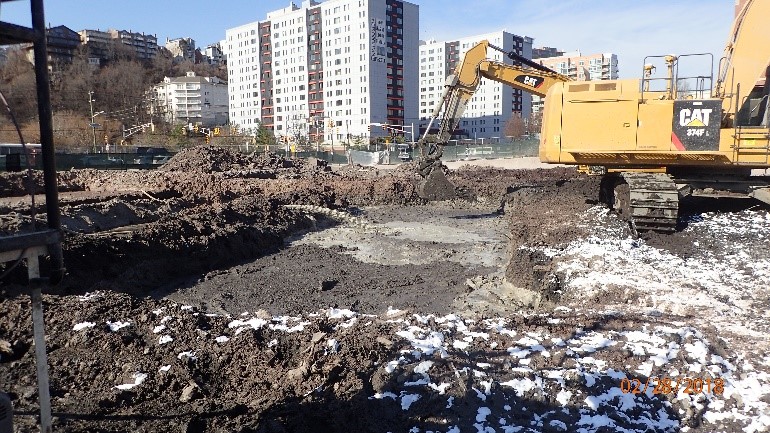

February 2021 - Placement of Pier Tent
February 2021 - Disassembly of Southwest Tent
February 2021 - Removal of Spent Vapor-Phase Carbon

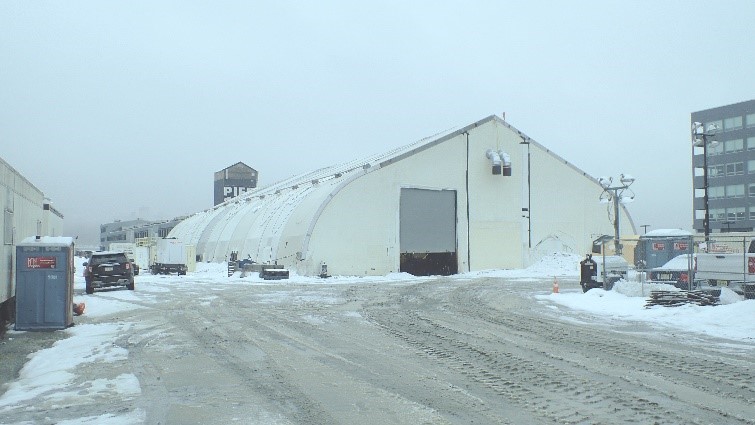

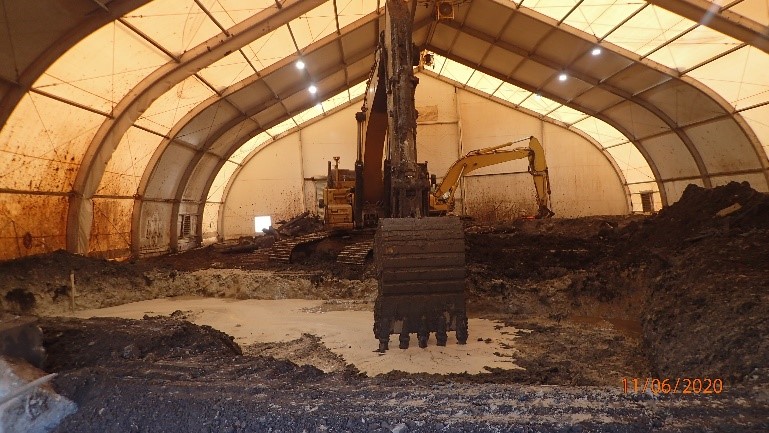

February 2021 - Northern Pier Tent
February 2021 - Demobilization of CAT 374 Crane

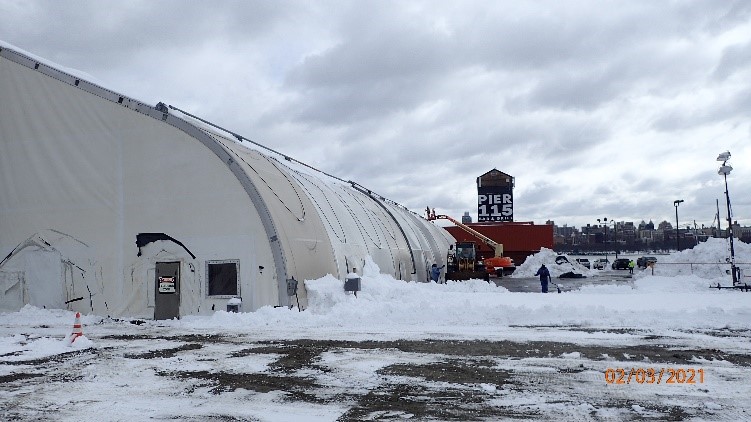

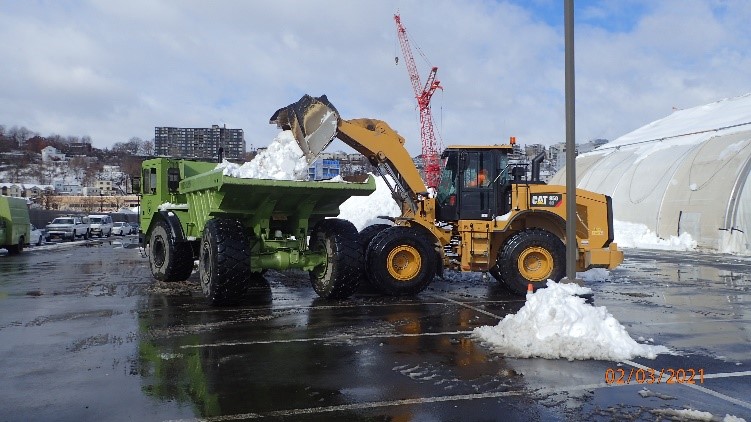

February 2021 - Snow Removal in Pier Parking Lot

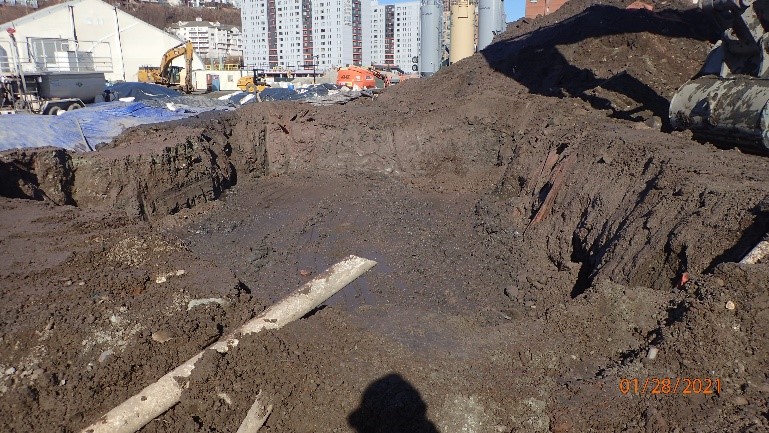

January 2021 - Power Washing in Southwest Tent
January 2021 - Managing Soil Stockpile in Southwest Tent
January 2021 - Slope Restoration in Northeast Area of the Site
January 2021 - Fresh Carbon Delivery
January 2021 - Clearing in Central Non-Tent Area
January 2021 - Soil Solidification in Central Non-Tent Area

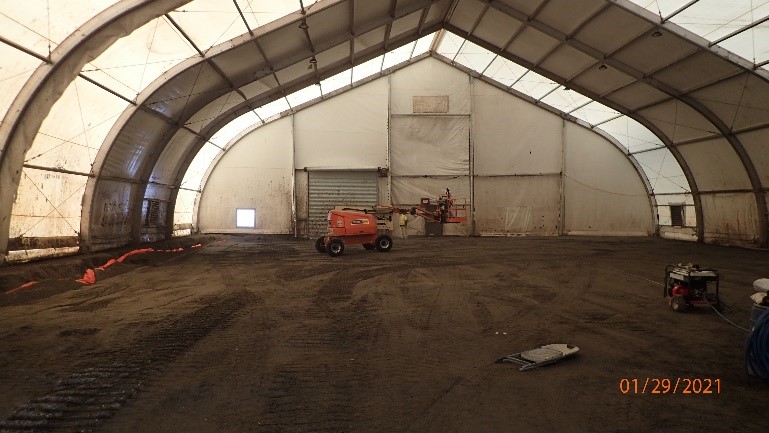

January 2021 - Capping in Northern Pier Tent

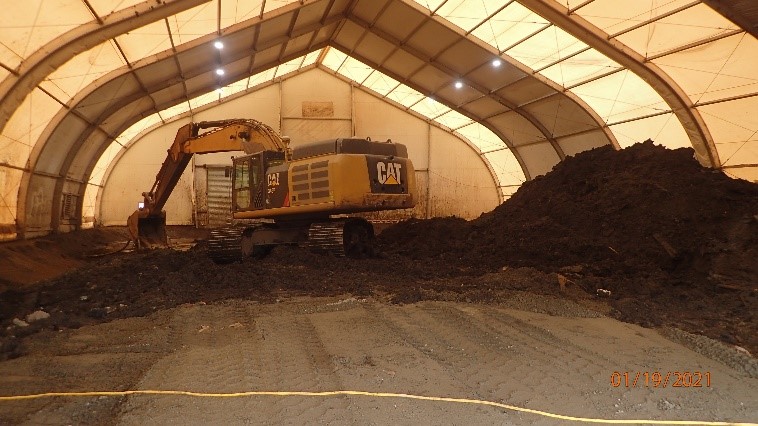

January 2021 - Inside Northern Pier Tent
January 2021 - Soil Management In Northern Pier Tent
January 2021 - Soil Solidification in Southwest Tent
January 2021 - Debris Management in Southwest Tent

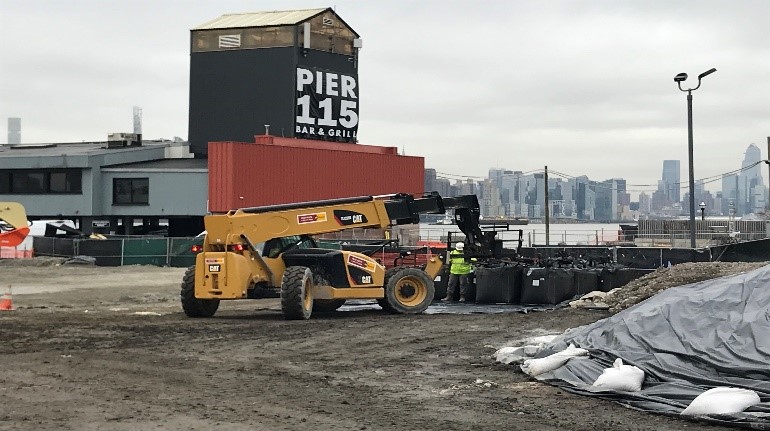

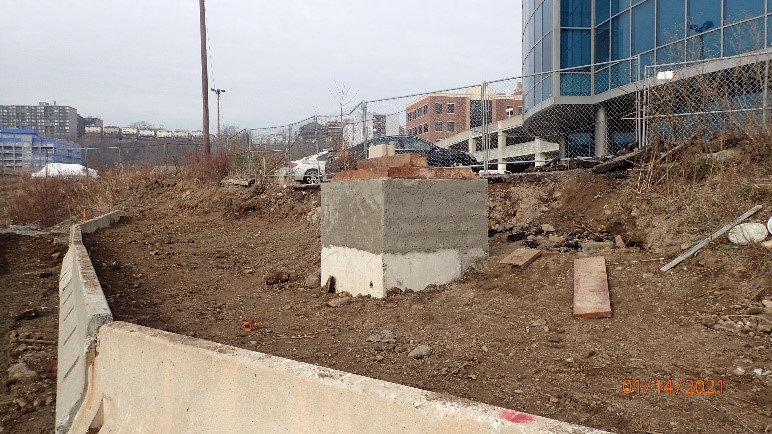

January 2021 - Pier Building Sign Relocation

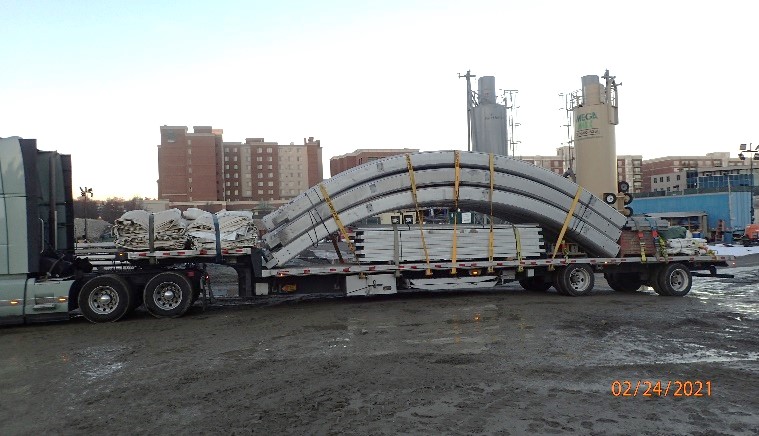

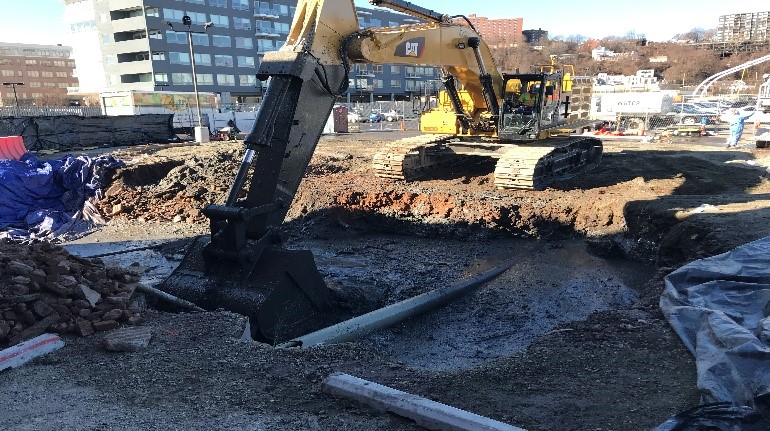

January 2021 - Asphalt Loadout

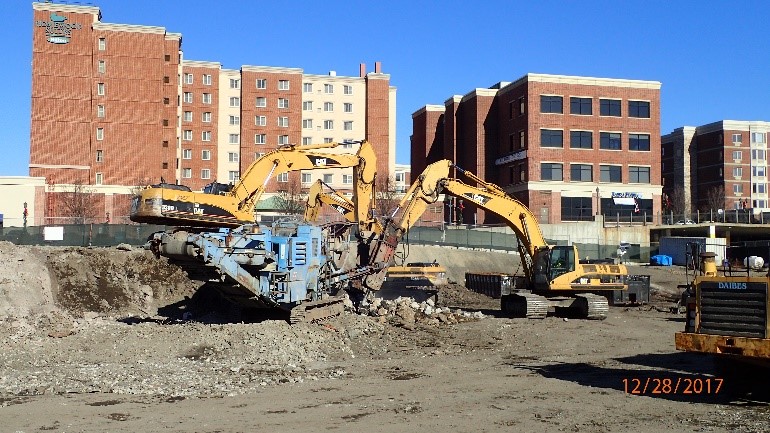

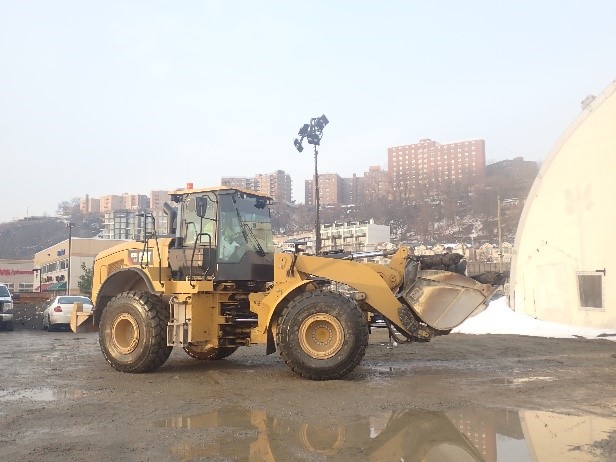

December 2020 - Soil Solidification Sample Collection in the Northeast Pier Tent

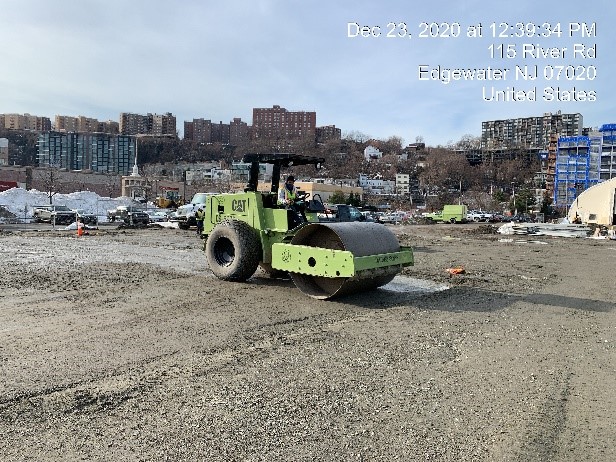

December 2020 - Central Pier Parking Lot Preparation
December 2020 - Pre-Clearing and Soil Solidification in the Southwest Tent
December 2020 - Removing Wood Debris from the Southwest Tent
December 2020 - Clearing in the Southwest Tent

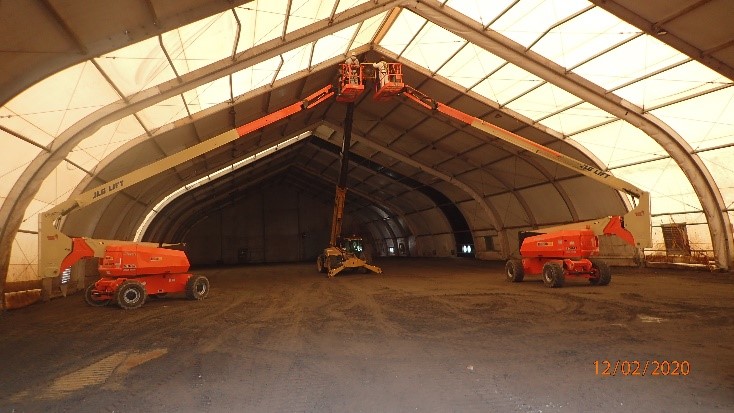

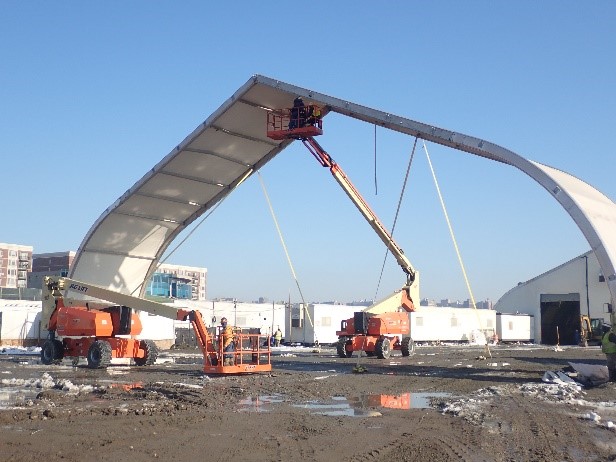

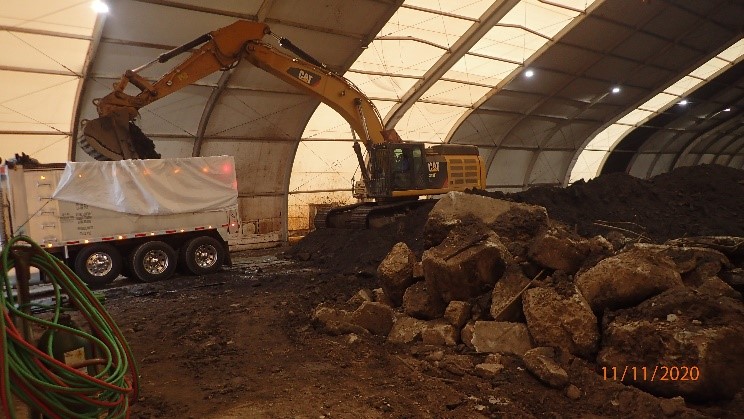

December 2020 - Dismantling the Final Segment of the Central Tent
December 2020 - Deconstructing the Central Tent

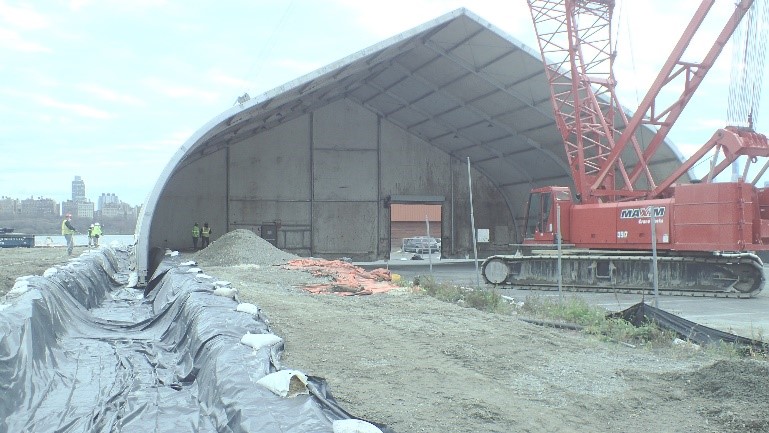

December 2020 - Assembling the Northeast Pier Tent
December 2020 - Placing the Northeast Pier Tent

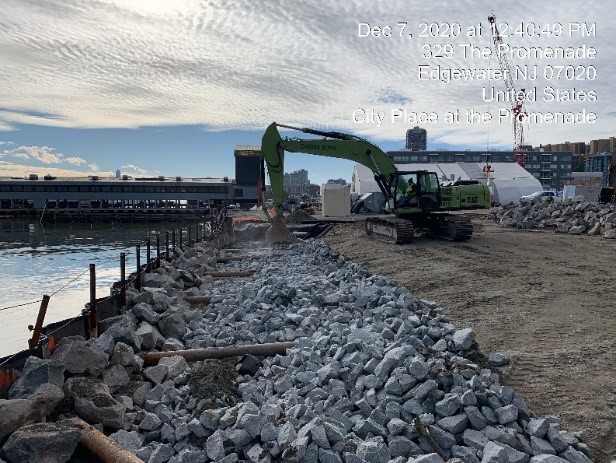

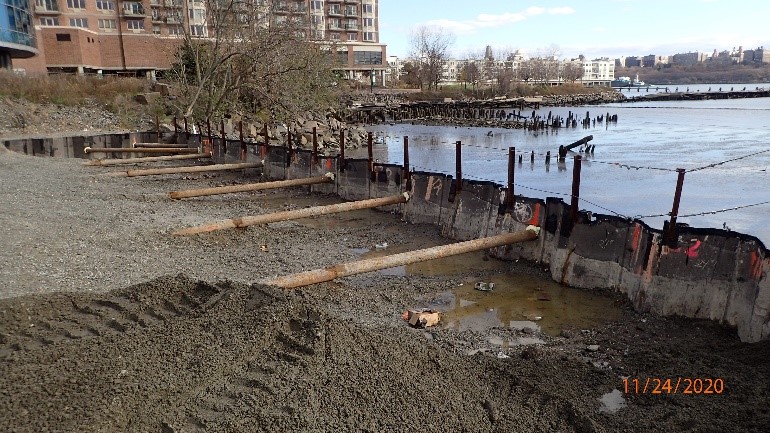

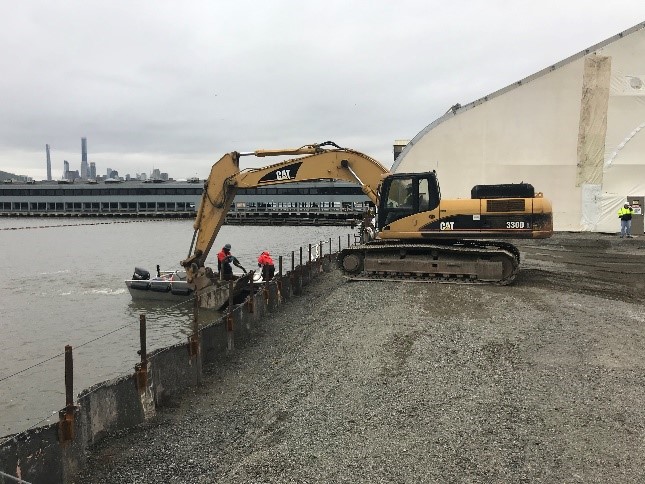

December 2020 - Installing Rip-Rap along the Hudson River
December 2020 - Reconstructing the Tent in the Northeast Pier Location

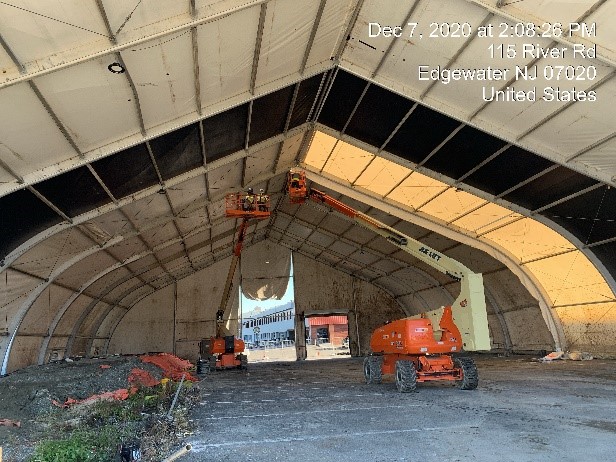

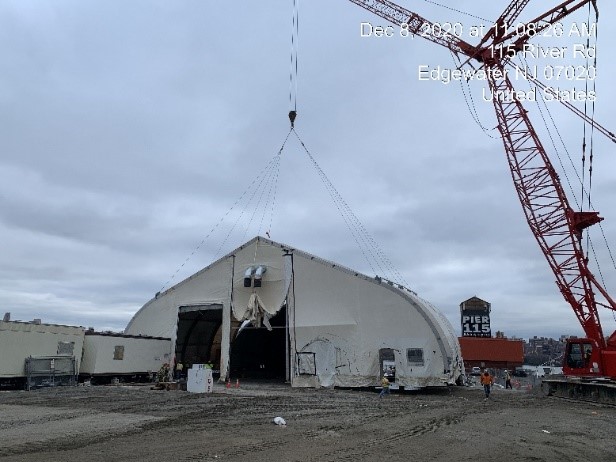

December 2020 - Relocating the Central Tent to the Northeast Pier Location

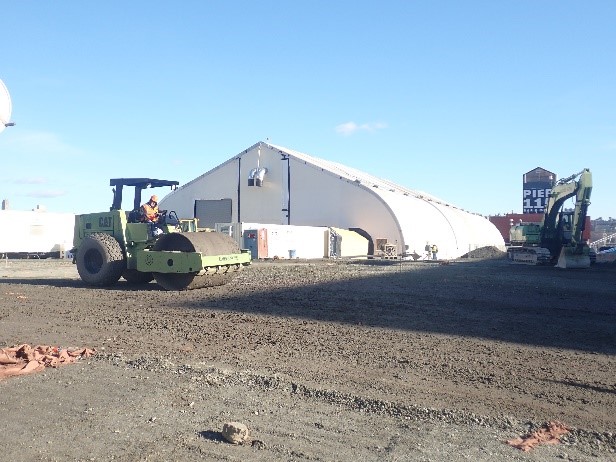

December 2020 - Capping in the Central Tent

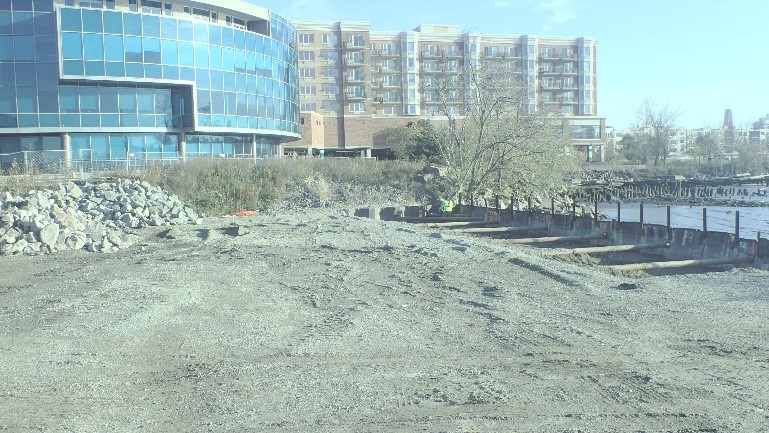

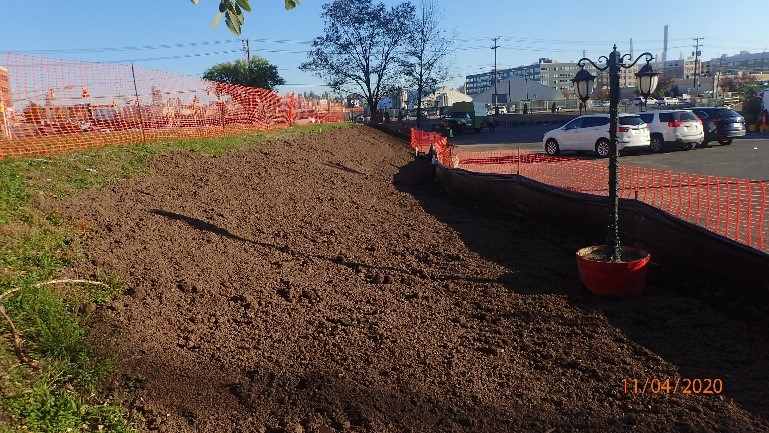

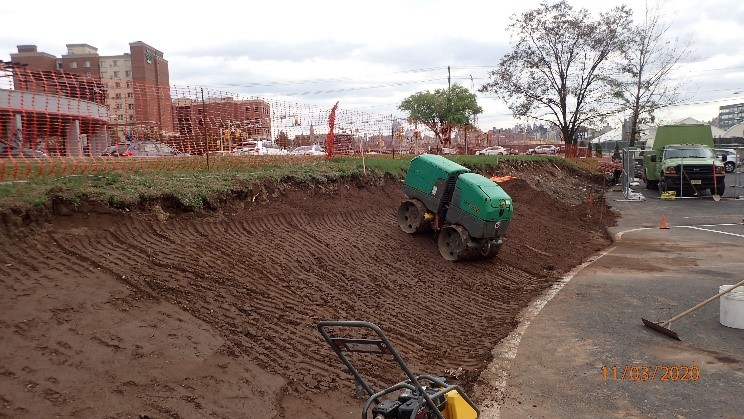

November 2020 - Restoration Along the River in Northeast Area of Site

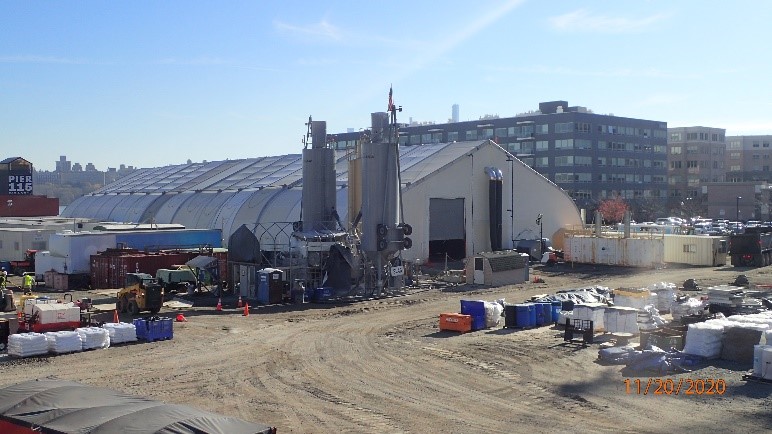

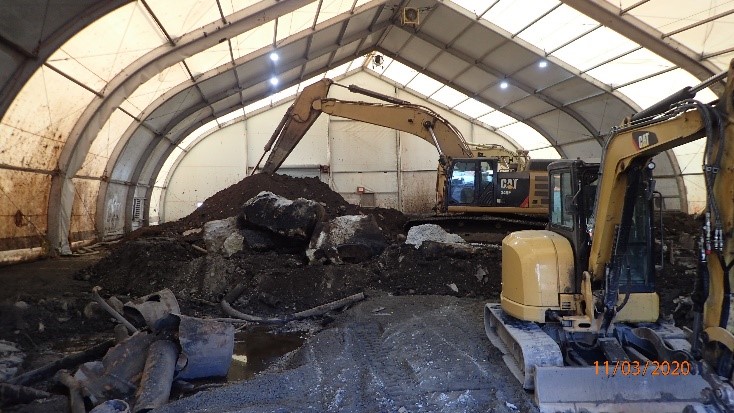

November 2020 - Preparing to Install Rip-Rap in Northeast Area of Site

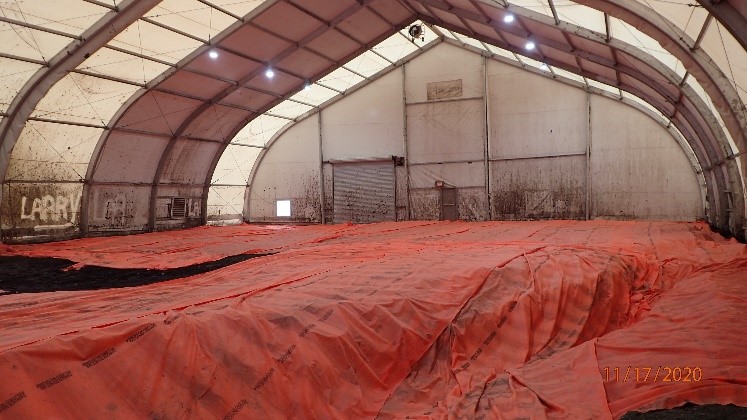

November 2020 - Installation of Temporary Gravel Cap in Central Tent

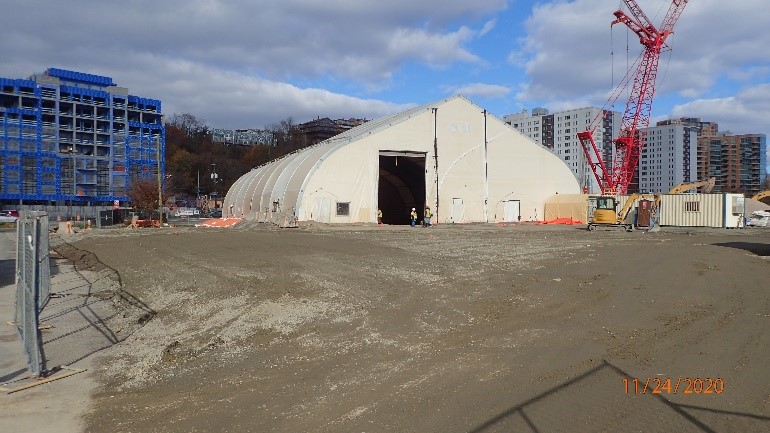

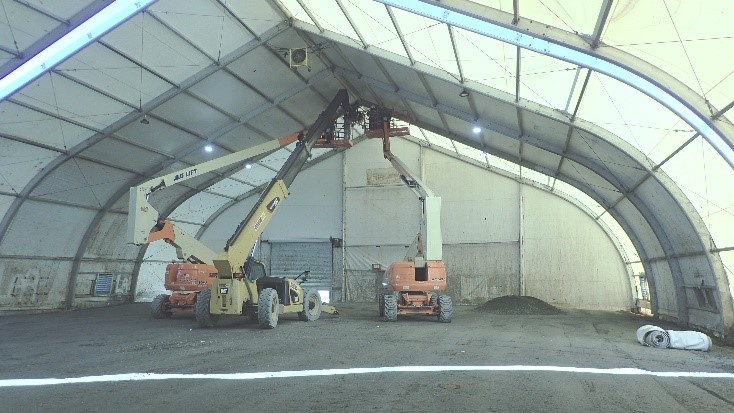

November 2020 - Central Tent
November 2020 - Re-Assembly of Southwest Tent in New Location
November 2020 - Moving Southwest Tent to New Location
November 2020 - Deconstruction of Southwest Tent
November 2020 - Capping in Southwest Tent
November 2020 - Cutting and Removing Sheet Along Hudson River
November 2020 - Hydroseeding for Grass Cap Across River Road
November 2020 - Backfill and Compaction for Lawn Cap Across River Road
November 2020 - Preparing for Lawn Cap Across River Road
November 2020 - Loadout of Excess Soil in Central Tent
November 2020 - Soil Solidification and Debris Management in Central Tent
November 2020 - Soil Solidification in Southwest Tent
November 2020 - Soil Solidification and Debris Management in Southwest Tent
October 2020 - Soil Solidification in Southwest Tent
October 2020 - Clearing in Southwest Tent
October 2020 - Wood Debris Stockpile in Southwest Tent
October 2020 - Debris Management in Southwest Tent
October 2020 - Concrete Sizing and Soil Solidification in Southwest Tent

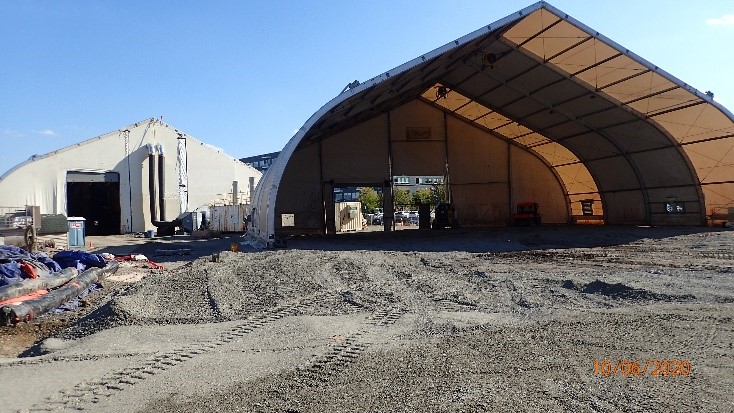

October 2020 - Final Soil Cap across River Road
October 2020 - Final Capping across River Road
October 2020 - Soil Solidification in Central Tent
October 2020 - Soil Solidification and Debris Management in Central Tent
October 2020 - Debris Management in Central Tent

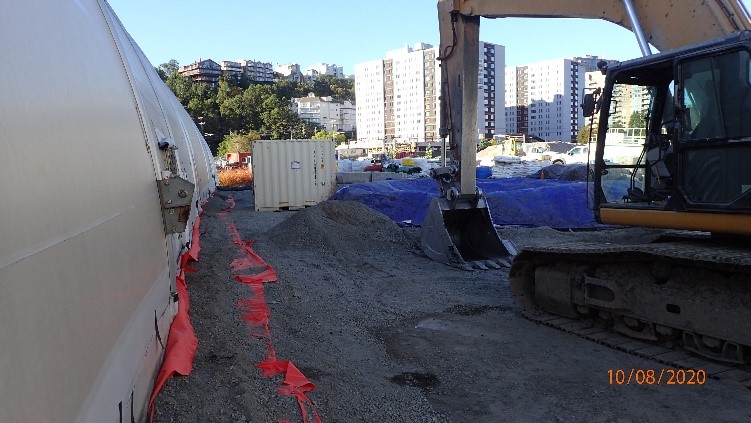

October 2020 - Excavation across River Road for Final Soil and Grass Cap
October 2020 - Tent Construction and Non-Tent Soil Solidification
October 2020 - Placing Tent Section in Southwest Area
October 2020 - Relocating Tent Section from Bulkhead to Southwest Area
October 2020 - Temporary Cap Installation in Non-Tent Area

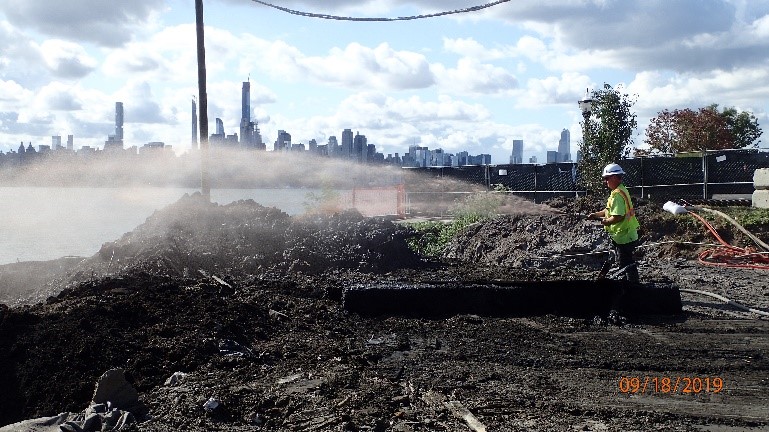

September 2020 - Soil Remediation Outside Tents

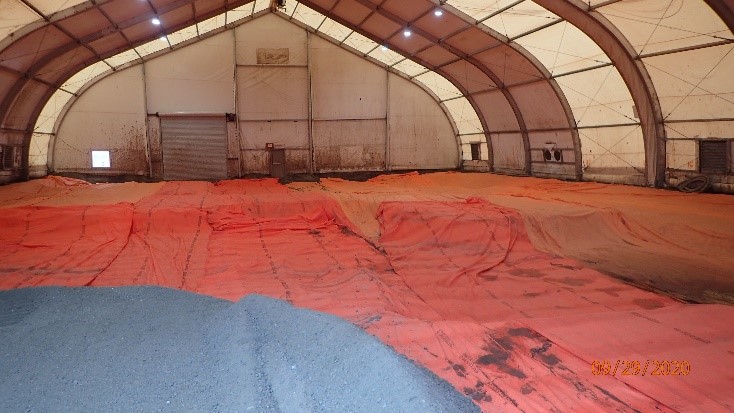

September 2020 - Bulkhead Tent Temporary Cap Installation
September 2020 - Debris in Bulkhead Tent

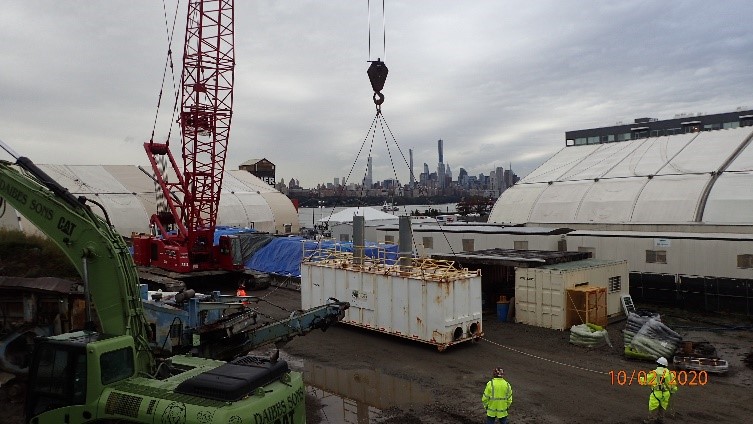

September 2020 - Relocation of Bulkhead Tent Air Handling Unit
September 2020 - Debris Management in Central Tent

September 2020 - “Block 93” Pavement (Across River Road from Main Quanta Site)
September 2020 - Paving “Block 93” (Across River Road from Main Quanta Site)

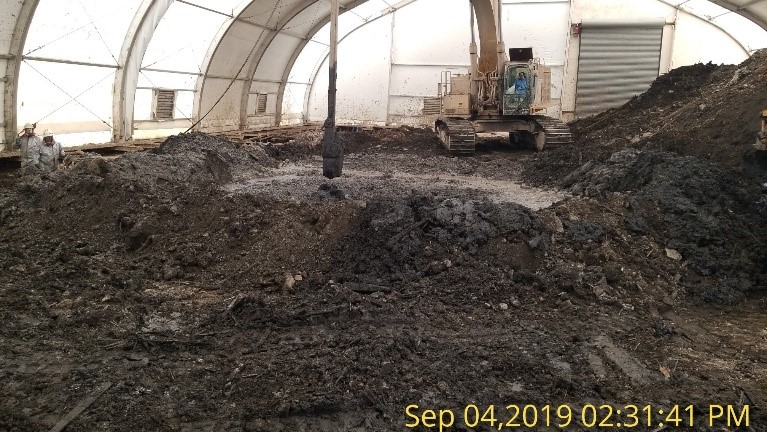

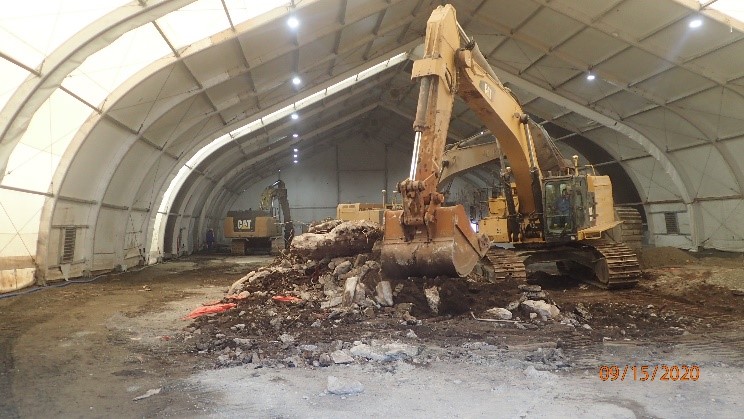

September 2020 - Soil Remediation in Bulkhead Tent
September 2020 - Clearing to Prepare for Soil Remediation in Bulkhead Tent

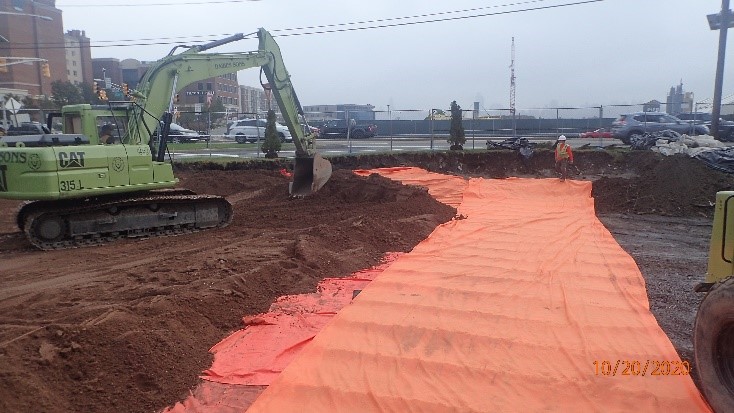

September 2020 - Gravel Backfill for Grading on “Block 93” (Across River Road from Quanta Site)

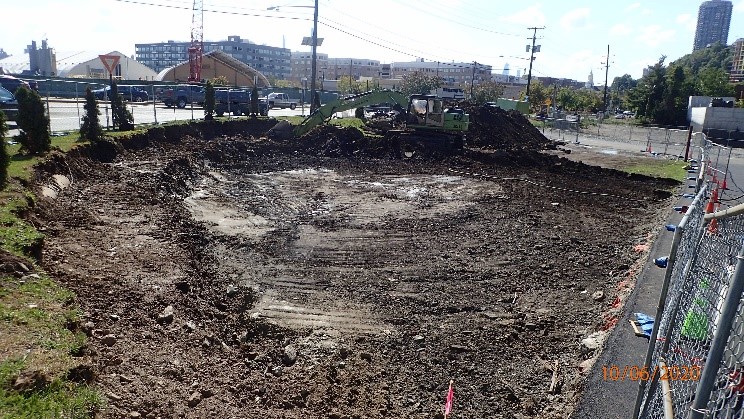

September 2020 - Excavation and Grading on “Block 93” (Across River Road from Quanta Site)

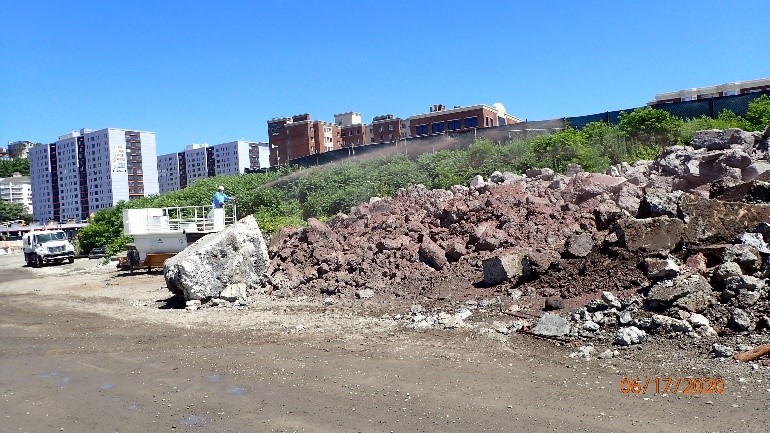

September 2020 - Concrete Crushing Operation
September 2020 - Concrete Loadout from Central Tent
September 2020 - Concrete Stockpile in Central Tent
August 2020 - Reassembling the Bulkhead Tent
August 2020 - Moving Half of the Bulkhead Tent
August 2020 - Preparing the New Location for the Bulkhead Tent
August 2020 - Capping in the Bulkhead Tent

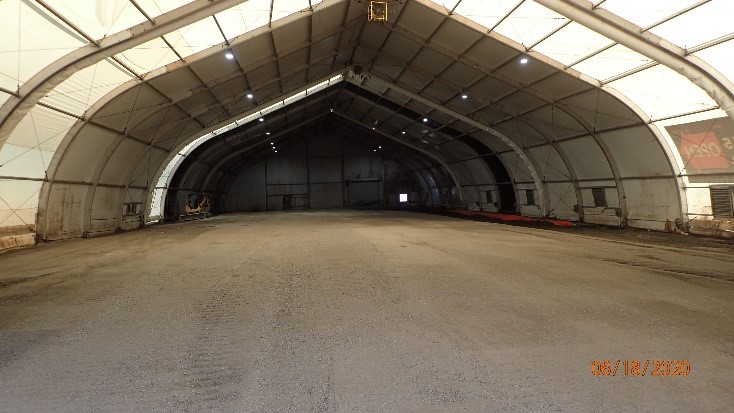

August 2020 - Capping the Central Non-Tent Area

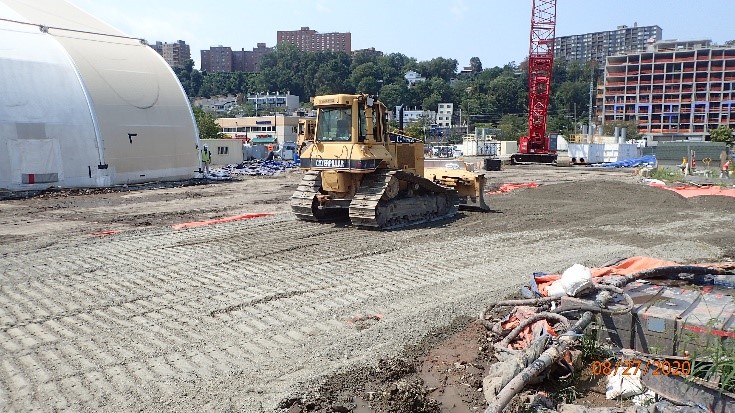

August 2020 - Non-Tent Soil Solidification in the Central Area

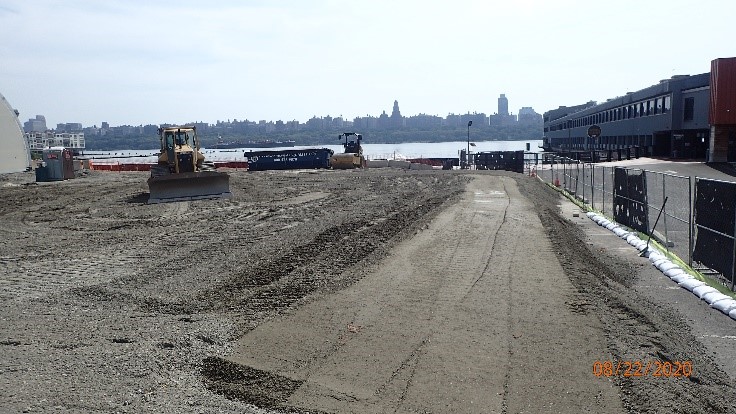

August 2020 - Surface Preparation Before Moving the Central Tent
August 2020 - Capping Inside the Central Tent After Soil Solidification
August 2020 - Non-Tent Soil Solidification
August 2020 - Clearing for Non-Tent Soil Solidification

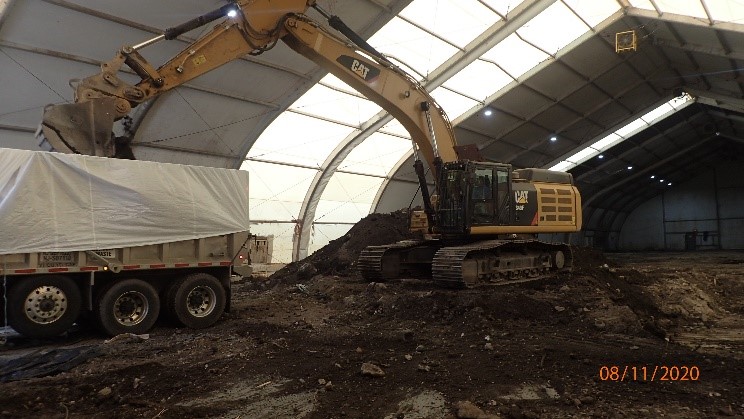

August 2020 - Removing Excess Soil from the Central Tent in Lined Trucks
August 2020 - Truck Lining Station for Offside Disposal
August 2020 - Soil Solidification Inside the Bulkhead Tent

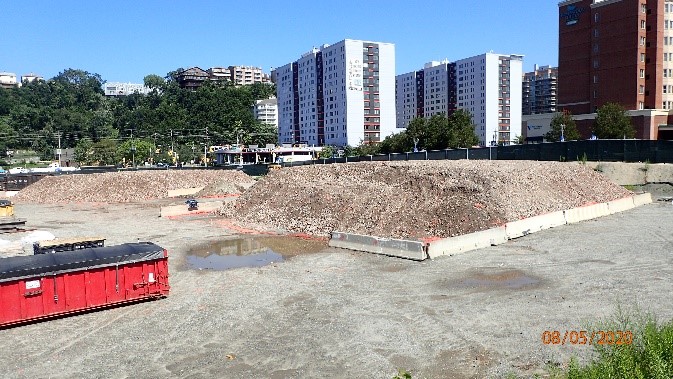

August 2020 - Stockpiles from Building Demolition Debris
August 2020 - Applying Posi-Shell to Concrete Stockpile to Control Odors
August 2020 - Developing New River Road Curb Cut

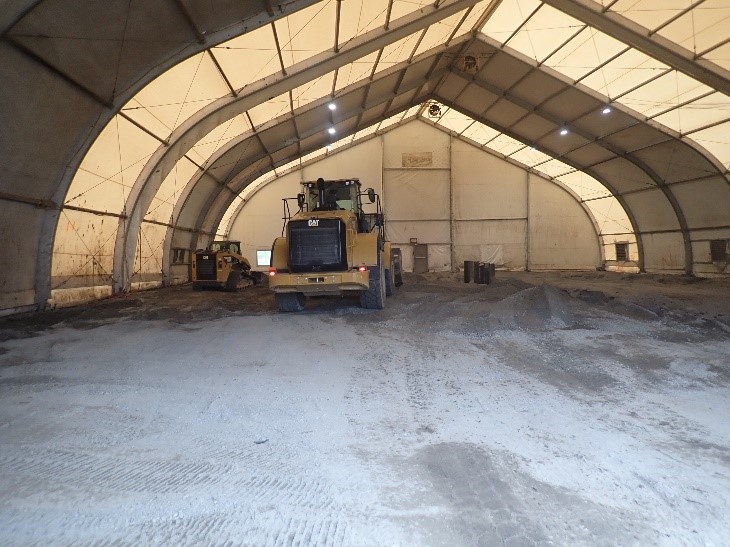

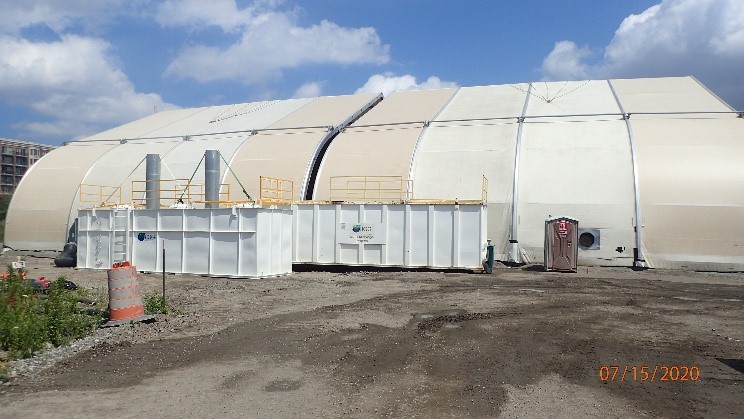

July 2020 - Grading Gravel Cap Inside Bulkhead Tent
July 2020 - Concrete Processing Area
July 2020 - Both Halves of Bulkhead Tent Placed in New Location
July 2020 - Moving Northern Half of Bulkhead Tent
July 2020 - Concrete Crushing

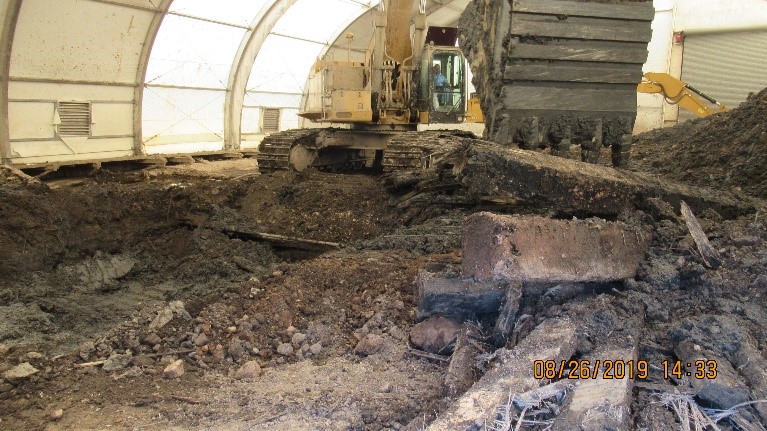

July 2020 - Removing Wood Debris in Central Tent
July 2020 - Clearing Debris in Central Tent
July 2020 - Soil Solidification in Central Tent
July 2020 - Soil Stabilization in the Central Tent

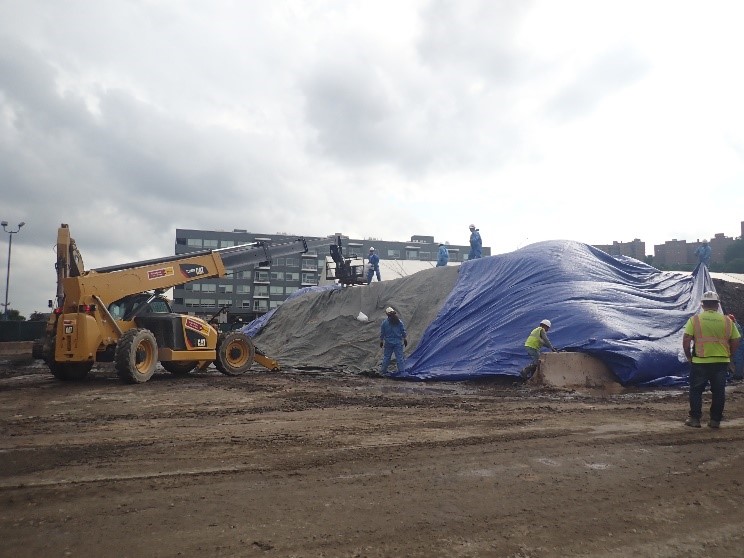

July 2020 - Covering the Soil Stockpile
July 2020 - Debris Management in the Central Tent
July 2020 - Concrete Stockpile from the Former 115 River Road Building in the Central Tent

July 2020 - Clearing the Foundation of the Former 115 River Road Building inside the Central Tent
July 2020 - Managing and Moving Roll-off Containers
July 2020 - Capping in the Bulkhead Tent
July 2020 - Soil Stabilization in the Bulkhead Tent

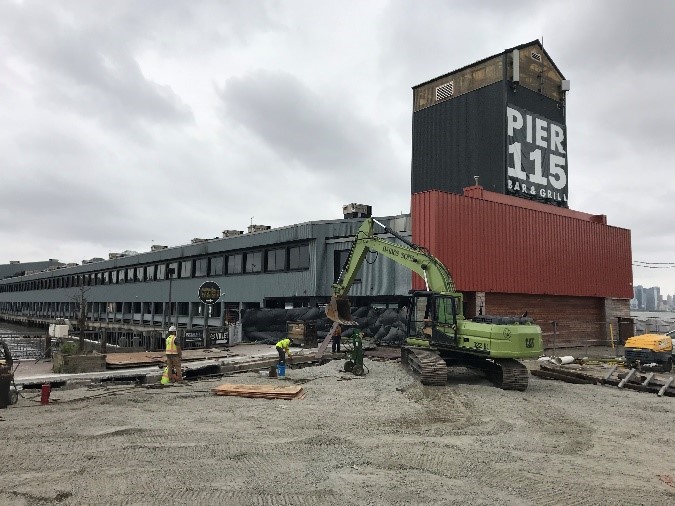

June 2020 - Central Tent with Sign for Pier Building
June 2020 - Completed Bulkhead Concrete Cap in the Pier Building Driveway

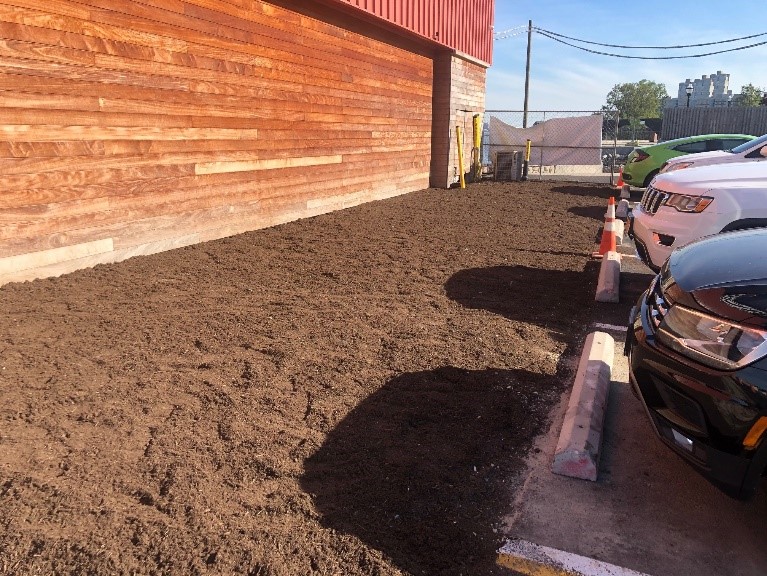

June 2020 - Mulch Installation Along the Pier Building
June 2020 - Pier Building Parking Lot after Repaving

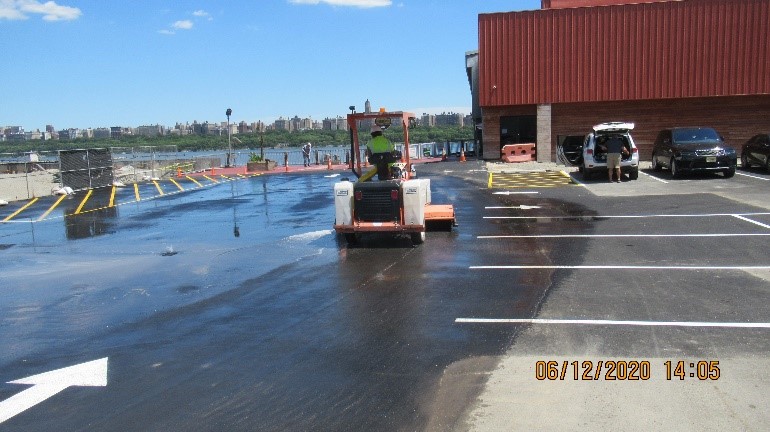

June 2020 - Work Area Sweeping After Paving and Striping Outside Pier Building

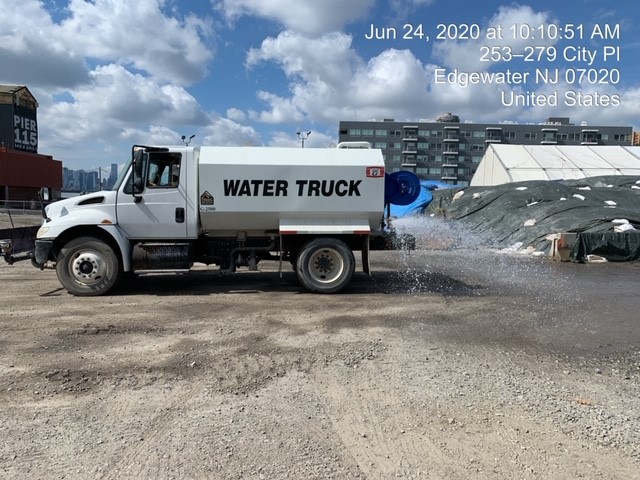

June 2020 - Site Dust Control
June 2020 - Soil Stabilization in the Bulkhead Tent
June 2020 - Absorbent Boom Swap-Out

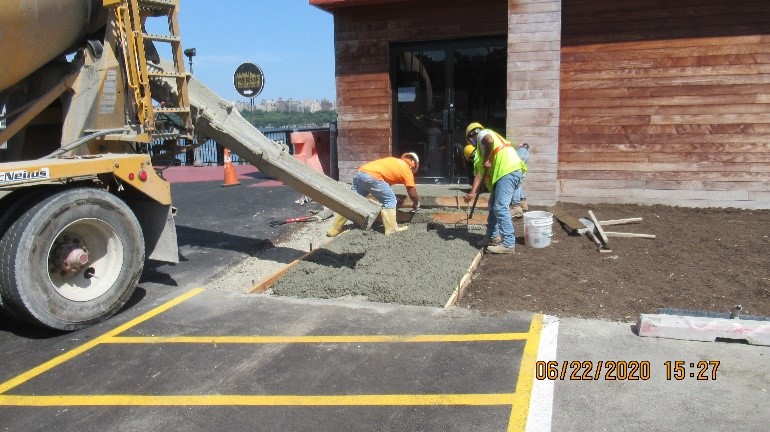

June 2020 - Pouring Concrete for Pier Building Office Stairs
June 2020 - Posi-Shell Application at Concrete Stockpile
June 2020 - Mulch Installation Along the River
June 2020 - Soil Stockpile Load-Out

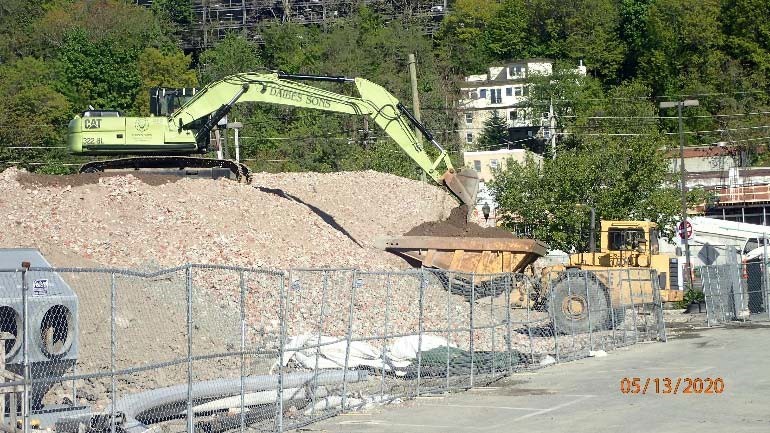

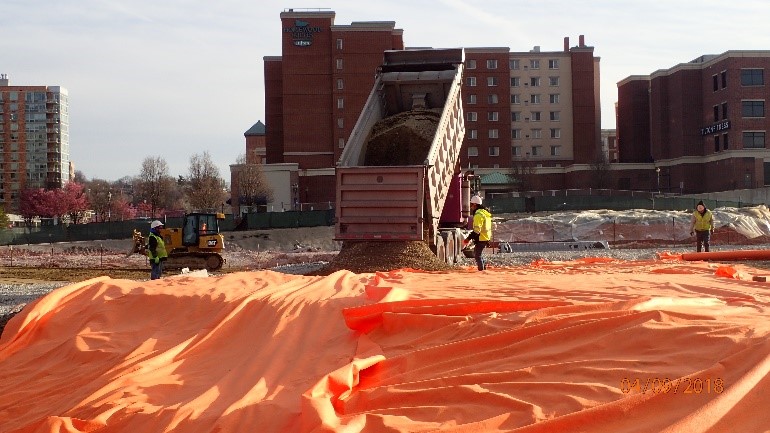

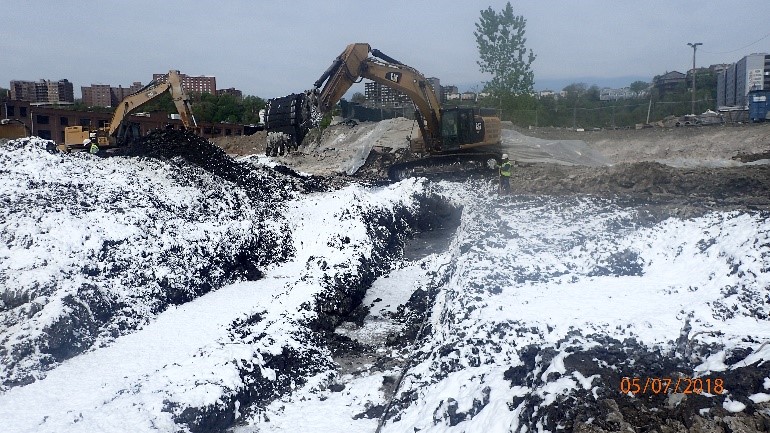

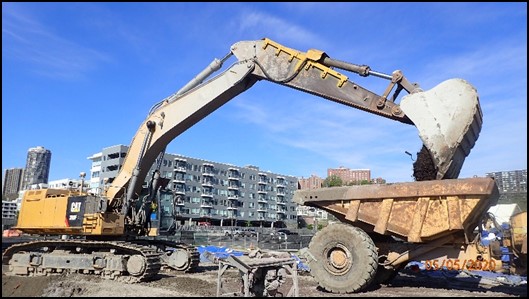

May 2020 - Load-out of Soil Overburden for Offsite Transport

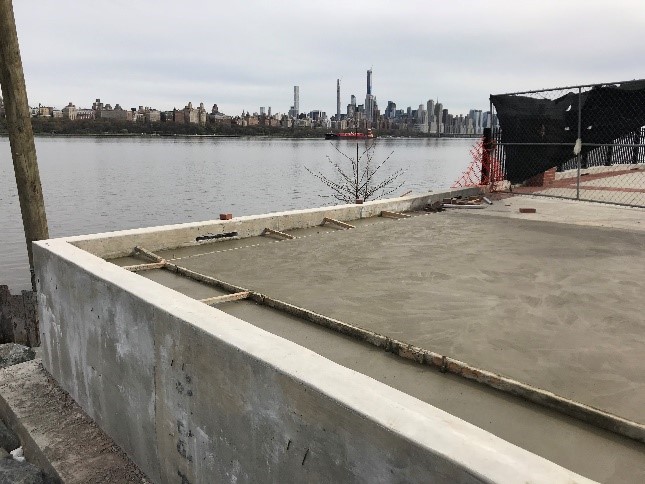

May 2020 - Concrete Cap Preparation

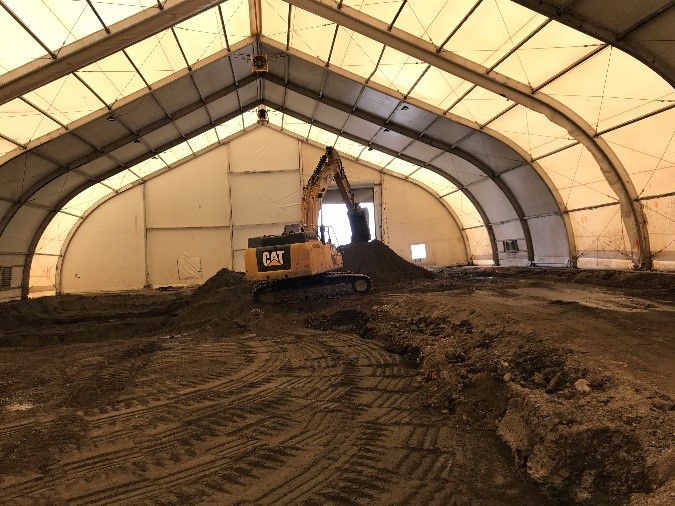

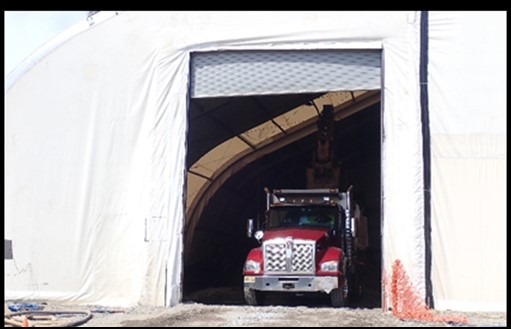

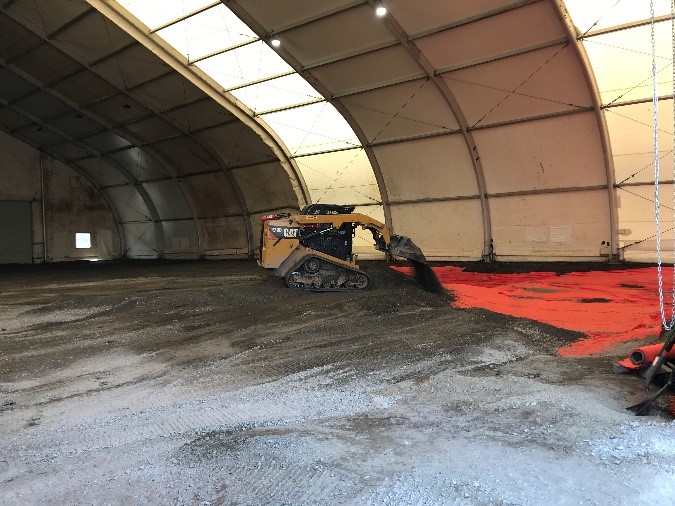

May 2020 - Grading in the Bulkhead Tent
May 2020 - Restoration of the Slope Along the Northern Fenceline

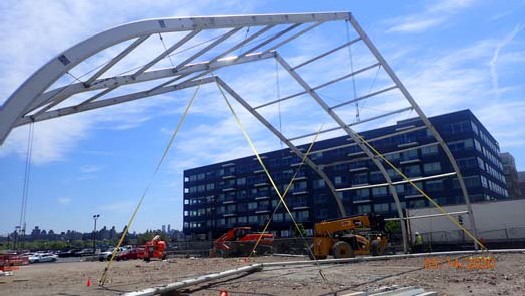

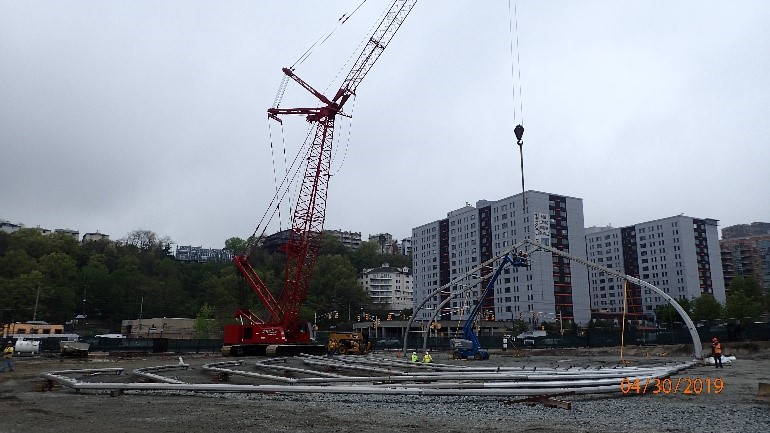

May 2020 - Assembly of the Central Tent at the Site of the Former 115 River Road Building

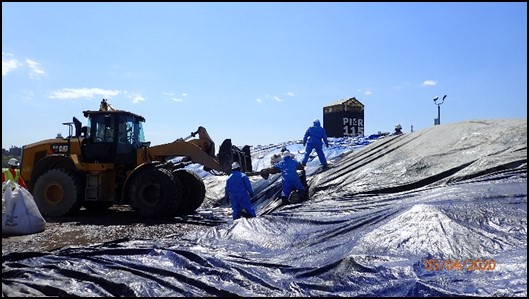

May 2020 - Temporary Cap Installation in the Northwest Tent
May 2020 - Soil Solidification in Northwest Tent
May 2020 - Assembly of Central Tent at Site of Former 115 River Road Building
May 2020 - Loading Demolition Debris for Offsite Transport

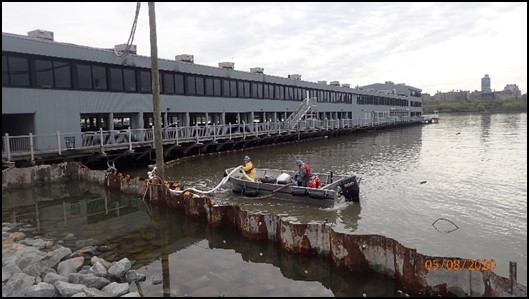

May 2020 - Absorbent Boom Replacement on South Side of Pier Building
May 2020 - Pre-Clearing for Soil Treatment Near Pier Building
May 2020 - Overburden Management in Non-Tent Area Near Pier Building
May 2020 - Re-Covering Soil Stockpile
April 2020 - iPark Sidewalk Restoration

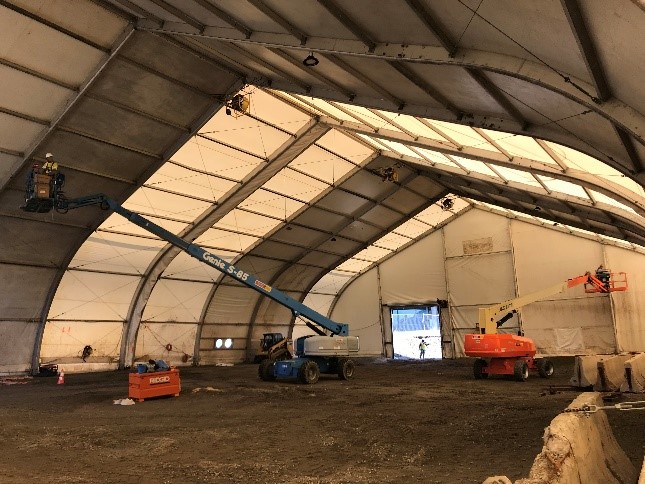

April 2020 - Backfilling in Non-Tent Area
April 2020 - Soil Solidification and Posi-Shell Application in Non-Tent Area Near Pier Building
April 2020 - Asphalt Removal and Posi-Shell Application in Non-Tent Area Near Pier Building
April 2020 - Pre-Clearing for Soil Solidification and Posi-Shell Application in Non-Tent Area Near Pier Building
April 2020 - Backfilling Over New Stormwater Piping

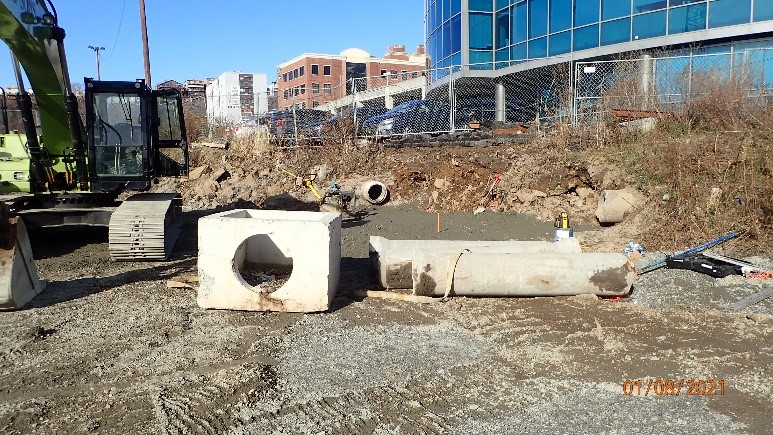

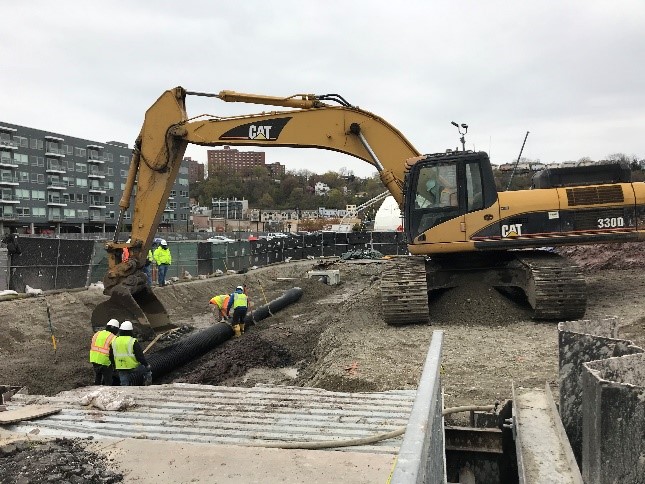

April 2020 - Stormwater Pipe Installation
April 2020 - Soil Stockpile Load-Out and Posi-Shell Application
April 2020 - Soil Remediation in Non-Tent Area North of the Pier Building
April 2020 - Load-out of Excess Soil in Stockpile Using Posi-Shell to Minimize Vapors

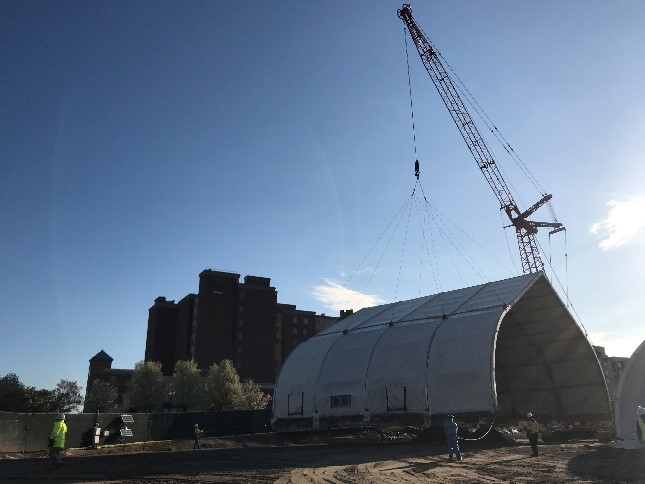

April 2020 - Relocation of Second Section of Northwest Tent
April 2020 - Relocation of First Section of Northwest Tent
April 2020 - Re-Assembling the Bulkhead Tent after Being Moved
April 2020 - River Walk Restoration South of the Pier Building
April 2020 - Temporary Cap Installation in Northwest Tent

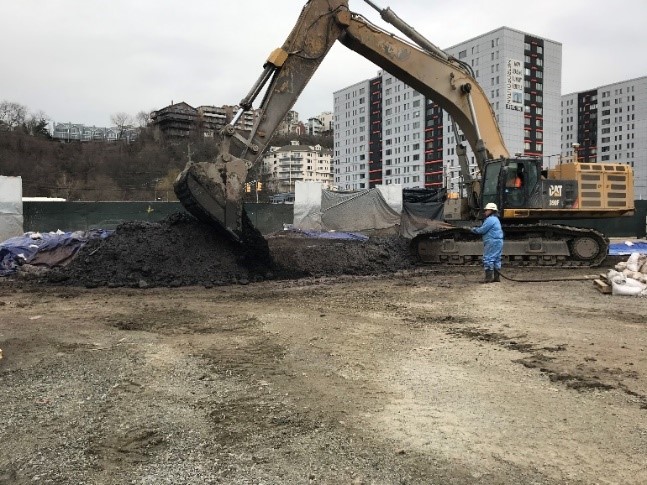

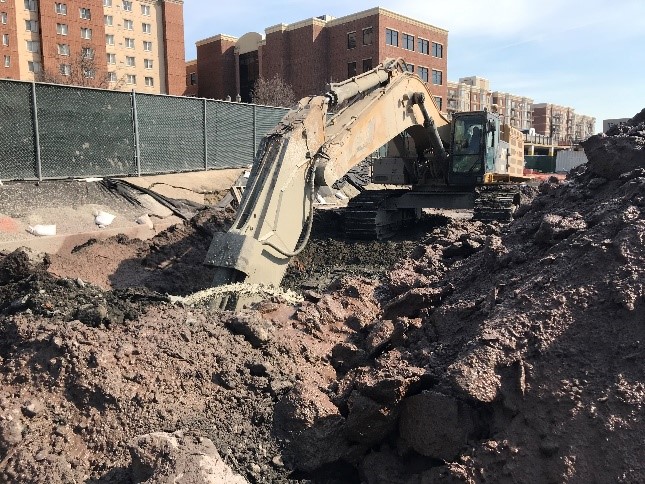

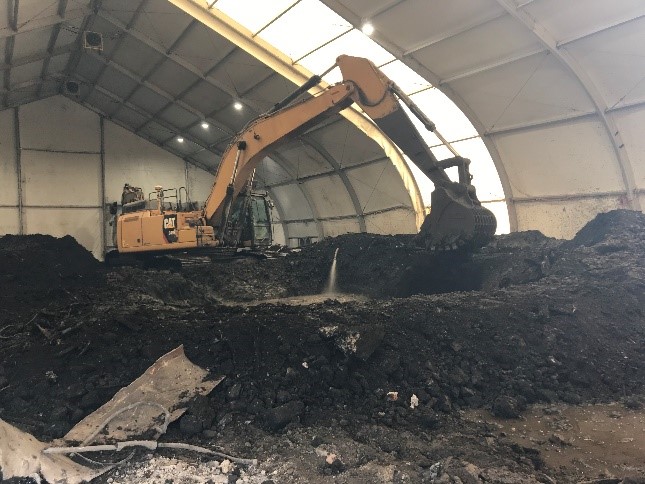

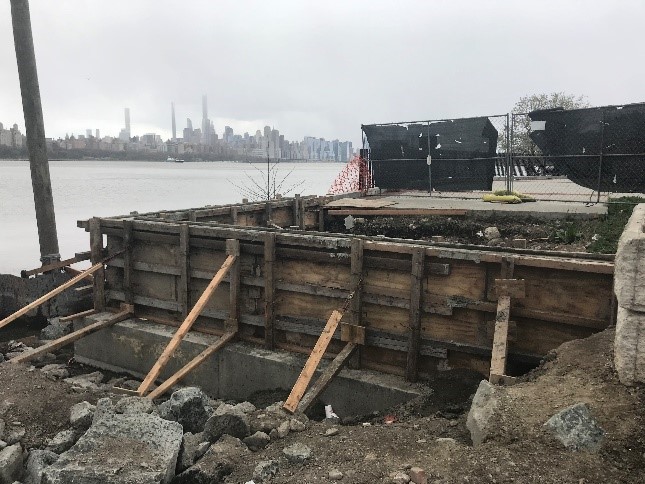

March 2020 - Disassembly of the Bulkhead Tent
March 2020 - Overburden Load-Out from the Northwest Tent
March 2020 - Management of Residual Overburden in the Northwest Tent
March 2020 - Soil Stockpile Management with Use of Posi-Shell to Control Odors

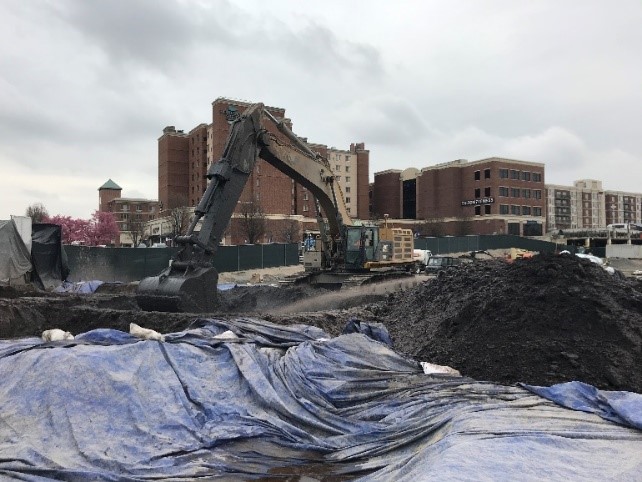

March 2020 - Temporary Cap Installation in Non-Tent Area
March 2020 - Temporary Cap Installation in Bulkhead Tent
March 2020 - Absorbent Boom Replacement in Hudson River

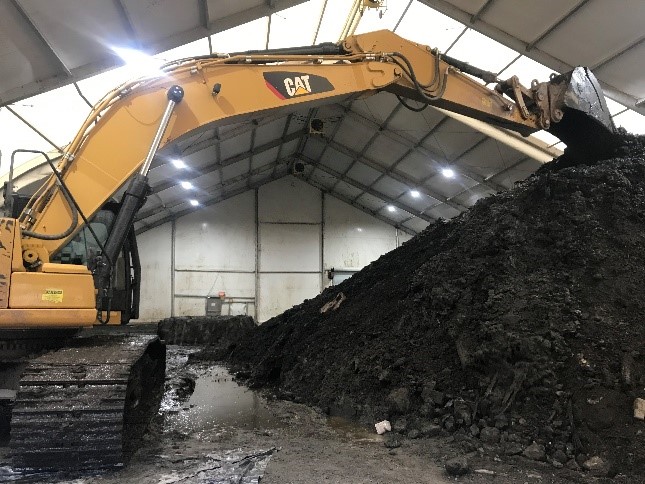

March 2020 - Soil Solidification in the Northwest Tent

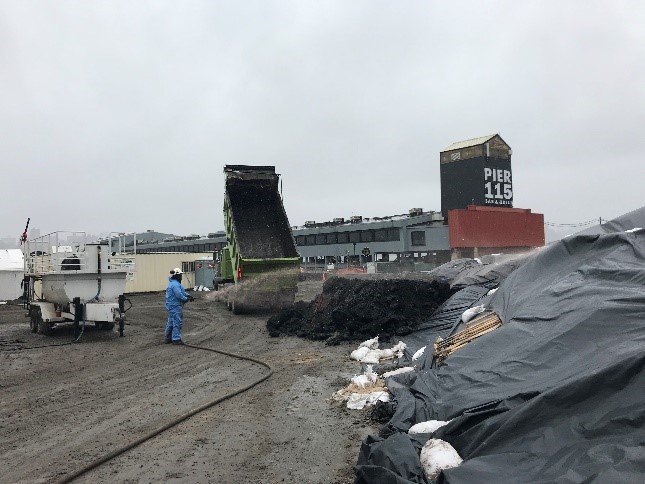

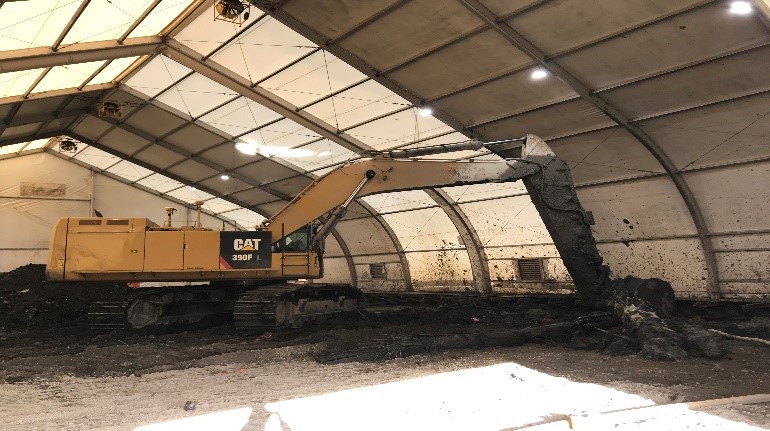

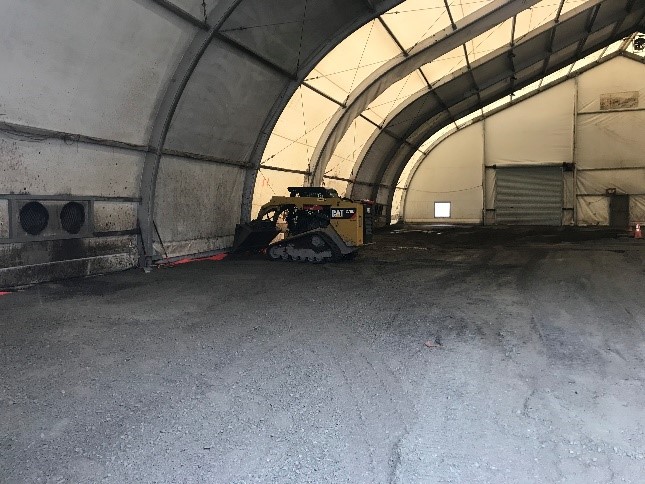

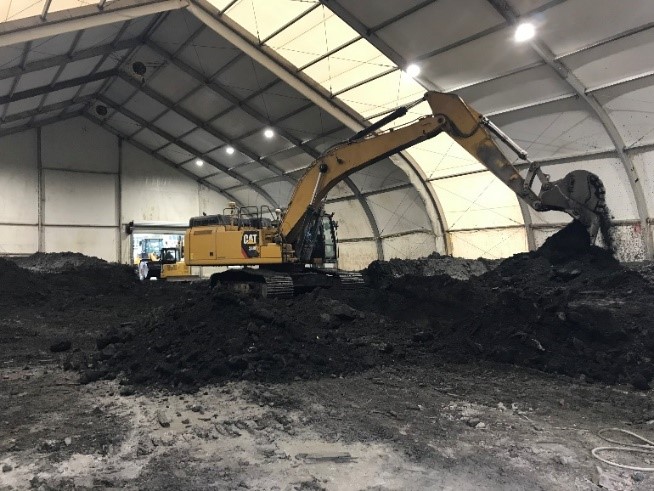

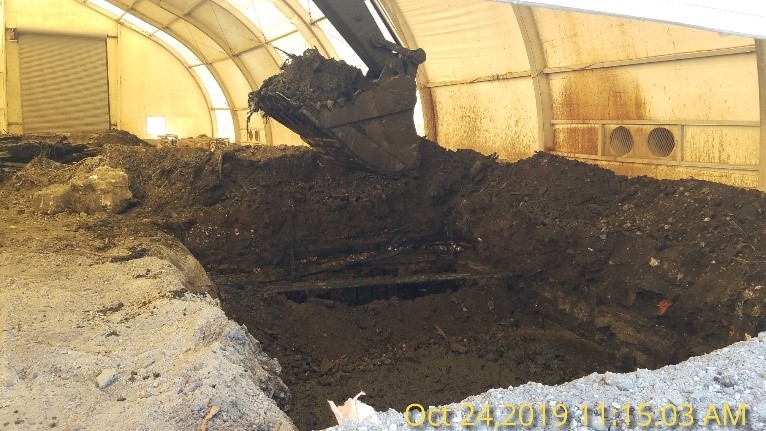

March 2020 - ISS in a Tent

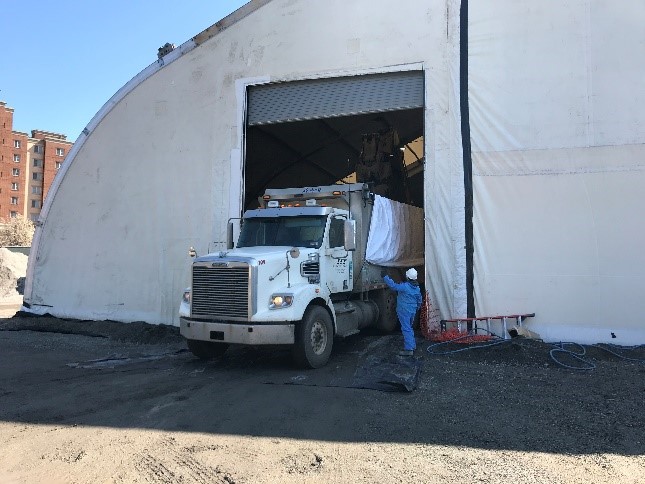

March 2020 - Soil Stockpile Load-Out into Lined Trucks
March 2020 - South Parking Lot Paving
March 2020 - Pulverizing Concrete
March 2020 - Soil Stockpile Management with Odor Control
March 2020 - Non-Tent Area ISS and Odor Control
March 2020 - Non-Tent Area ISS Along the Fenceline

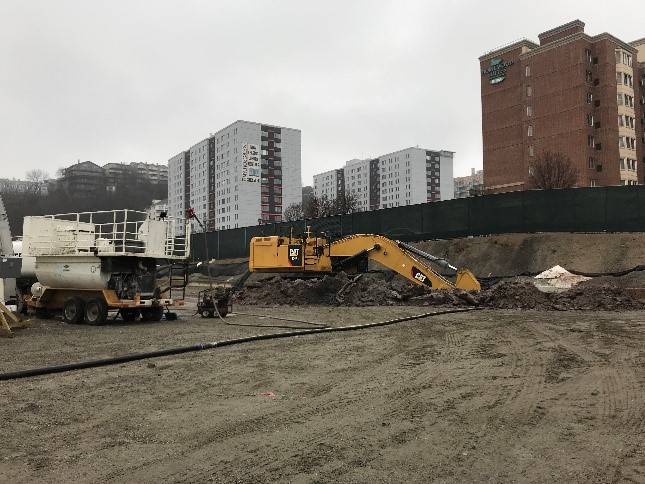

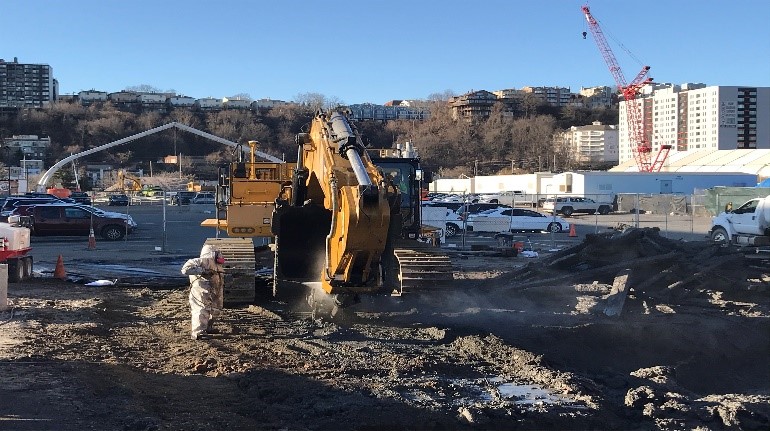

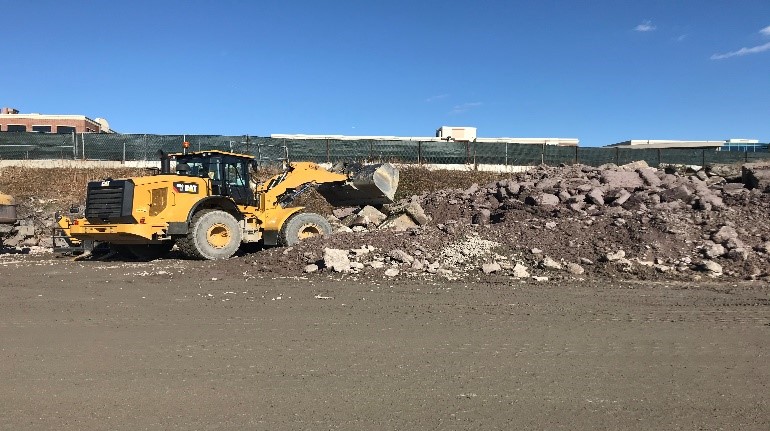

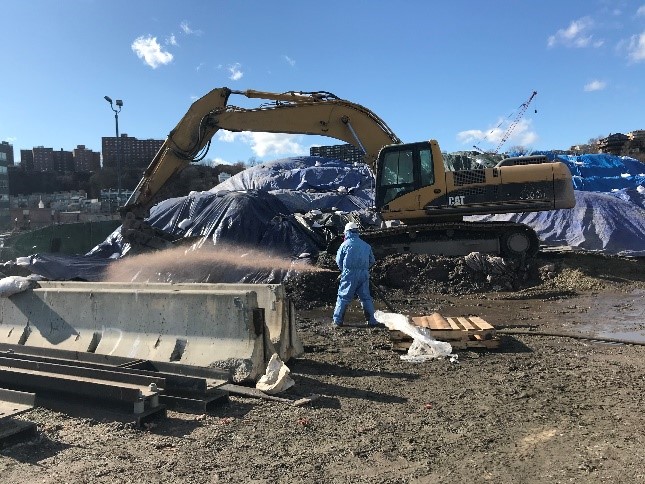

February 2020 - Soil Stockpile Management with Odor Control
February 2020 - ISS in an Un-tented Area along the Fenceline
February 2020 - ISS Sample Collection
February 2020 - Pre-Clearing for ISS

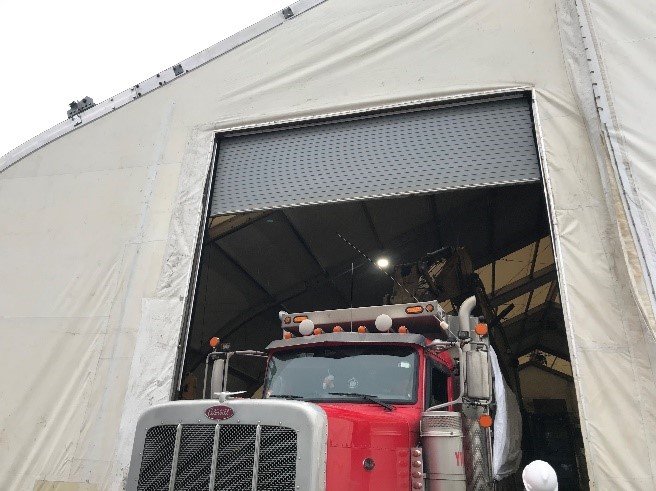

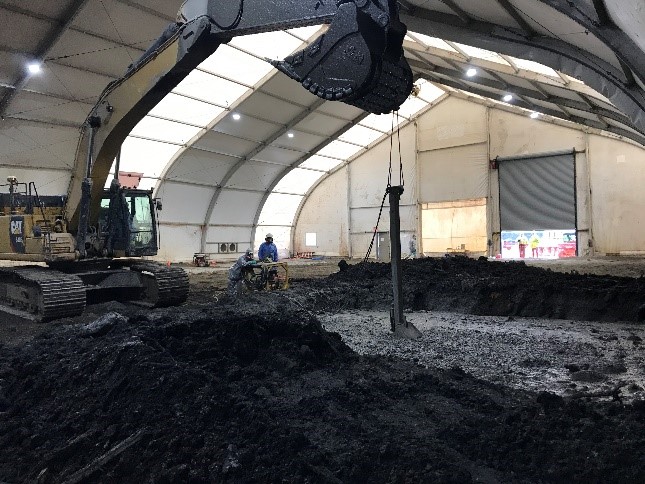

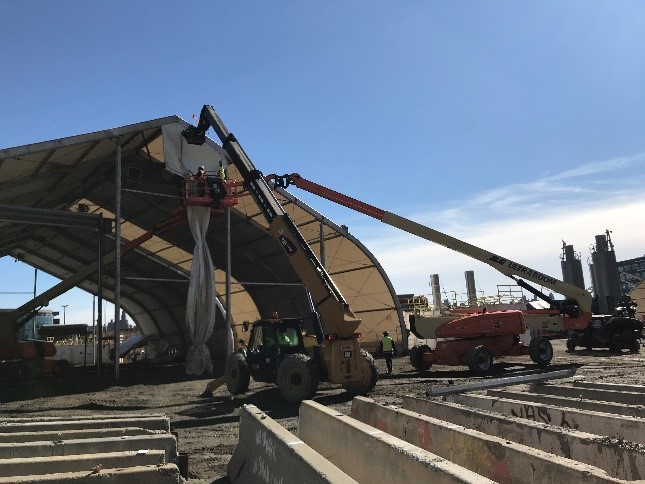

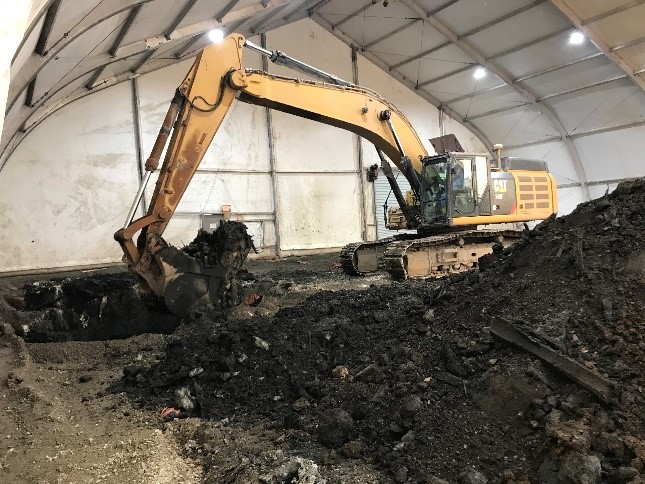

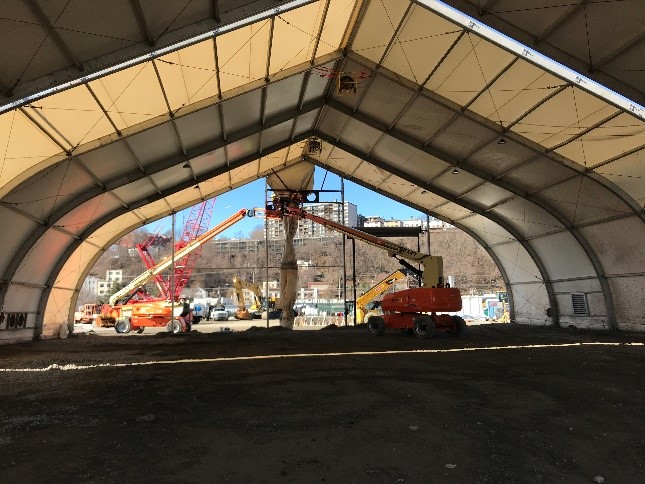

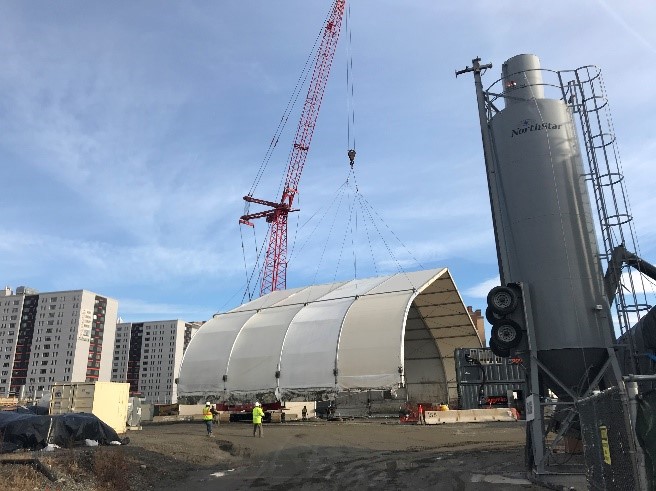

February 2020 - Gravel Cover Removal and Final Commissioning of a Tent

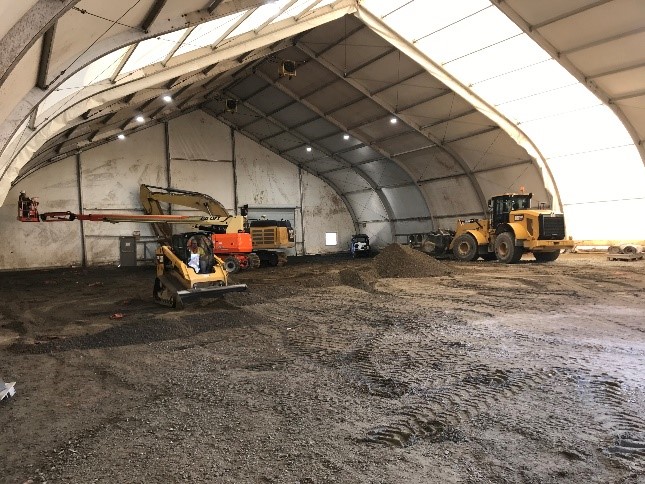

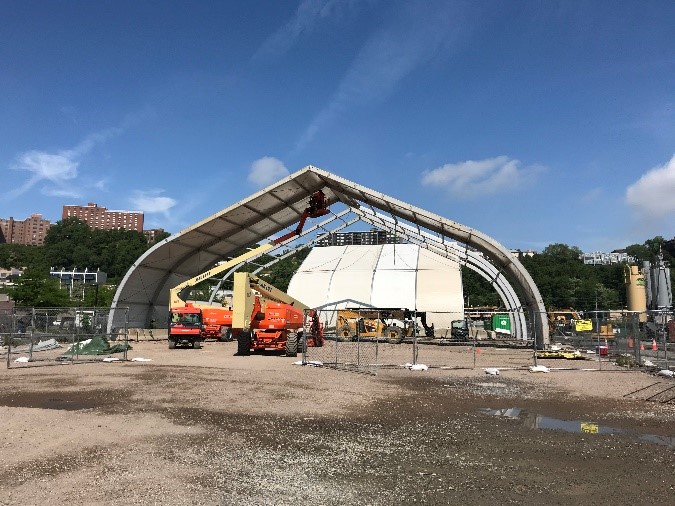

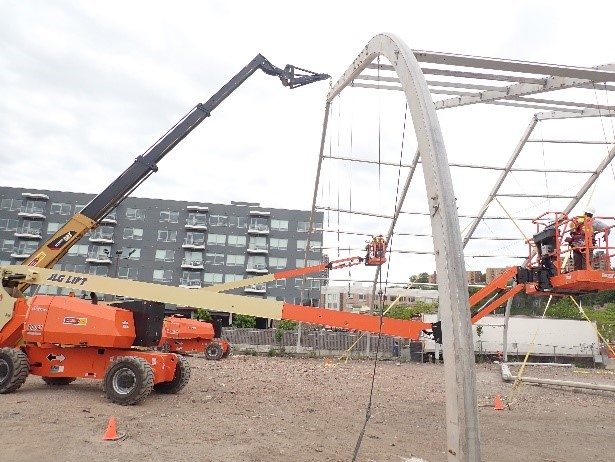

February 2020 - Tent Assembly
February 2020 - Tent Relocation

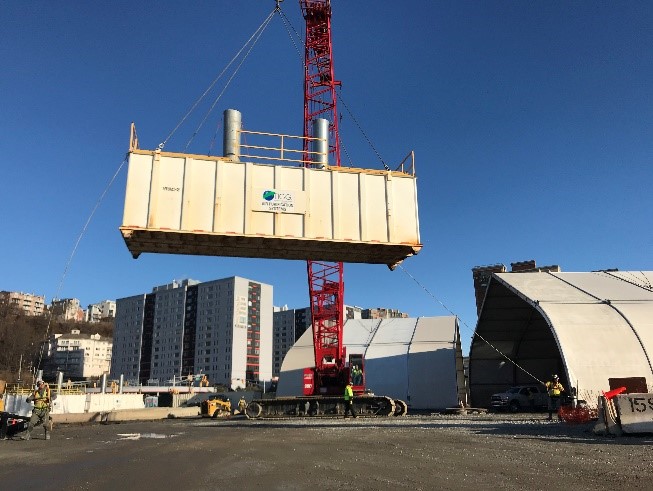

February 2020 - Relocating a Carbon Air Treatment Unit
February 2020 - Relocating a Tent

February 2020 - Removing Excess Soil for Offsite Disposal

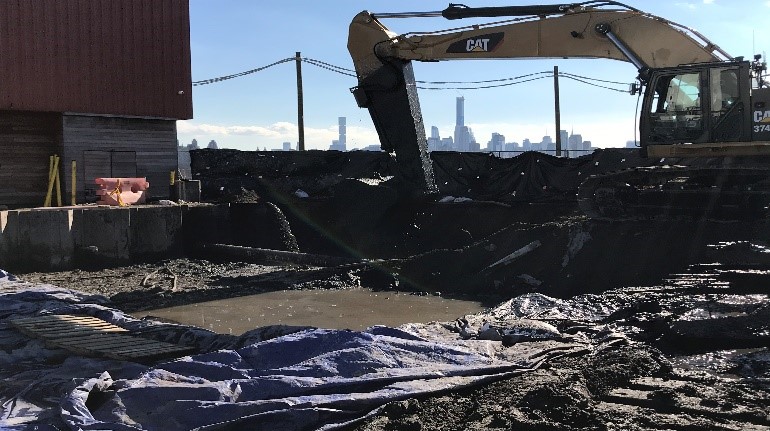

February 2020 - Temporary Cap Installation

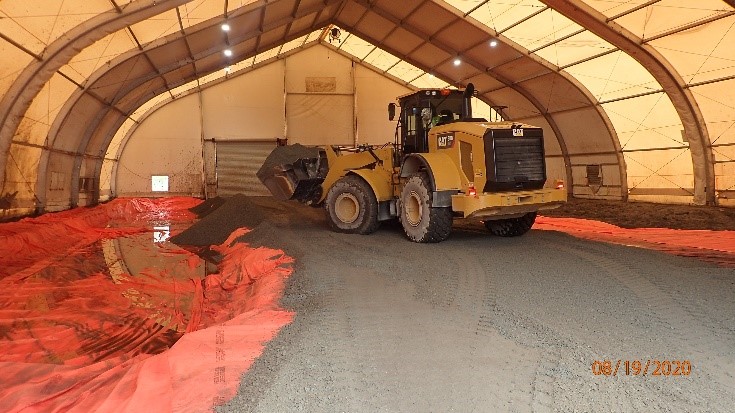

February 2020 - Soil Solidification and Soil Management in the Bulkhead Tent
February 2020 - End of Day Clean-Up and Posi-Shell Application
February 2020 - Soil Solidification in Front of the Pier Building
February 2020 - Managing Concrete Debris from Clearing for Soil Solidification

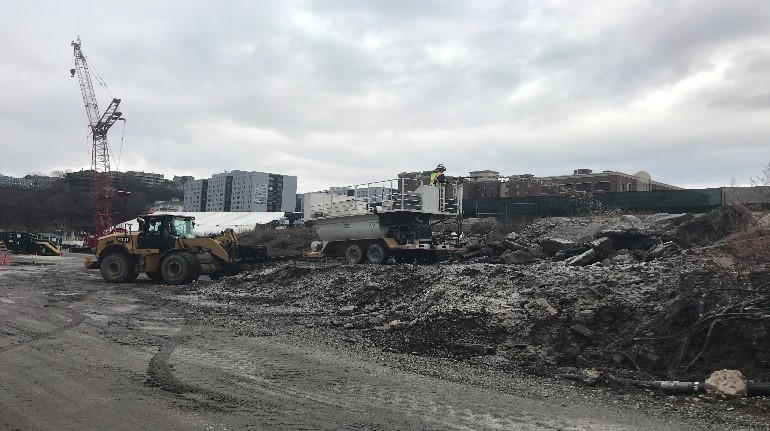

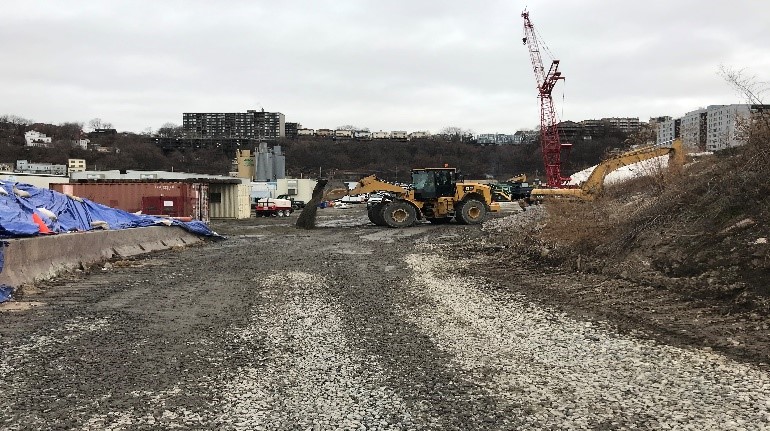

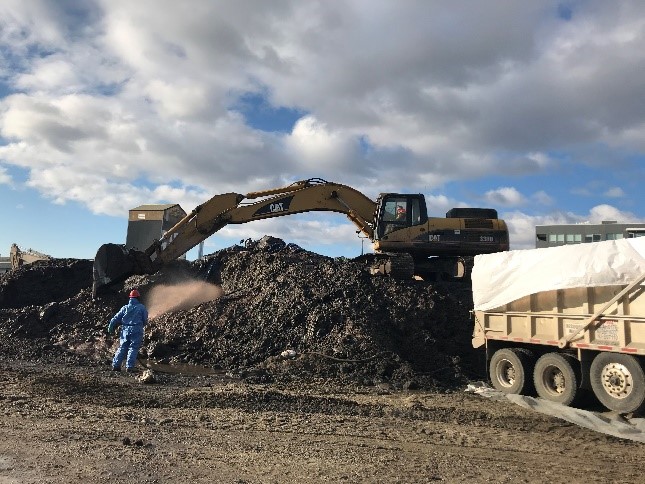

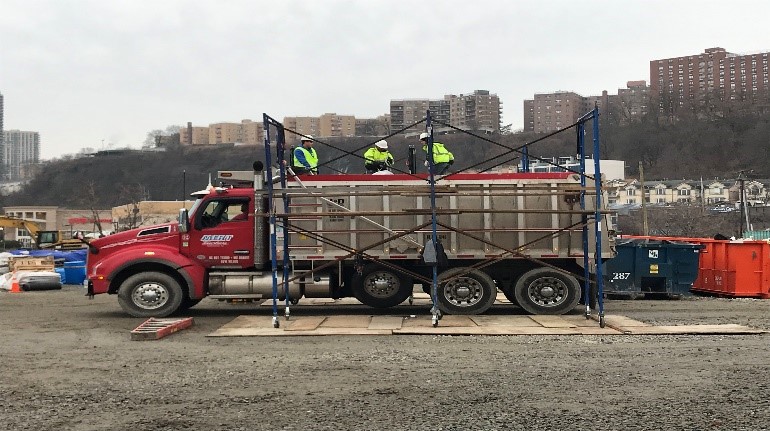

January 2020 - Offloading Overburden Soil at Stockpile
January 2020 - Soil Stockpile Management

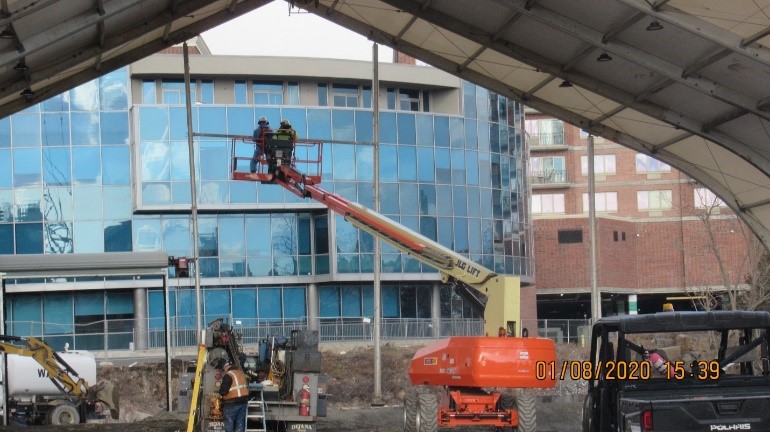

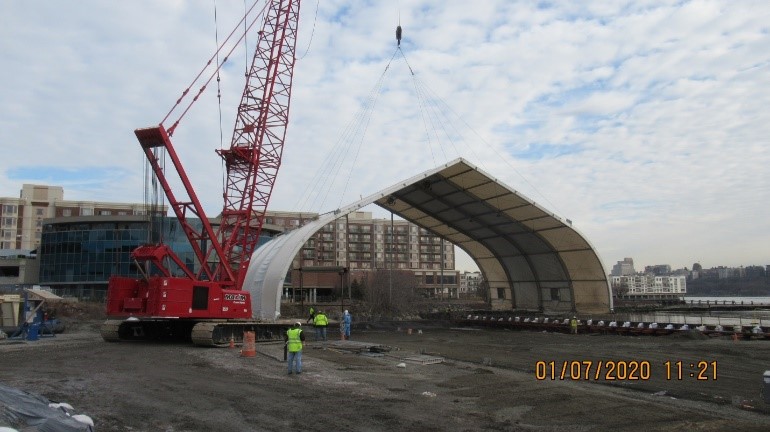

January 2020 - Tent Assembly
January 2020 - Site-Wide Posi-Shell Application

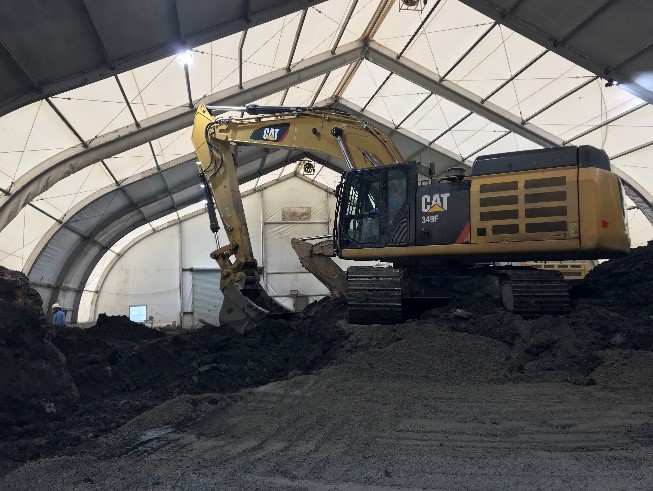

January 2020 - Soil Solidification Inside Bulkhead Tent
January 2020 - Soil Solidification in Front of Pier Building
January 2020 - Preparing Area for Soil Solidification
January 2020 - Main Quanta Site Road Maintenance
January 2020 - Spent Carbon Management
January 2020 - Soil Stockpile Management with Posi-Shell Application
January 2020 - Assembling Bulkhead Tent in New Location
January 2020 - Relocation of Bulkhead Tent
January 2020 - Lining Truck for Soil Loadout

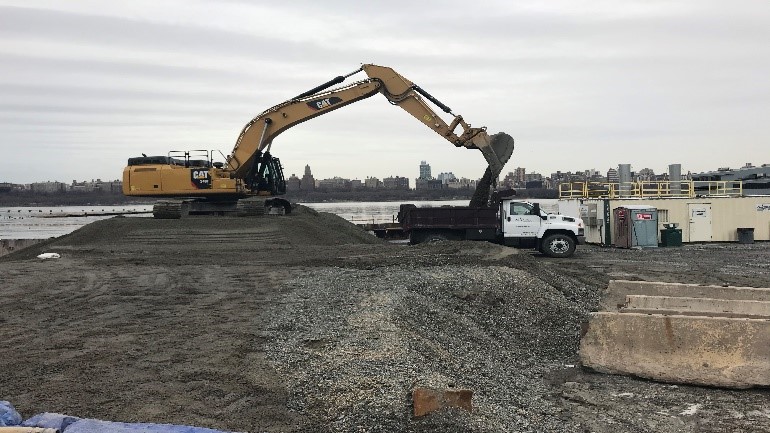

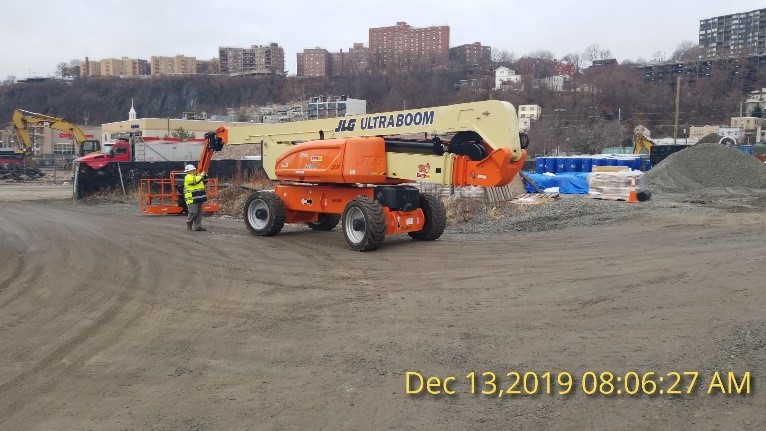

December 2019 - Leveling Gravel Surface to Prepare for Bulkhead Tent Placement
December 2019 - Reshaping Soil Stockpile to Prepare for Truck Loadout
December 2019 - Conduit Installation for Pier Building Telecommunication Relocation

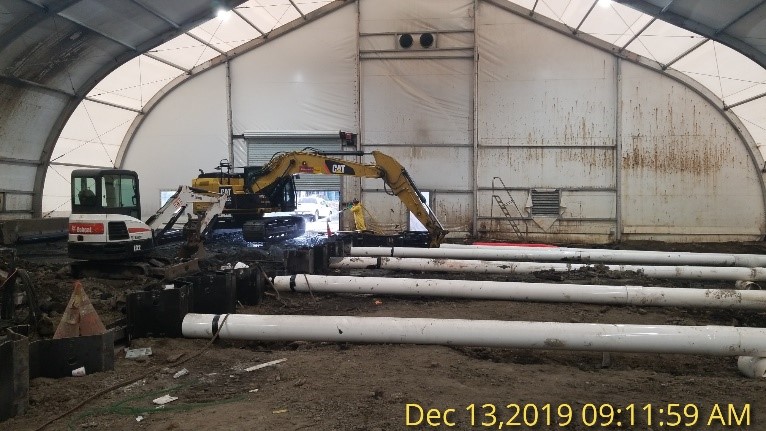

December 2019 - Temporary Cap Installation in Bulkhead Tent
December 2019 - Pre-Clearing for Soil Remediation in Northwest Tent
December 2019 - Managing Gravel Cap Along the River
December 2019 - Mobilizing Lift for Moving Bulkhead Tent
December 2019 - Completed Installation of Sheets, Whalers, and Tie Rods in Bulkhead Tent
December 2019 - Restoration of Privacy Fencing South of Pier Building
December 2019 - Scraping Surface of Soil Solidification to Remove Debris and Loose Material Before Capping in Bulkhead Tent
December 2019 - Dump trucks with Liner
December 2019 - Paving Operation Completed in South Parking Lot
December 2019 - Applying Asphalt to Utility Trenches and Large Potholes

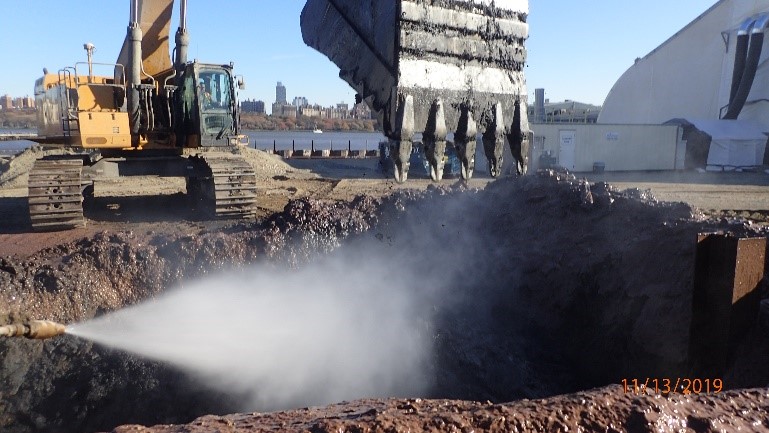

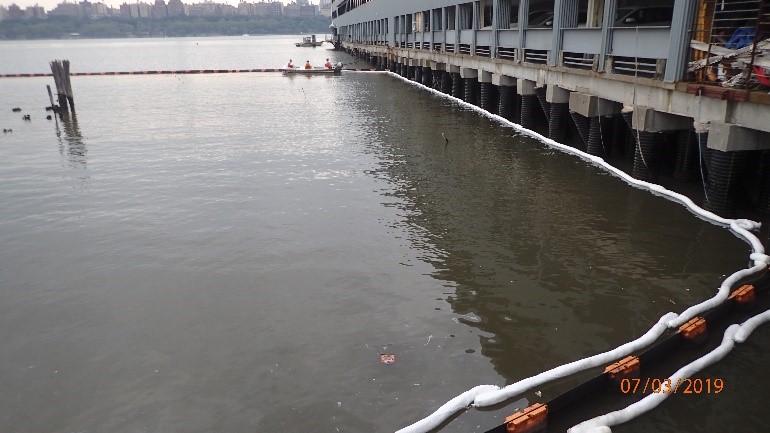

November 2019 - Absorbent Boom Replacement in Waterway
November 2019 - End of Day Odor Control Activities
November 2019 - ISS Outside Tents along Bulkhead
November 2019 - Clearing and Debris Management
November 2019 - Reshaping Soil Stockpile
November 2019 - Restoration South of Pier Building
November 2019 - Collecting ISS Compliance Sample
November 2019 - NOdor Control and Clearing
November 2019 - Odor Control and Clearing
November 2019 - Removing Concrete Debris
November 2019 - Electrical conduit installation in South Parking Lot

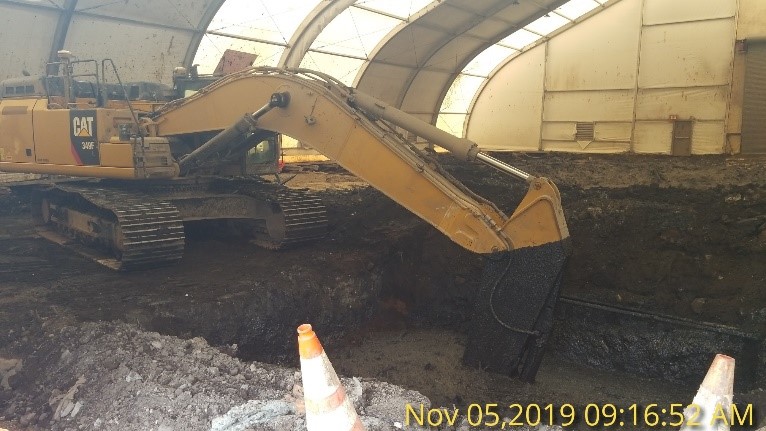

November 2019 - ISS within Bulkhead Tent

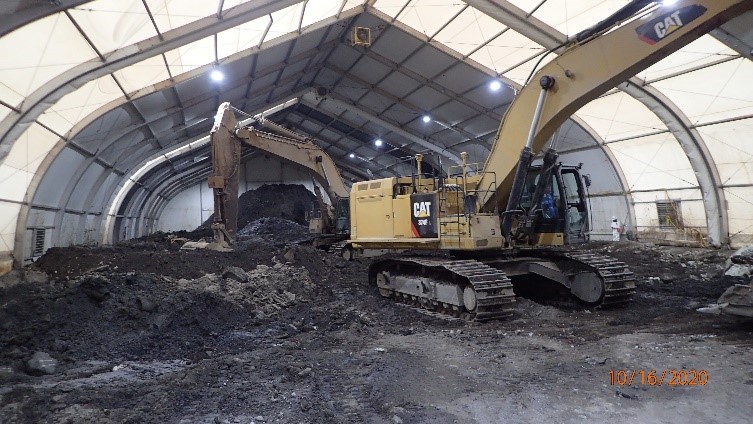

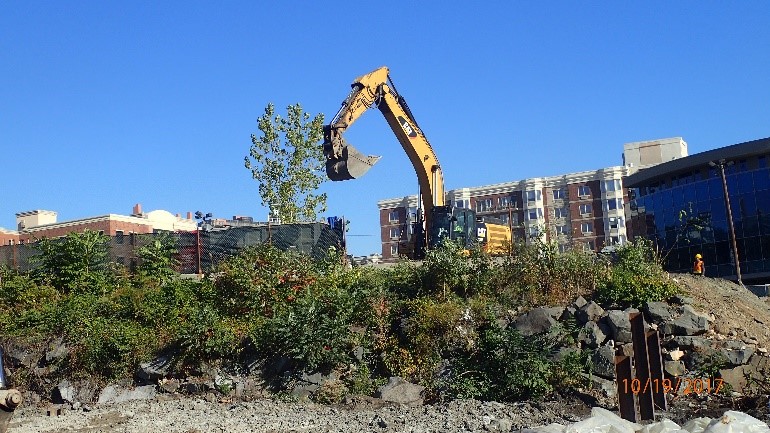

October 2019 - Covered Soil Stockpile at Close of Day
October 2019 - Crane Mobilized for Driving Sheet Piles
October 2019 - Pre-clearing Debris in Bulkhead Tent in Preparation for Soil Solidification
October 2019 - Soil Solidification within Tent in Northwest Area
October 2019 - Routine Boom Replacement in River

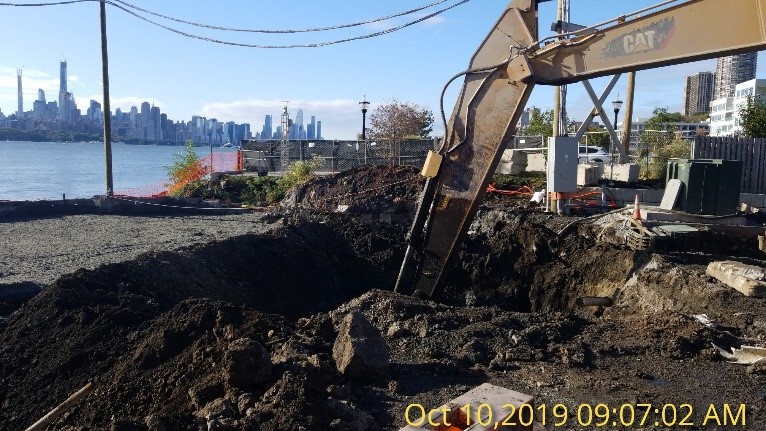

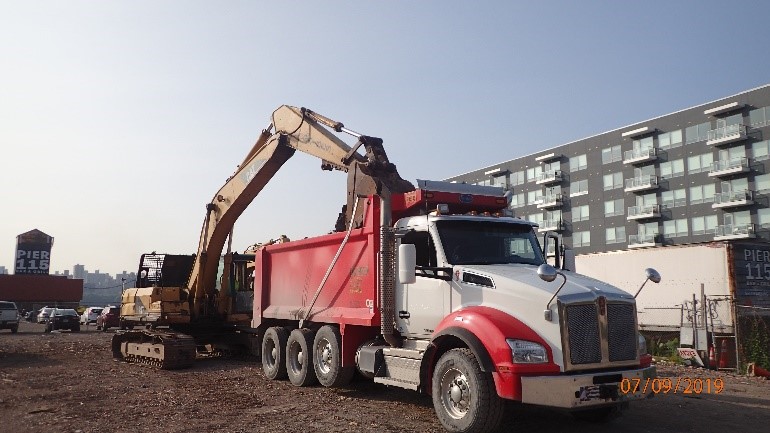

October 2019 - Lined truck Leaving Station
October 2019 - Pumping Water to Stormwater Treatment System After Rain
October 2019 - Trucks Removing Soil Offsite Lined with Burrito Bag

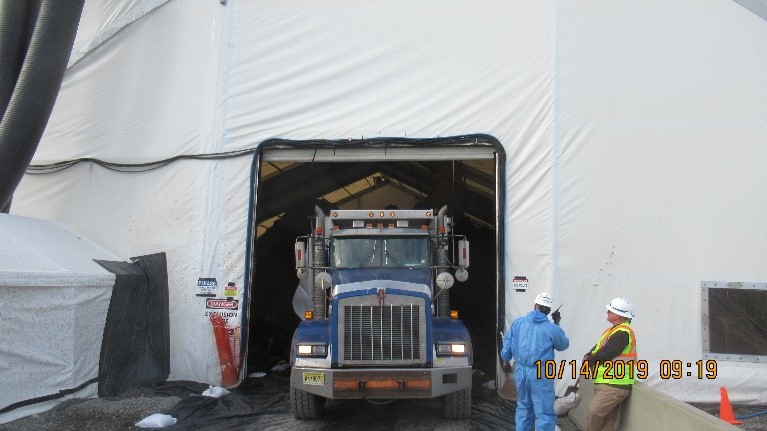

October 2019 - First day of Offsite Soil Removal in Bulkhead Tent
October 2019 - Outdoor ISS South of Pier Building
October 2019 - Pre-clearing South of Pier Building to Remove Concrete, Pilings, and Other Debris
October 2019 - Repairing Hard Boom South of Pier Building
October 2019 - Moving Stockpiled Soils Within Tent in Northwest Corner
October 2019 - Preparing to Lay Plastic Over Completed ISS and Move Soil Stockpile Within Tent in Northwest Corner
October 2019 - ISS Within Tent in Northwest Corner
October 2019 - Routine Soft Boom Changeout
October 2019 - Moving Excavator from South of Pier Building to Bulkhead Tent

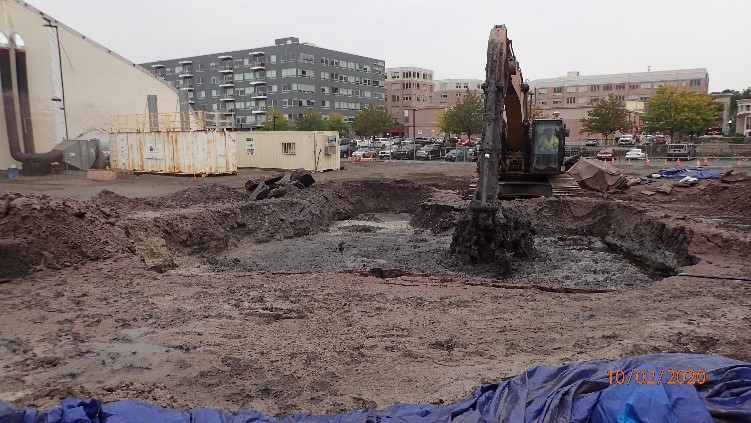

September 2019 - Applying Gravel Cap Over Completed ISS Area South of Pier Building
September 2019 - Completed Areas South of Pier Building Covered with Temporary Cap After Agency Inspection
September 2019 - Soil Mixing Outside Tent South of Pier Building
September 2019 - Re-shaping Soil Stockpile; Applying Posi-shell Odor Control When Disturbing Soils

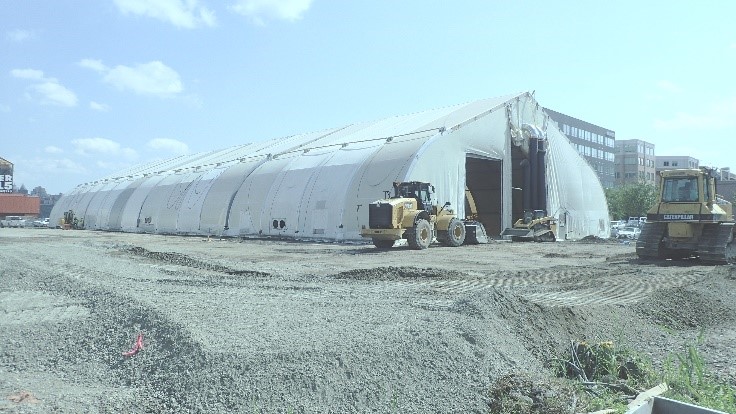

September 2019 - Preparing for Cold Weather by Installing “Hot House” over Quanta Main Site Water Meters
September 2019 - Applying Piian Odor Suppressant During Outside Soil Mixing South of Pier Building
September 2019 - Regularly-scheduled Boom Change in River
September 2019 - ISS South of Pier Building, Working Outside Tents
September 2019 - ISS Cell South of Pier Building, Working Outside Tents

September 2019 - New Pier 115 Pedestrian Walkway Completed
September 2019 - Painting New Pier 115 Pedestrian Walkway Railing to Match Original
September 2019 - Reshaping Stockpile inside Tent

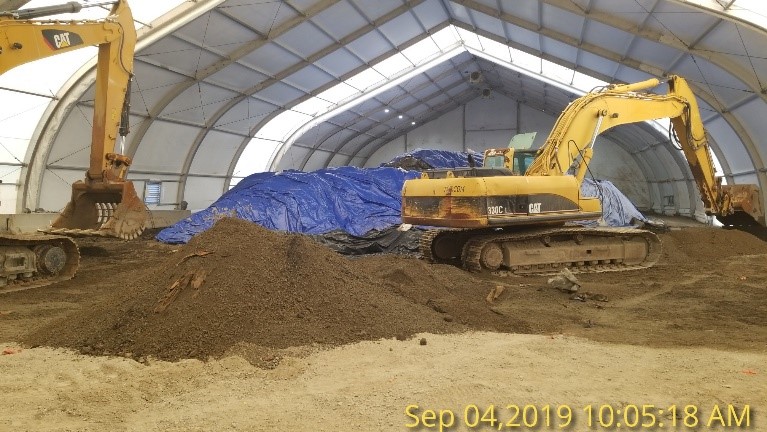

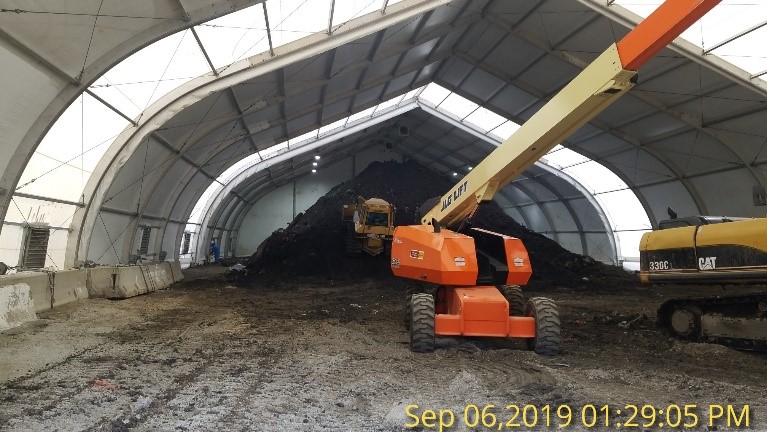

September 2019 - Tent Commissioning and Thinning Gravel Cap

September 2019 - Collecting ISS Sample

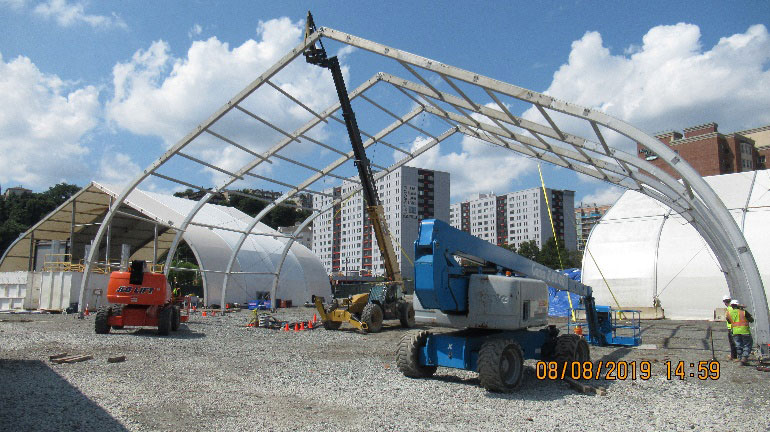

August 2019 - Vapor Sealing Tent (Geotextile and Gravel)
August 2019 - Pre-clearing Before ISS
August 2019 - Installing Fabric Joints to Connect Three Tent Sections
August 2019 - Pumping Stormwater to Treatment System After Heavy Rain and Repairing the Roll-up Door
August 2019 - Rigging to Perform Pullout Test of Baseplate

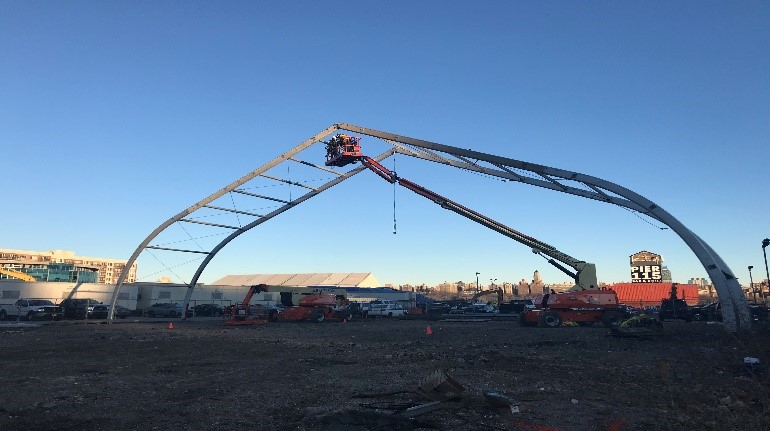

August 2019 - Lifting 3rd Section of Tent into Place
August 2019 - Replacing Privacy Screening on Fence

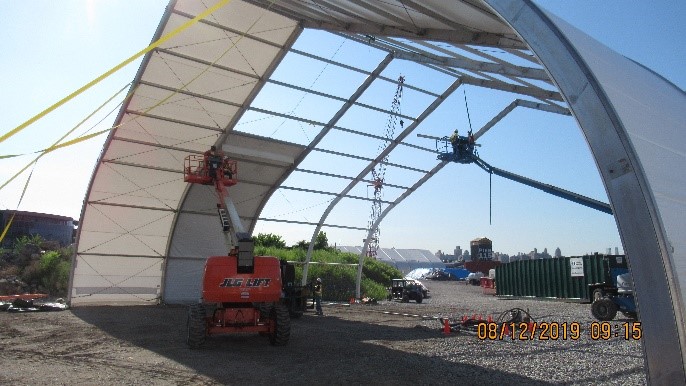

August 2019 - Installing Fabric on Tent Frame

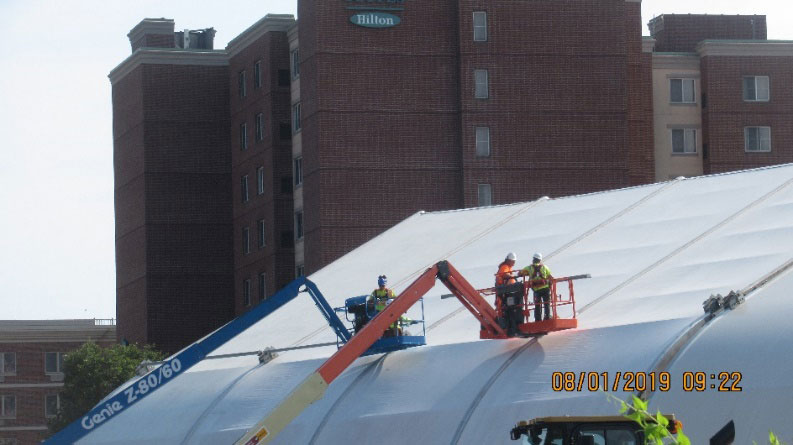

August 2019 - Assembly of Tent's Center Section
August 2019 - Tent's North Section Moved into Position
August 2019 - Installing Lift Kit Compression Bars

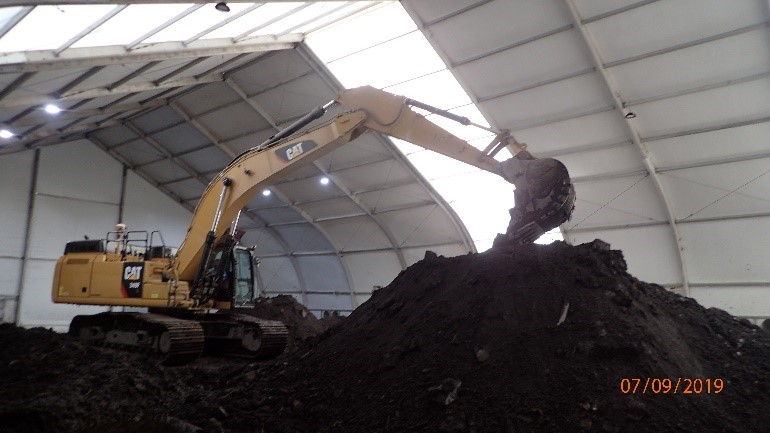

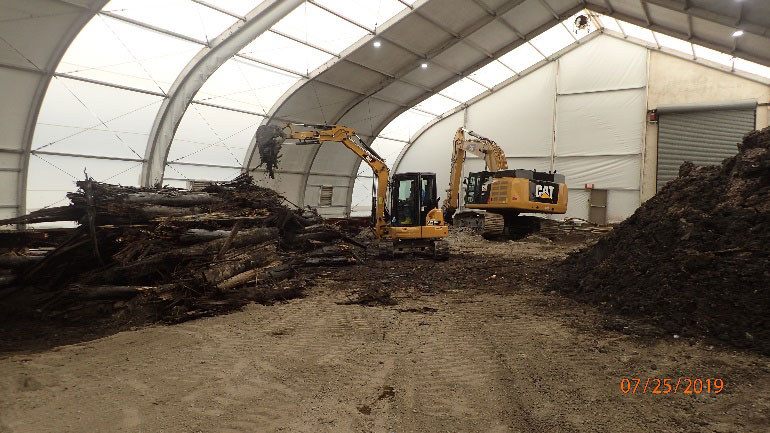

July 2019 - Pre-Clearing ISS Cell
July 2019 - Odor and Dust Control for Slope Disturbance in Preparation for Tent Move
July 2019 - Clearing and Debris Management
July 2019 - ISS in near Bulkhead
July 2019 - Installing North Blower Piping on Tent near Bulkhead
July 2019 - Levelling the South Side
July 2019 - Asphalt Load-Out
July 2019 - Soil Consolidation
July 2019 - Clearing Obstructions from ISS Cells
July 2019 - Absorbent Boom Swap-Out in Waterway
July 2019 - Installing Ceiling Fans

July 2019 - North Parking Lot Paving and Sweeping
July 2019 - Installing North Roll-Up Door

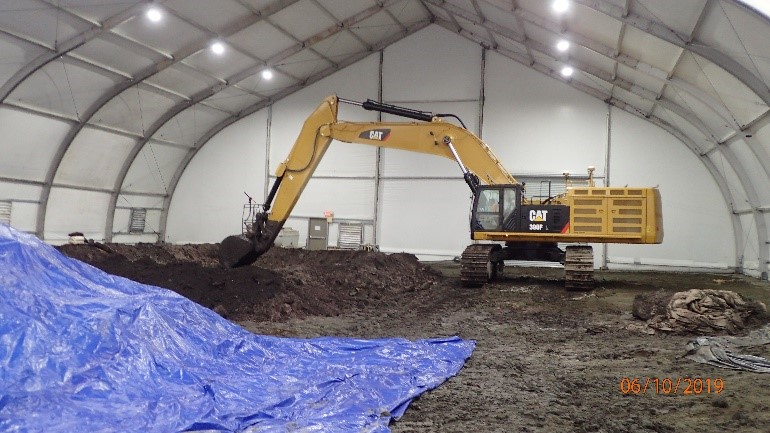

June 2019 - Crushing Concrete

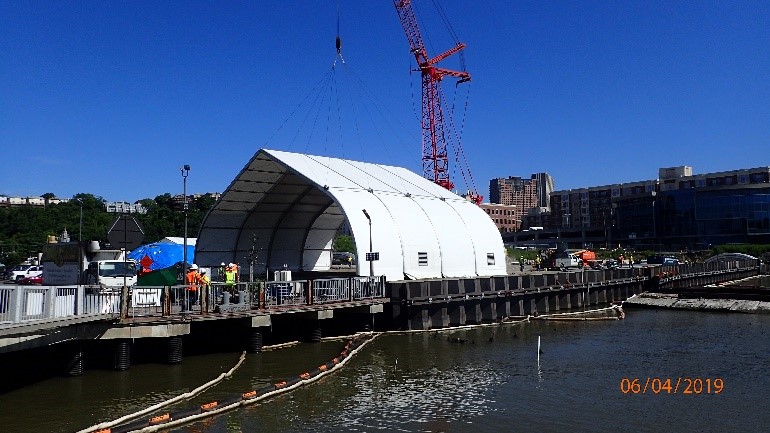

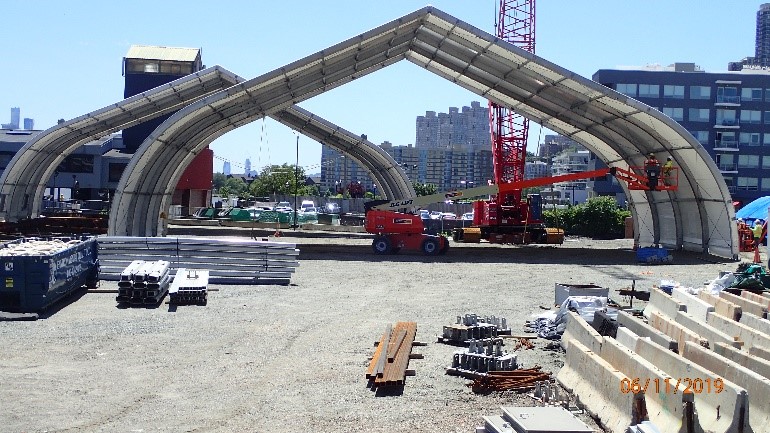

June 2019 - Assembling Tent (near river)
June 2019 - Removing Obstructions from Soil Remediation Cells in (northwest corner of Quanta site)
June 2019 - Soil Remediation in Tent (northwest corner of Quanta site)
June 2019 - Preparing to Place Tent on Bulkhead
June 2019 - LiftinTent onto Bulkhead
June 2019 - Transporting Stockpile into Tent (northwest corner of Quanta site)
May 2019 - Erecting Area 3A Tent
May 2019 - Trenching for Pier Building Gas Line Relocation

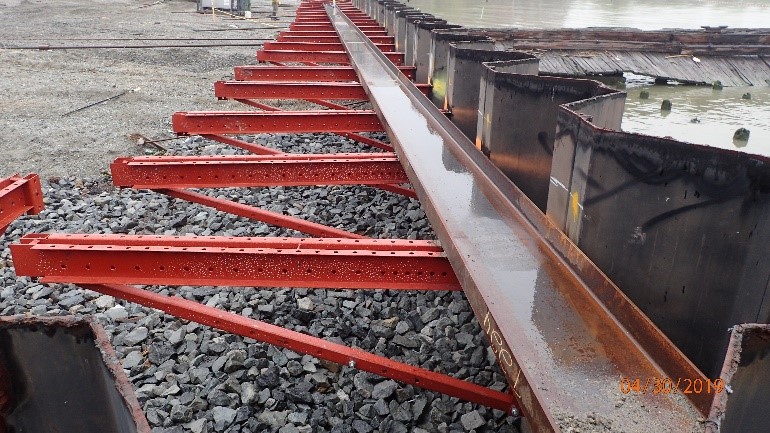

April 2019 - Erecting Area 3A Tent
April 2019 - Laying Out Area 3A Tent
April 2019 - Bulkhead Brackets for Tent Support
April 2019 - Tent Support Bracket Installation on Bulkhead
April 2019 - Assembling Crane

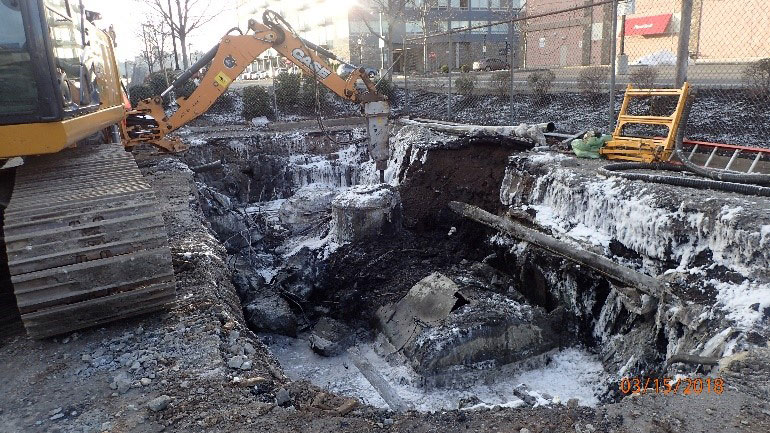

April 2019 - Offloading ISS Tent Delivery
April 2019 - Dust Control Activities
April 2019 - Area 7 Soil Stockpile Posi-Shell Application
April 2019 - Grading Area 7 to Prepare for Tent Installation
April 2019 - ISS Tent Generator Gas Line Installation
April 2019 - Erecting Grout Plant Silos
April 2019 - Offloading ISS Tent Air Handling Systems
April 2019 - Grout Plant Water Line Installation
April 2019 - Installing ISS Tent Generator
March 2019 - Demolition Material Management
March 2019 - Compacting Ground Surface in Demo Area
March 2019 - Area 3A Soil Stockpile Maintenance
March 2019 - Trenching for ISS Tent Generator Gas Line and Electric
March 2019 - Preparing Transformer Pad for ISS Tent Electric
March 2019 - Swapping Absorbent Boom in Waterway
March 2019 - Hammering Above-Grade Building Foundation

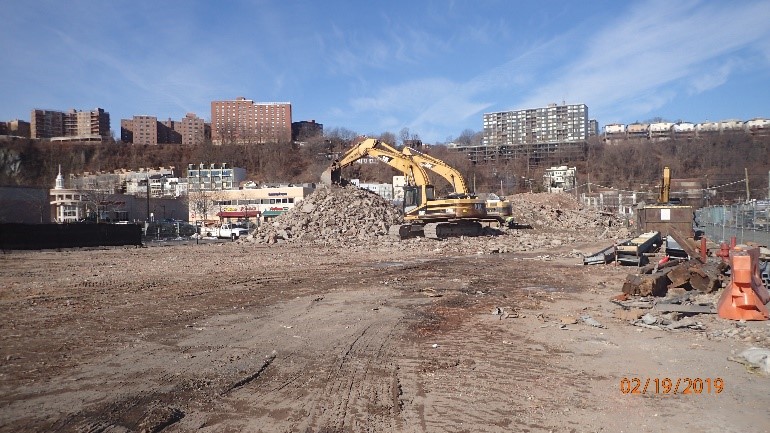

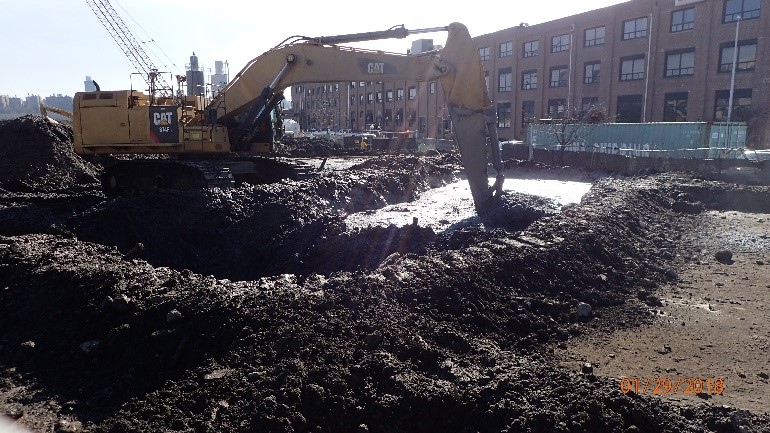

February 2019 - Segment A Bulkhead Installation
February 2019 - Segregating and Stockpiling Demolition Debris
February 2019 - Sizing Steel for Offsite Disposal
February 2019 - Loading Demolition Debris into Roll-Offs
February 2019 - Backfilling Segment B Bulkhead
February 2019 - Cutting Segment B Sheets to Elevation
February 2019 - Pre-Trenching for Utilities for Bulkhead Installation

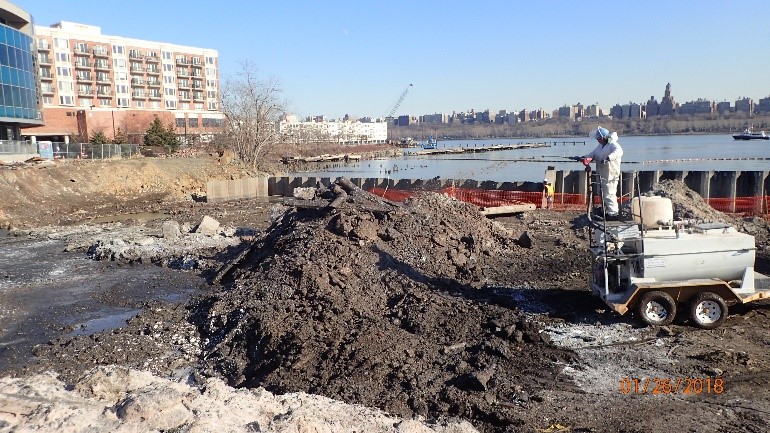

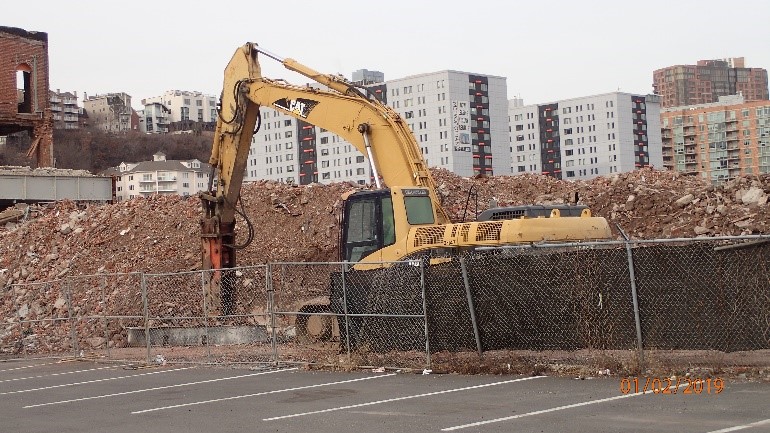

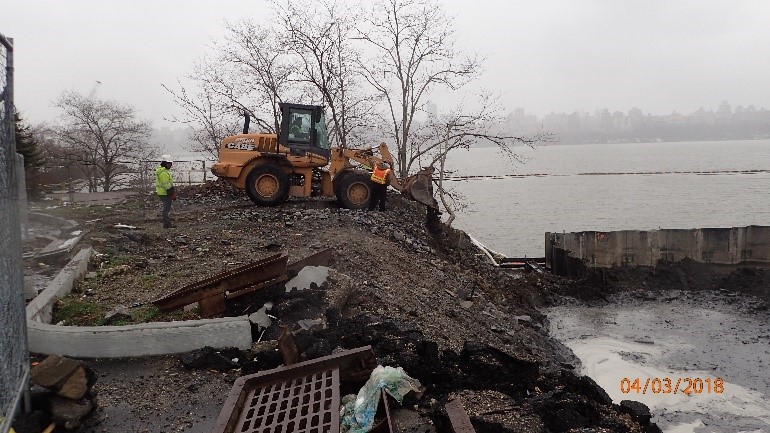

January 2019 - 115 River Road Demolition
January 2019 - Re-Installing Pier Building Pedestrian Walkway
January 2019 - Segment A Bulkhead Installation
January 2019 - Securing Pier Building Driveway Road Plates in Place
January 2019 - Swapping Absorbent Boom in Waterway
January 2019 - Auxiliary Parking Lot Parking Space Striping
January 2019 - Demolition Material Management
December 2018 - Preparing Auxiliary Parking Lot Area for Paving
December 2018 - Above-Grade Building Foundation Removal
December 2018 - Demolition Material Management
November 2018 - 115 River Road Exterior Demolition
November 2018 - 115 River Road Exterior Demolition and Dust Control

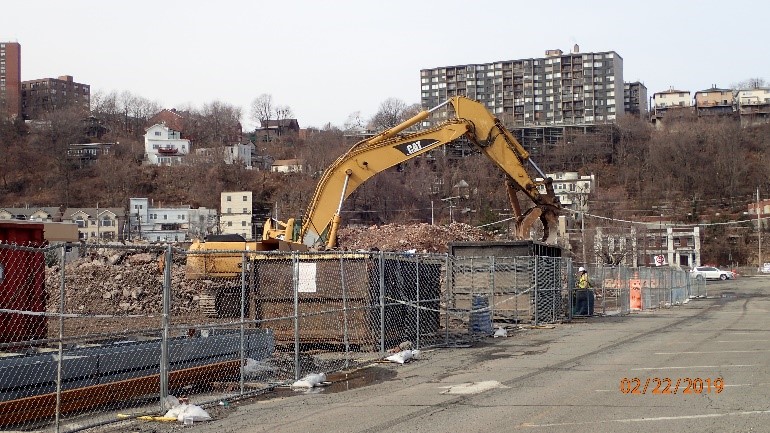

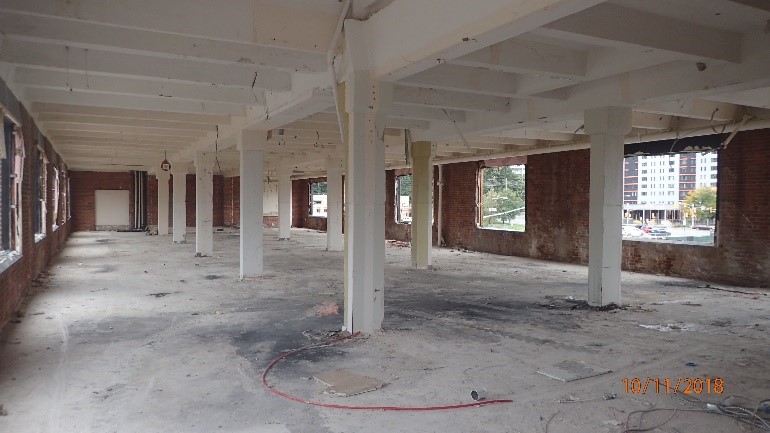

October 2018 - 115 River Road Interior Demolition
November 2018 - 115 River Road Interior Demolition
November 2018 - Demolition Debris Management
October 2018 - 115 River Road Exterior Demolition and Dust Control
October 2018 - 115 River Road Demolition Material Management

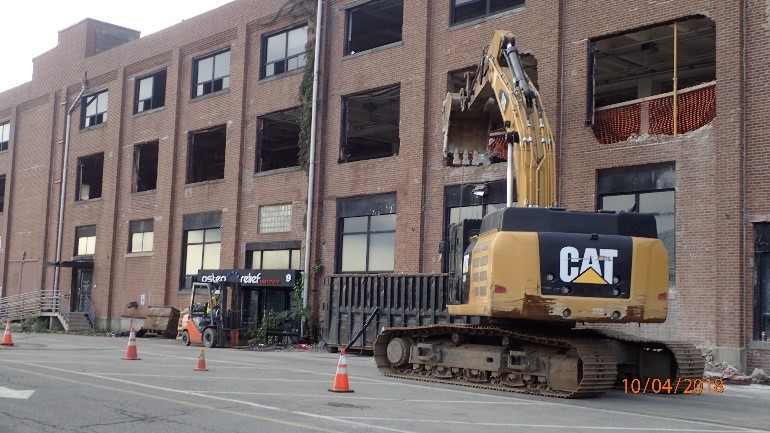

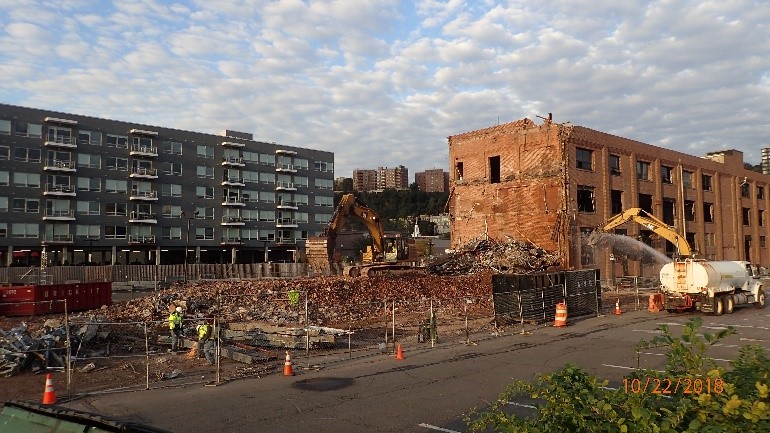

September 2018 - 115 River Road Gas and Electric Meter Removal
August 2018 - Demobilizing Loader from Main Quanta Site
August 2018 - Area 7 Soil Stockpile Cover Maintenance
August 2018 - 115 River Road Clean-Up for Prepare for Demolition
August 2018 - Preparing for ACM Abatement at 115 River Road
August 2018 - Parking Lot Striping at Area 2
August 2018 - Universal Waste Removal in 115 River Road
August 2018 - Deploying Rodent Traps for 115 RR Demolition
August 2018 - Area 2 Final Capping Activities
June 2018 - Absorbent Boom Replacement
June 2018 - Paving Over Temporary Utility Trench in South Parking Lot
June 2018 - Summer Covering of Stockpile

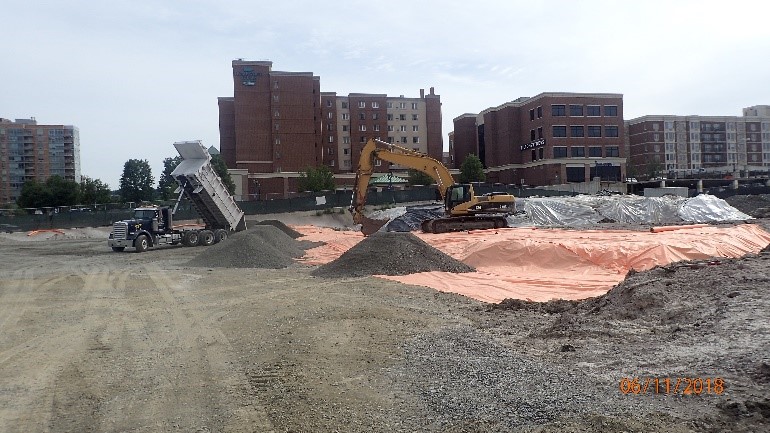

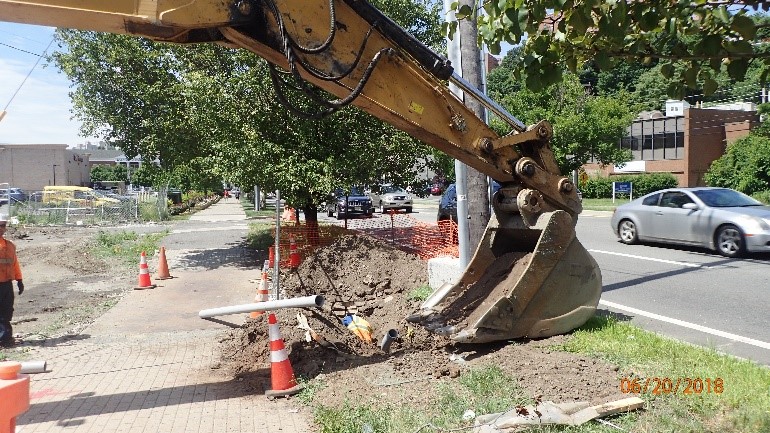

June 2018 - Telecommunication Installation for Pier Building

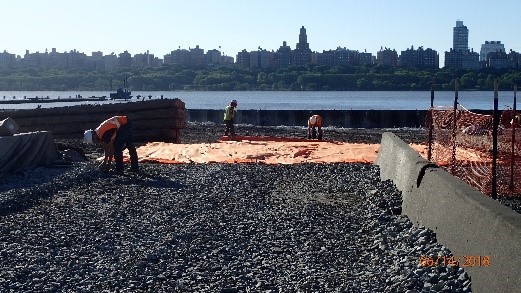

June 2018 - Stockpile Liner Installation
June 2018 - Installing construction fabric and crushed stone over finished ISS area
June 2018 - Grading crushed stone over construction fabric in finished ISS area
June 2018 - Installing construction fabric over finished ISS area in preparation for installing crushed stone.
June 2018 - Stockpile management
June 2018 - Temporary sewer line installation in South Parking Lot
June 2018 - Decommissioning grout plant silos
June 2018 - Relocating Grout Plant Silos for Staging
June 2018 - Temporary Sewer Line Installation in South Parking Lot
June 2018 - Re-Covering Stockpile with Poly Sheeting
May 2018 - Absorbent Boom Replacement in River
May 2018 - End of the Day Posi-Shell Application on Stockpile
May 2018 - Temporary Sewer Line Install in South Parking Lot
May 2018 - Managing Overburden Stockpile
May 2018 - Applying Posi-Shell with Concrete for Weekend
May 2018 - Installing Replacement Tie-Rod Close to Bulkhead
May 2018 - Temporary Sewer Line Installation in South Parking Lot

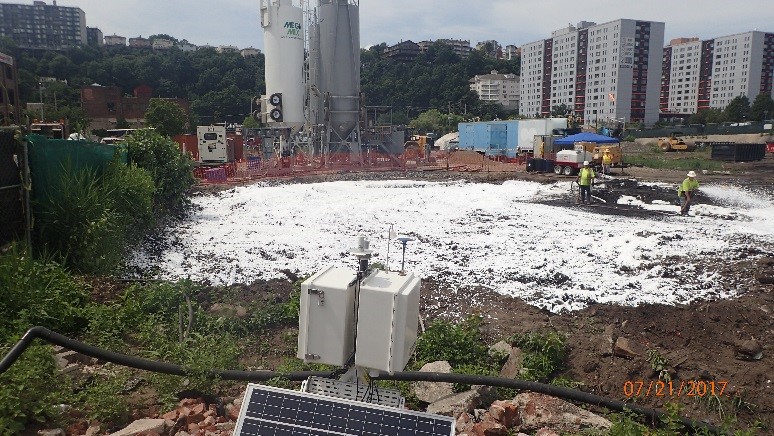

May 2018 - Testing 'Odor Boss' with ISS in Main Quanta Area
May 2018 - Severance Area Clean-Up
May 2018 - ISS on Main Quanta Site
May 2018 - End of the Day Posi-Shell Application
May 2018 - Exposing Tie-Rods and Applying Rusmar Foam
May 2018 - Installing Plastic Sheeting on Soil Stockpile
May 2018 - South Parking Lot Clean-Up Activities
May 2018 - Exposing Tie-Rods for Upgrades

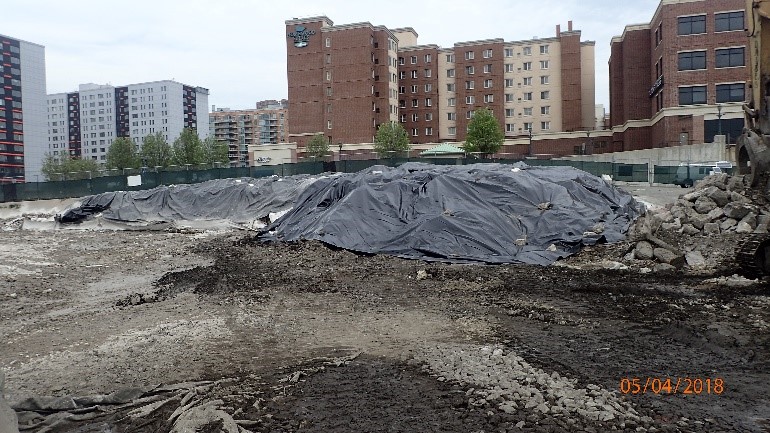

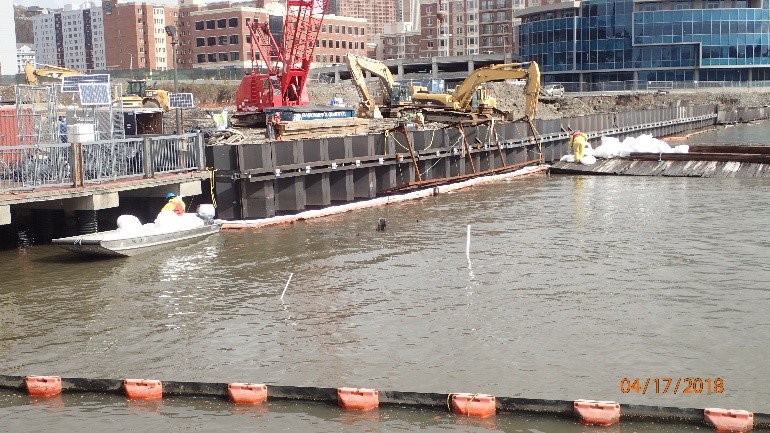

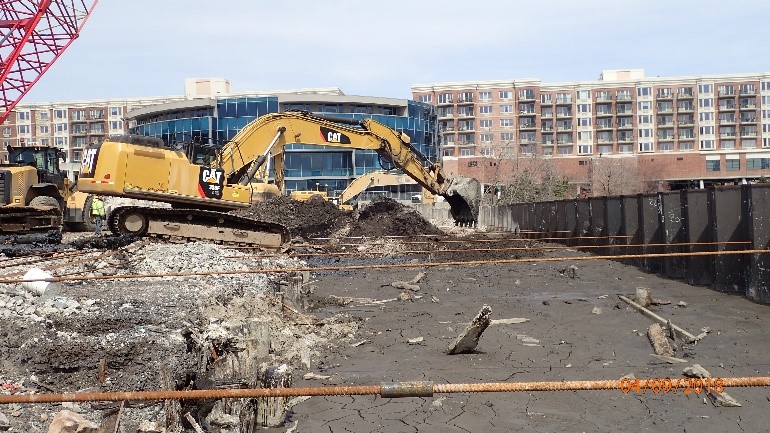

April 2018 - Re-Covering Soil Stockpile
April 2018 - Trenching for Temporary Electric in South Parking Lot
April 2018 - Backfilling and ISS on the Main Quanta Site
April 2018 - Trailer Complex Relocation
April 2018 - Temporary electric installation in South Parking Lot
April 2018 - Infiltration sump installation on main Quanta site
April 2018 - Absorbent boom replacement
April 2018 - ISS on the main Quanta site
April 2018 - Installing construction fabric and crushed stone over finished ISS area
April 2018 - Backfilling behind the sheet pile
April 2018 - Trenching for temporary electric in south parking lot
April 2018 - Loading treated wood into roll-off and foaming
April 2018 - Backfilling behind northeast corner of bulkhead

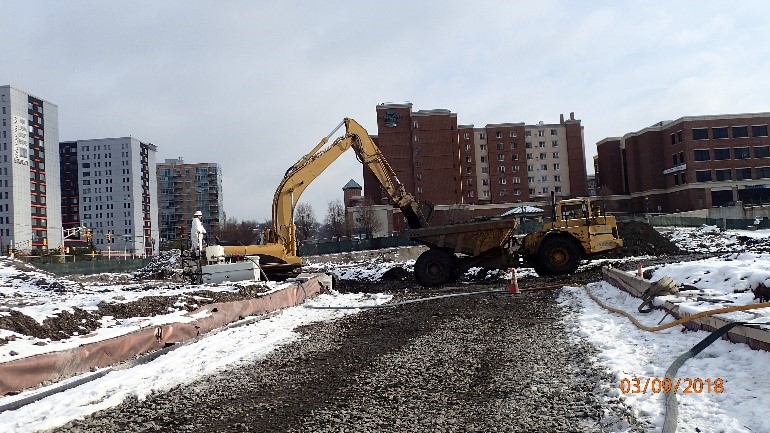

March 2018 - Building new 'clean haul road' across site
March 2018 - Paving finished ISS area
March 2018 - Grading finished ISS area
March 2018 - Installing construction fabric and crushed stone over finished ISS area
March 2018 - Restoration North of the 115 River Road Building
March 2018 - Removal of an Underground Storage Tankin the South Parking Lot
March 2018 - Maintenance of the Decon Pad
March 2018 - Grading, with Poly Sheet Covering and Posi-Shell for Odor Control
March 2018 - Removing Berm Material from Completed ISS Area
March 2018 - Grading and Applying Posi-Shell in the Main Quanta Site
March 2018 - Trenching for Temporary Electric in South Parking Lot

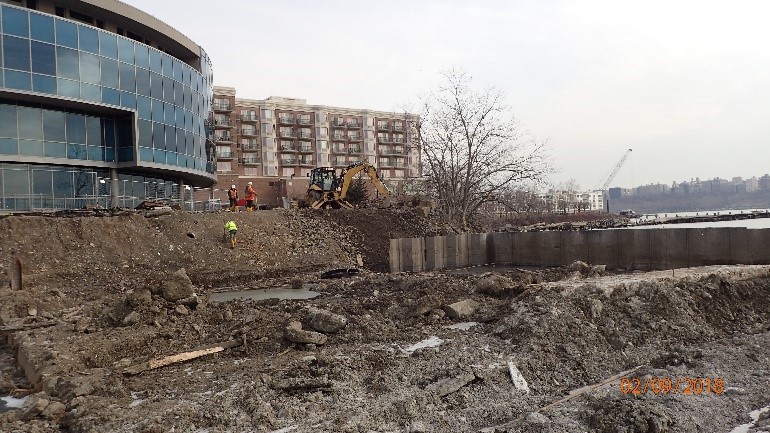

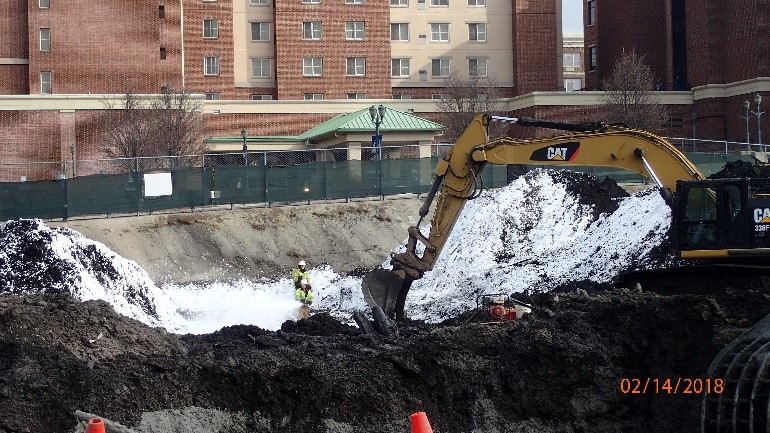

February 2018 - Clearing and Applying Rusmar Foam in the Main Quanta Site
February 2018 - ISS with Bucket Excavator in the Main Quanta Area

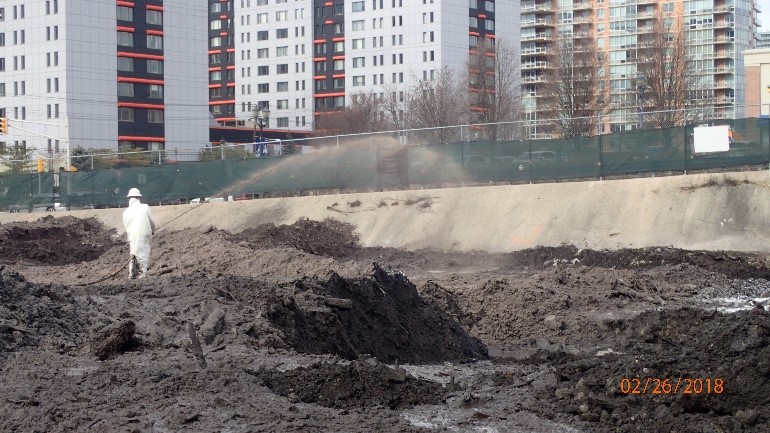

February 2018 - Perimeter Misting System Operation
February 2018 - Foaming with Rusmar During Clearing

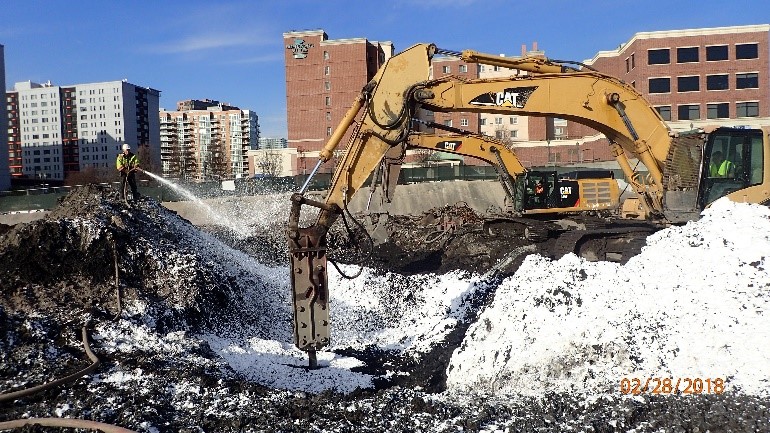

February 2018 - Applying Posi-Shell at the End of the Day
February 2018 - Installing Poly at the End of the Work Week

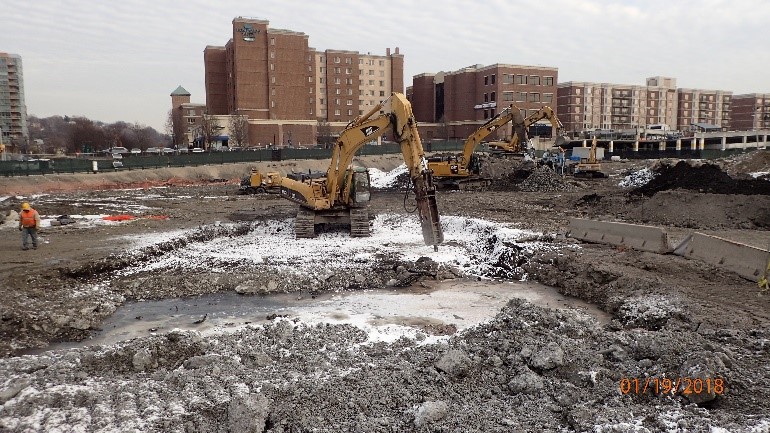

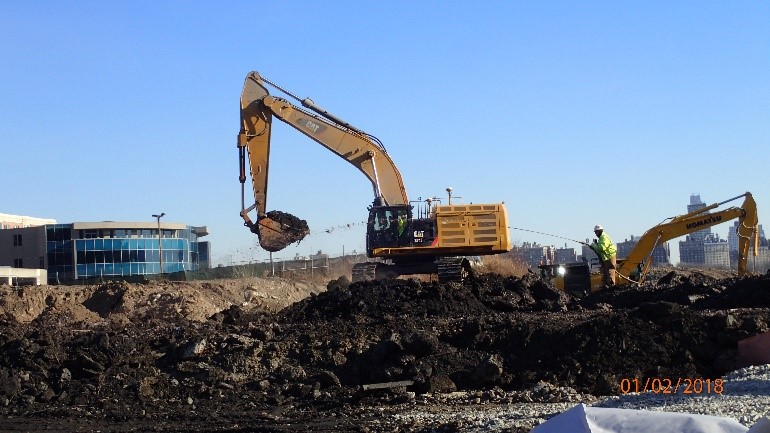

February 2018 - Subsurface Concrete Removal on the Main Quanta Site
February 2018 - Clearing on the Main Quanta Site for Concrete Removal
February 2018 - Removing Backfill from Behind the Bulkhead

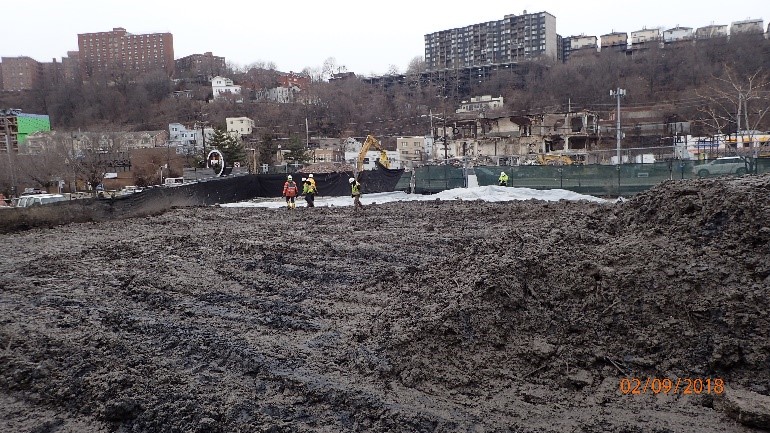

February 2018 - Pre-Clearing, ISS, and Posi-Shell Application on the Main Quanta Site
February 2018 - Clearing on the Main Quanta Site
February 2018 - Installing Plastic Covering on the Main Quanta Site
February 2018 - Backfilling Behind Bulkhead
February 2018 - Removing Wood Pilings from the Main Quanta Site

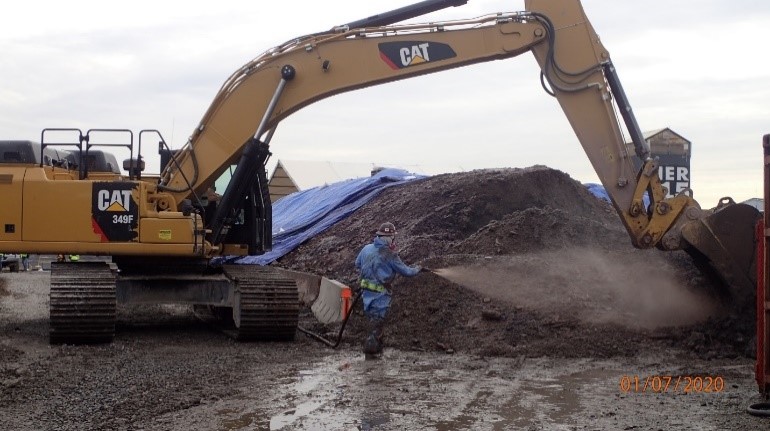

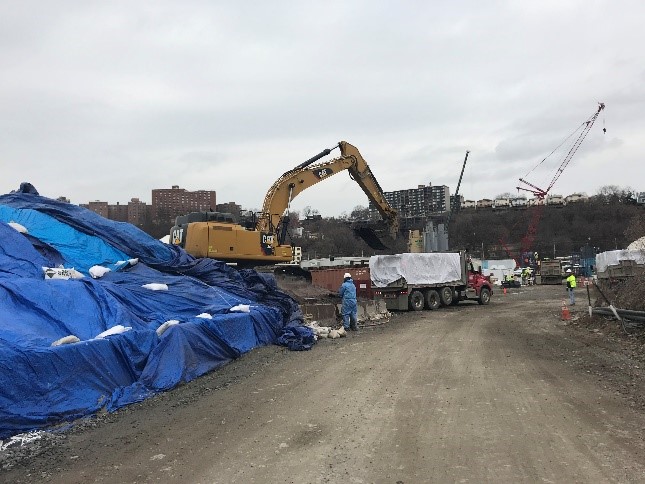

February 2018 - BioSolve Application During ISS on the Main Quanta Site

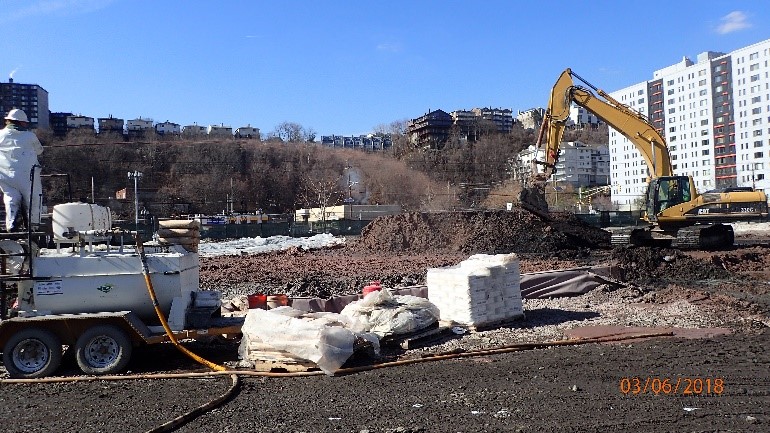

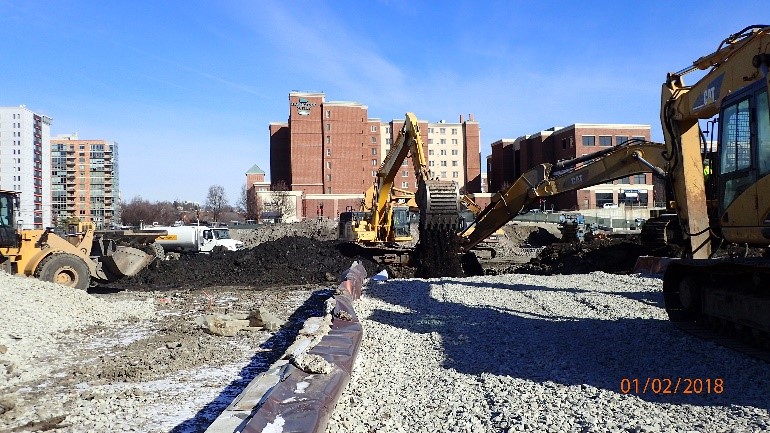

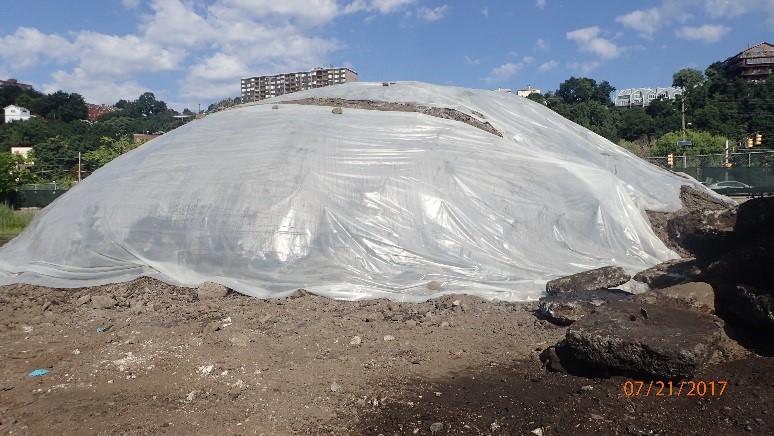

January 2018 - Pre-Clearing and Posi-Shell Application on the Main Quanta Site

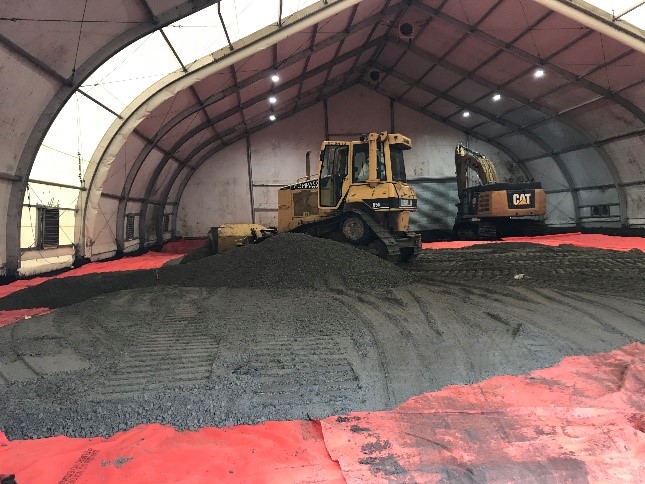

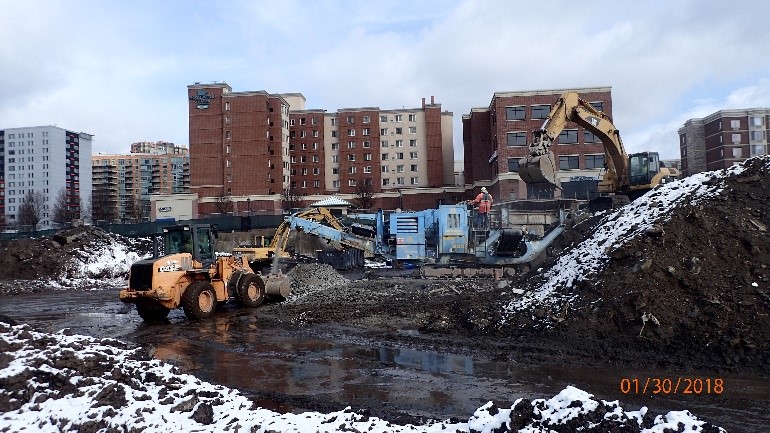

January 2018 - Crushing Category 1 Stone

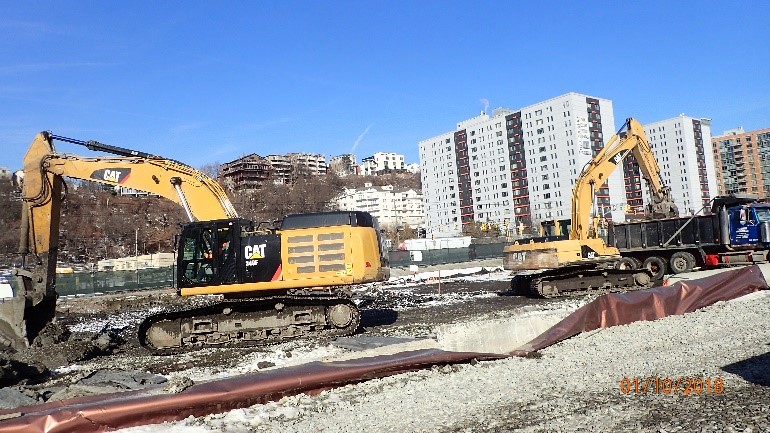

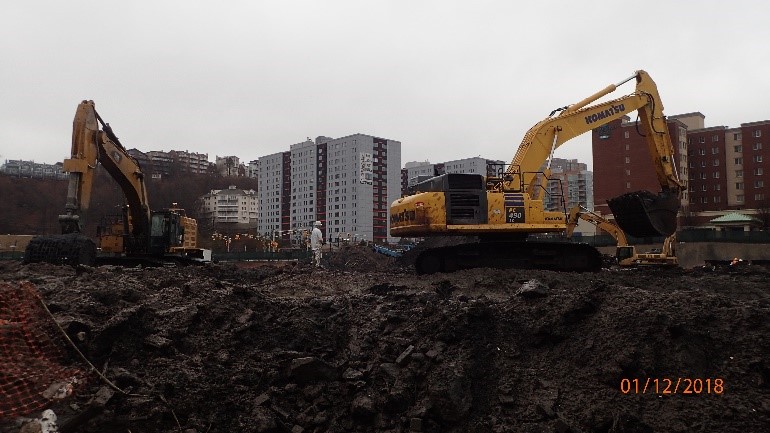

January 2018 - ISS on the Main Quanta Site
January 2018 - Posi-Shell Application
January 2018 - Concrete Removal on the Main Quanta Site
January 2018 - Preparing Site for Relocated Crusher
January 2018 - Loading Roll-Off Boxes
January 2018 - Material Management on the Main Quanta Site
January 2018 - Crushing Operations on the Main Quanta Site
January 2018 - Posi-Shell Application to Control Odors
January 2018 - ISS, Pre-Clearing, and Posi-Shell Application on the Main Quanta Site

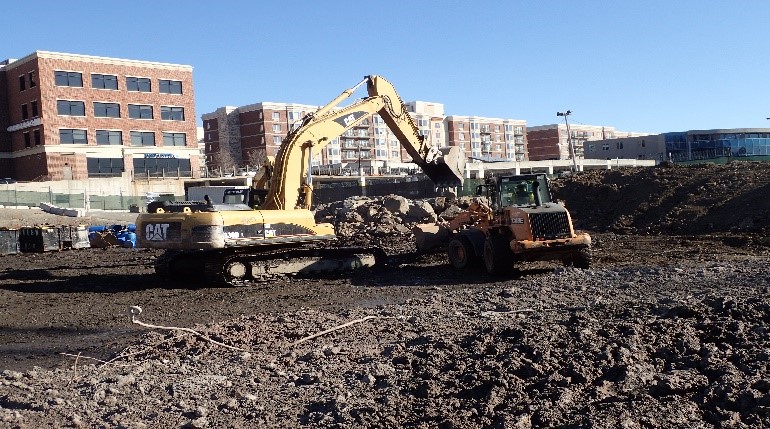

January 2018 - Clearing on the Main Quanta Site
January 2018 - Foam Application/Stockpile Management
January 2018 - Decon Pad Relocation
January 2018 - Clearing and Obstruction Management on the Main Quanta Site

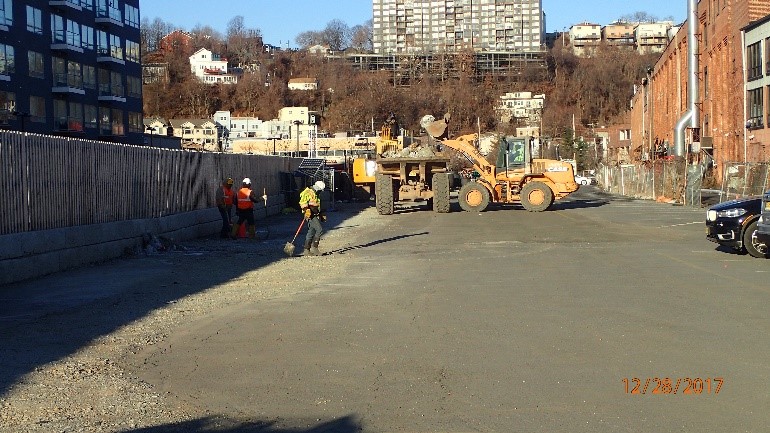

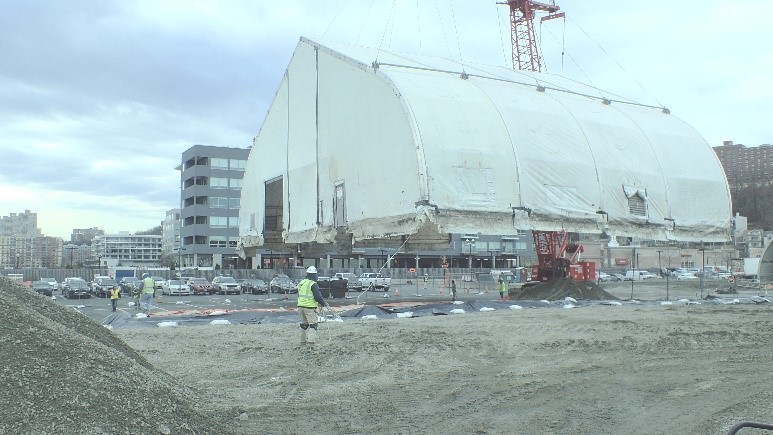

December 2017 - Western Perimeter Fence Line Relocation
December 2017 - Final Restoration South of 115 River Road

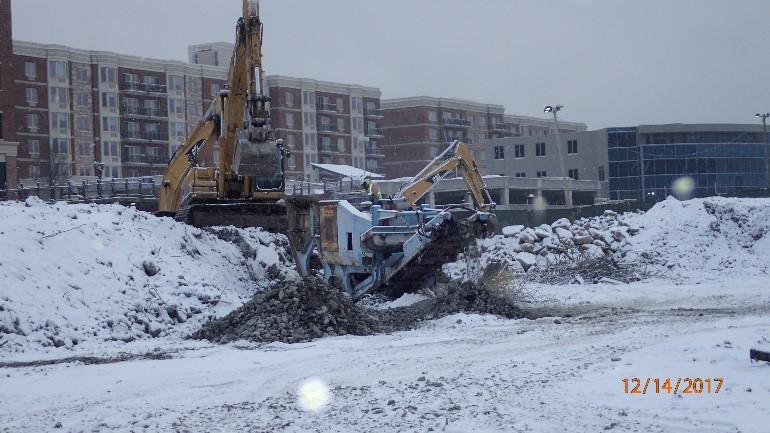

December 2017 - Stockpile Management and Crushing Operations
December 2017 - Clearing and ISS on the Main Quanta Site
December 2017 - South Parking Lot Clean-Up

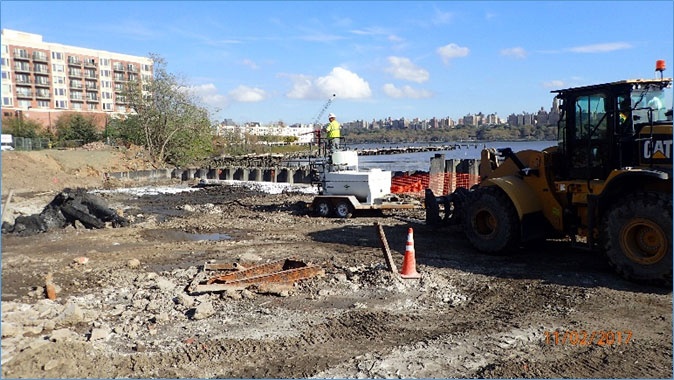

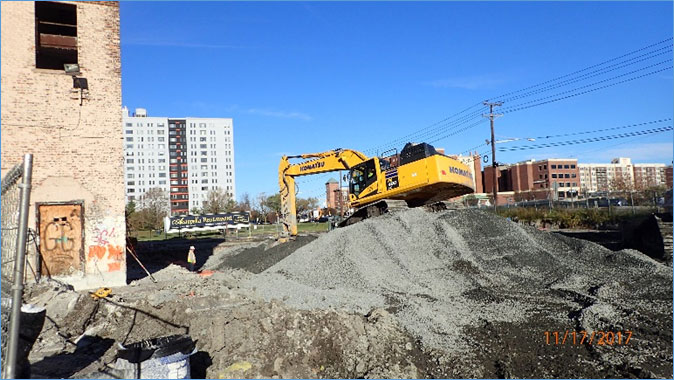

December 2017 - Transporting Pilings from Clearing on Main Quanta Site
December 2017 - Clearing and Foaming on the Main Quanta Site

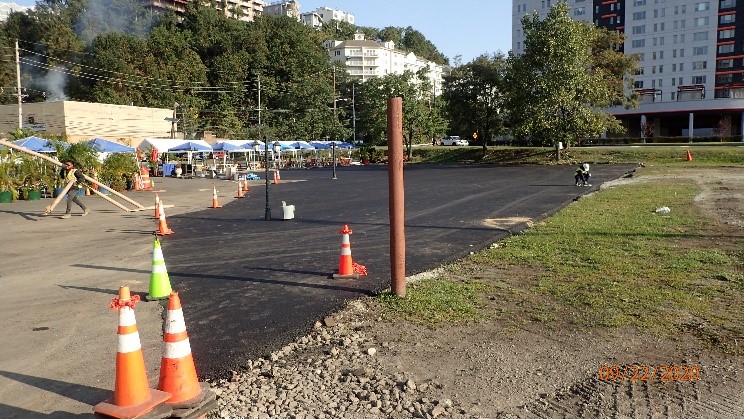

December 2017 - iPark Paving
December 2017 - Crushing Operations (with foam)

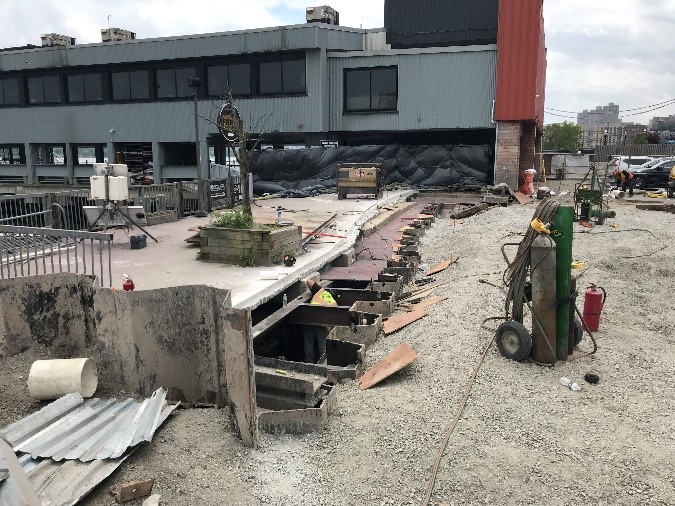

December 2017 - Pier Building Water Line Installation

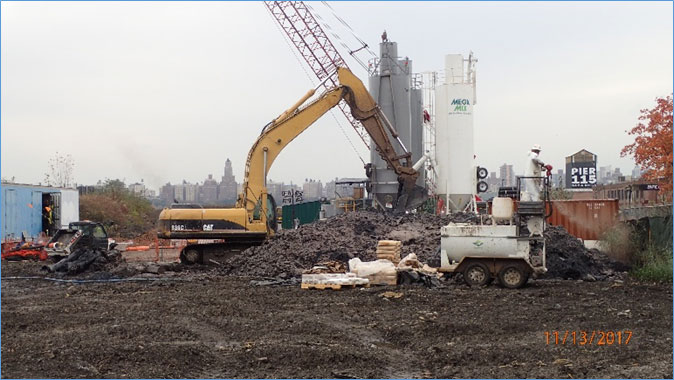

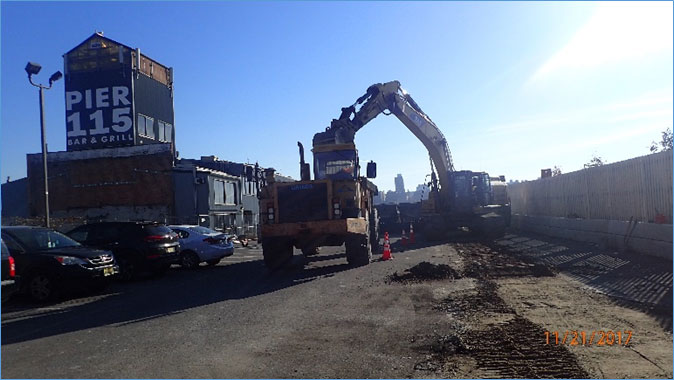

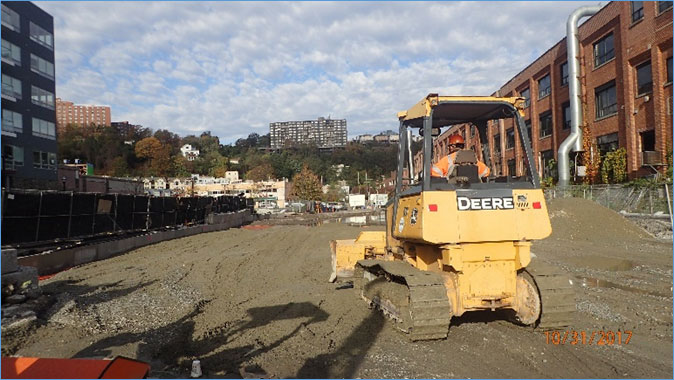

November 2017 - Restoration South of 115 River Road

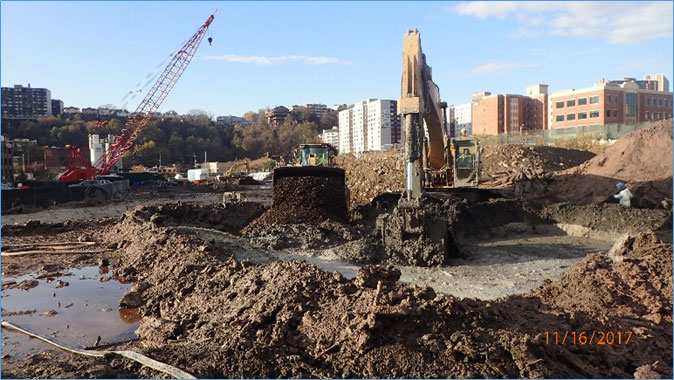

November 2017 - Pier Building Water Line Installation
November 2017 - Paving South of 115 River Road
November 2017 - Pre-Clearing on the Main Quanta Site
November 2017 - ISS on the Main Quanta Site
November 2017 - Posi-Shell Application
November 2017 - Backfilling Activities

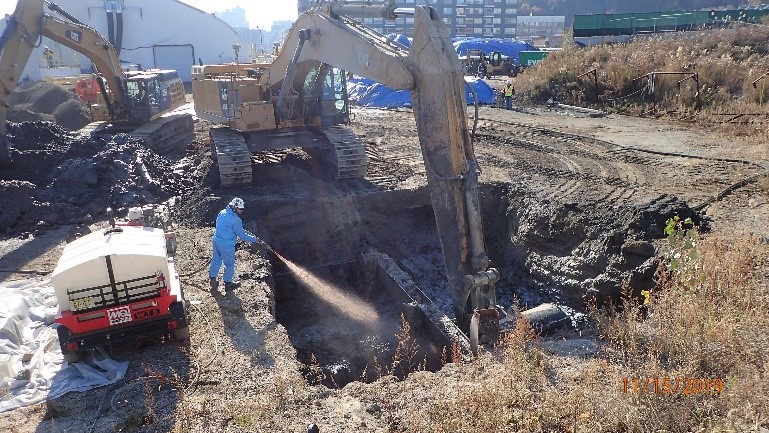

October 2017 - ISS and Pre-Clearing
October 2017 - Restoration and Concrete Removal
October 2017 - Misting System
October 2017 - Crane Staging Location

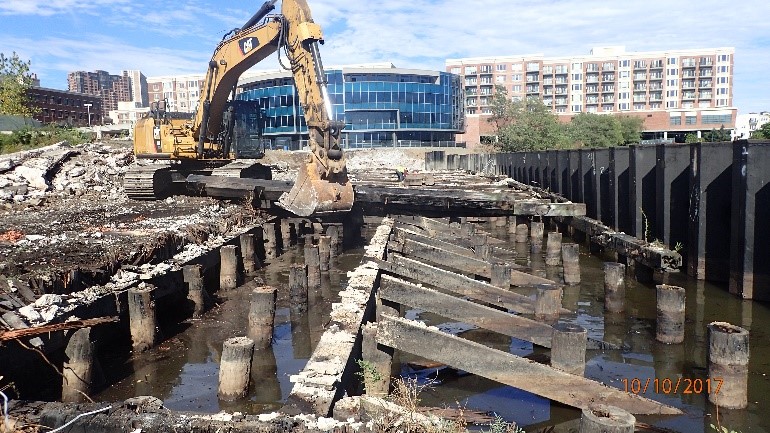

October 2017 - Wharf Removal
October 2017 - Clearing Work
October 2017 - ISS and Posi-Shell Application
October 2017 - Restoration

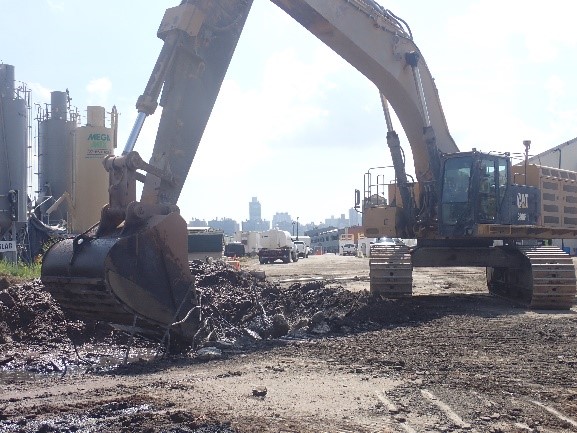

September 2017 - PSE&G gas line work

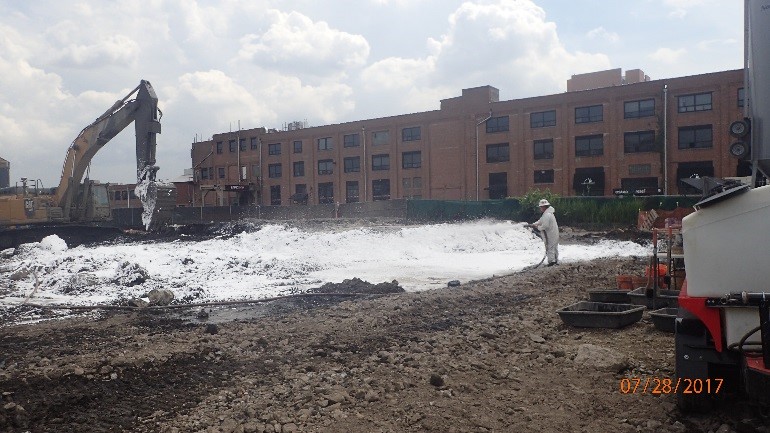

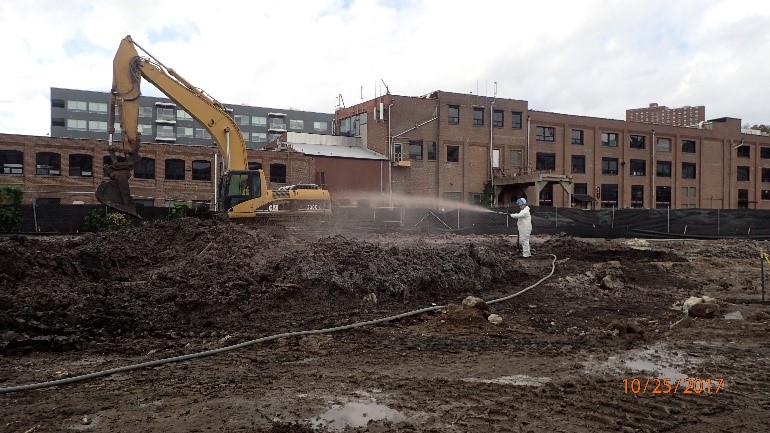

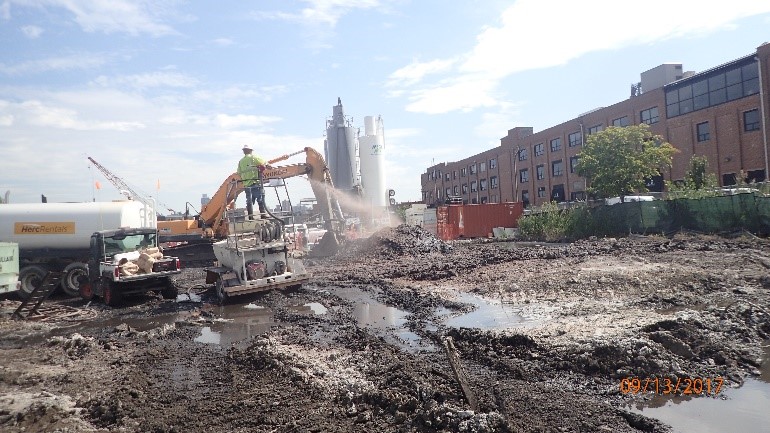

September 2017 - Non-toxic foam applied to exposed soil to help control odors
September 2017 - Re-grading after completion of ISS
September 2017 - Applying a durable, weather-proof, hard shell covering (posi-shell) to exposed soil to help control odors

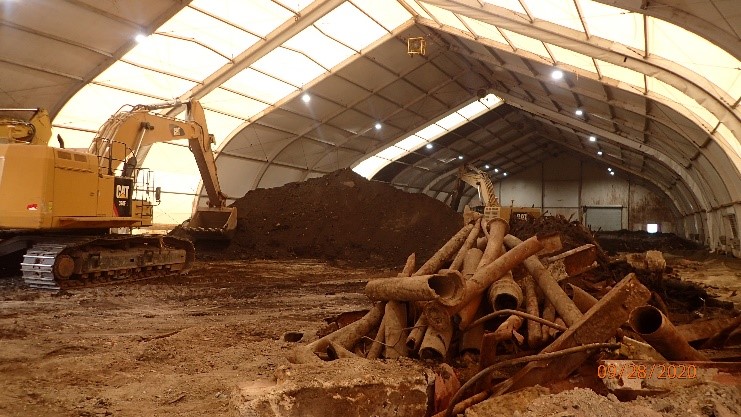

September 2017 - Removing underground debris
September 2017 - Installation of a “clean road” (for construction vehicles that do not contact areas of contamination)
September 2017 - Stockpile management
August 2017 - Removing concrete

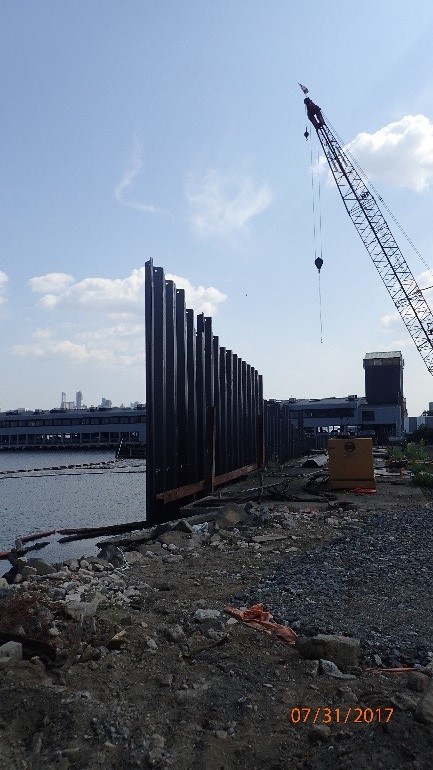

August 2017 - Installation of steel sheetpile bulkhead outboard of main Quanta property

August 2017 - Completion of walkway on the south side of 115 River Road for visitors to the Pier 115 restaurant
July 2017 - Preparation of Block 93 for remediation

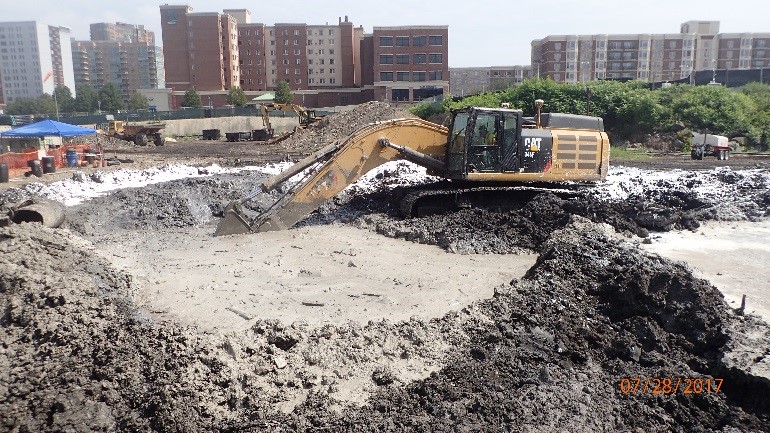

July 2017 - ISS of soils on Block 93
July 2017 - Preparation of area south of 115 River Road Building for remediation

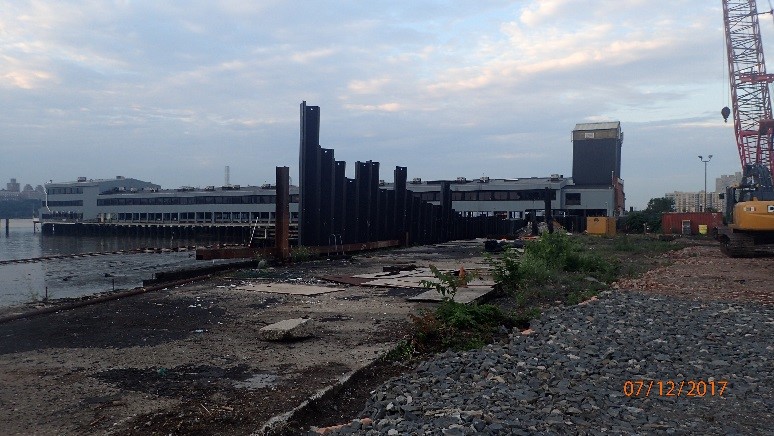

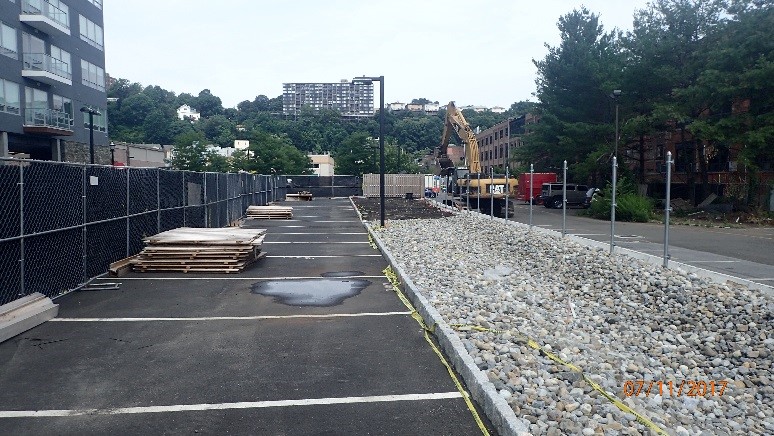

July 2017 - Showing progress of the shoreline bulkhead installation
July 2017 - Bracing installed on west wall of pier 115
July 2017 - Repairs and striping of parking lot on north side of 115 River Road building
July 2017 - Relocation of the batch plant to the east side of River Road
July 2017 - Completion of access road from north to south of 115 River Road for parking
July 2017 - Looking at excavators and batch plant on main Quanta property
July 2017 - Applying foam for odor suppression on the main Quanta
July 2017 - Stockpile of soil
July 2017 - ISS mixing activities on the main Quanta property
July 2017 - Opening of access road from north to south of 115 River Road building
July 2017 - Management of concrete on the main Quanta property
July 2017 - Restoring portions of Block 93
July 2017 - Cutting off sheet piles to appropriate elevation outboard of main Quanta property
July 2017 - Installation of steel sheetpile bulkhead outboard of main Quanta property
July 2017 - ISS activities on the main Quanta property
July 2017 - Applying foam to remediation activities for odor suppression on main Quanta property
July 2017 - Preparing area south of 115 River Road for remediation activities
July 2017 - Progress of steel sheetpile bulkhead

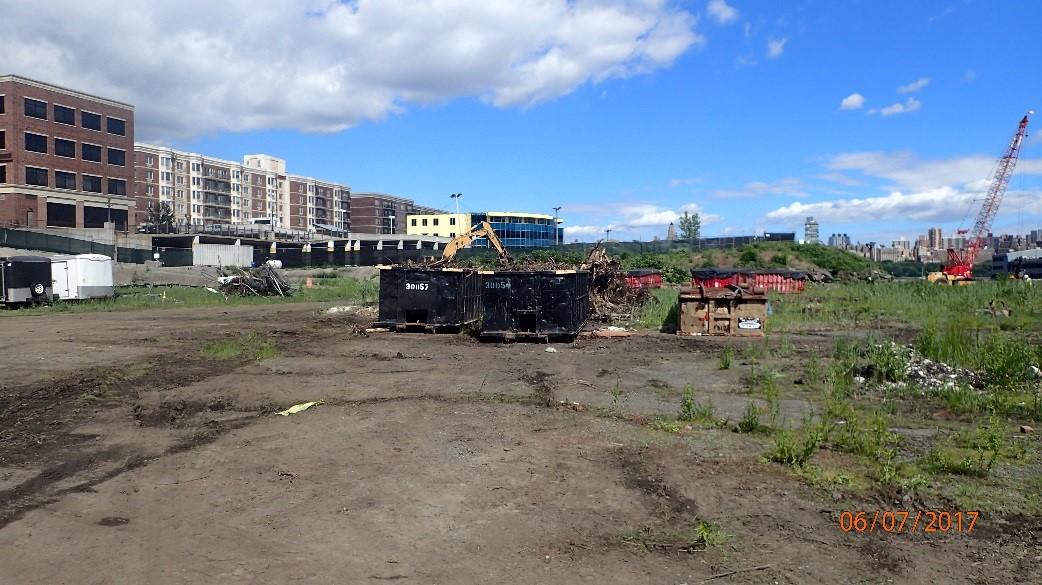

June 2017 - Water quality controls during bulkhead work
June 2017 - Clearing vegetation east of River Road in preparation for ISS
June 2017 - Installing steel bulkhead to protect the river north of the 115 River Road pier
June 2017 - Using a bucket auger to mix concrete and contaminated soils (ISS) west of River Road. Collecting ISS sample
June 2017 - Spraying foam to suppress odors around ISS site west of River Road
June 2017 - Using a bucket auger to mix cement and contaminated soil (ISS) west of River Road
June 2017 - Completed ISS west of River Road
June 2017 - Mixing cement and contaminated soil (ISS) west of River Road and using foam to suppress odors
May 2017 - Constructing a temporary parking lot for the pier building
May 2017 - Covering exposed soils west of River Road with foam to suppress odors

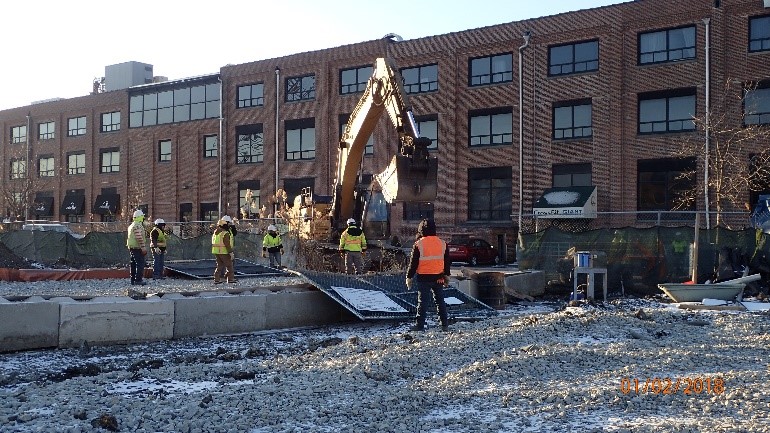

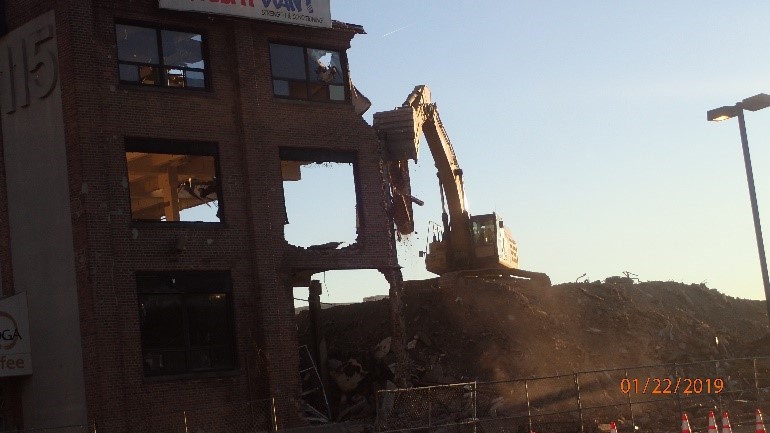

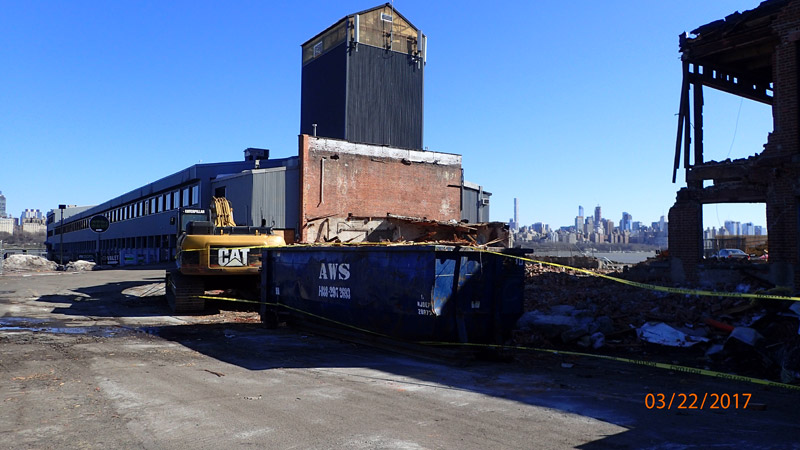

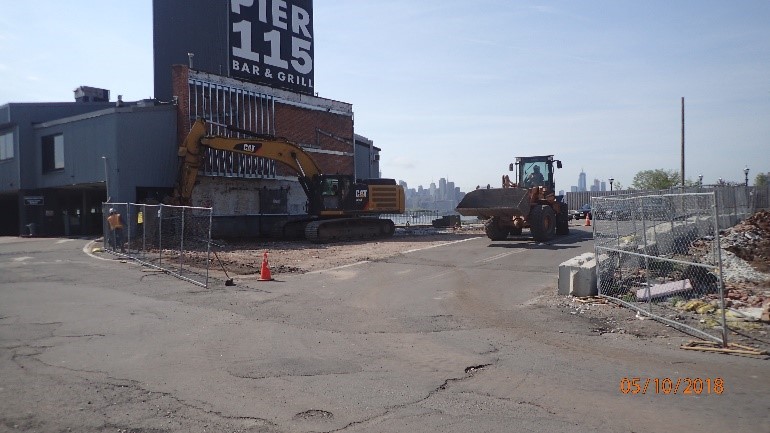

March 2017 - Looking southeast toward the former 115 River Road building after demolition of the first 100-feet of building
March 2017 - Looking southeast toward active demolition of the 115 River Road building in preparation for the OU1 Remedial Action
